All articles →

100 Exercises / Probability Statistics / 100 Exercise Points in Probability & Statistical Marketing Applications

Learning Manufacturing Simulation with Python | 10 Exercises from Monte Carlo to Digital Twins

Simulate factory profit, queues, maintenance, inventory, supply disruptions, and demand in Python to compare costs and operational risks.

Factory Management That Anticipates Fluctuations: 10 Exercise-Down Simulations for Industrial Pump Factories

Use a fictional industrial pump factory to compare ten simulation applications: Monte Carlo profit analysis, process events, interacting maintenance agents, queues, system dynamics, inventory, production lines, supply chains, demand, and a simple digital twin.

Use reproducible experiments to quantify how far profit can fall, where equipment or staffing helps, and how inventory and alternative supply respond to disruption. All data is generated in Python.

Note This material adapts notebooks used in corporate training by Surikobo or its representative, Wayama, and is published with the participating companies’ permission. All datasets are fictional and do not represent actual companies, factories, or results.

Introduction: Practical Challenges in Manufacturing Covered in This Article

The target factory processes, assembles, and inspects standard and high-pressure industrial pumps before shipping them to corporate customers. Demand, processing time, equipment failures, and material delivery times fluctuate daily. Production managers must simultaneously assess not only monthly plans but also daily work-in-progress, material inventory, support personnel, express transportation, and delivery deadline responses to customers.

Simulation is not a tool for predicting the future in a single point. It is a “virtual experiment” that models reality within the scope necessary for decision-making and safely compares measures that have not yet been implemented. In this article, in addition to averages, we gradually incorporate distribution, time sequence, interactions, and feedback into the model.

Common situations on site

  • Although the annual profit is planned to be profitable, the downside cannot be explained by the overlapping of declining demand, material costs, and shutdowns.
  • You know the average operating rate of each piece of equipment, but you don’t know where or how many minutes work in progress will wait.
  • Maintenance staff, workers, transport vehicles, and suppliers make local judgments, making the impact on overall KPIs unclear.
  • Safety stock was uniformly increased, resulting in fewer out-of-stock stocks but higher inventory values and disposal
  • The assumptions for demand forecasting, production planning, and procurement planning differ by department.
  • Digital twins have been introduced, but there is no operational model update based on on-site experience.

A common challenge is Pushing fluctuations and temporal dependencies into average values.

Why is this issue so difficult to judge?

Manufacturing systems are nonlinear. When the operating rate approaches 100%, waiting times increase sharply, and a single missing component can trigger stoppages in subsequent processes. Increasing order volumes reduces stockouts, but increases inventory costs and the risk of obsolescence. Moreover, the main actors on the ground do not share the same information and act according to different rules.

Therefore, average profit or average lead time alone is not enough. This article also lists profit lower quantiles, on-time delivery rate, waiting time, work-in-progress inventory, fulfillment rate, backlog, recovery time, and more, while simultaneously evaluating Expected value, risk, response speed, cost.

Exercise Overview

No.ThemeMain QuestionsMain Outputs
081Monte CarloHow far can profits decline?Profit Distribution, Deficit Probability
082discrete eventWhen jobs are shipped and where to waitEvent Logs, Lead Time
083Agent-basedHow individual maintenance decisions affect the entire populationDowntime rate, preventive maintenance rate
084queueHow many inspectors should be assigned?Wait times and service levels
085System DynamicsHow do orders, capacity, and backlog circulate?Trends in Inventory and Order Backlog
086Inventory SimulationHow to choose ordering policiesFill Rate, Inventory Costs
087Production Line SimulationWhich process should we direct our improvement investments to?Throughput and process utilization rate
088Supply Chain SimulationHow to prepare for supply interruptionsOut-of-stock, total cost, recovery time
089Demand SimulationHow to compare capability proposals in S&OPMonthly Distribution and Excess Probability
090Digital twinHow to update models based on achievementsStatus updates, scenario comparison

Preparing the Python environment

NumPy is used for random numbers and numerical calculations, pandas for representing events and KPIs, and matplotlib for visualization. The random number generator is fixed as a default_rng(SEED + Number) for each purpose, ensuring that rerunning the code yields the same result. All graphs are created using matplotlib.

Run the cells in order in a notebook. Each [IN: n] is paired with its [OUT: n] result. These outputs were checked with Python 3.14.4, NumPy 2.5.1, and pandas 3.0.3. Library versions can affect final digits and display formatting.

Environment and library setup ([IN: 1])
[IN: 1]
import heapq
import platform

import japanize_matplotlib
import matplotlib.pyplot as plt
import numpy as np
import pandas as pd
from IPython.display import display

SEED = 42
pd.set_option("display.max_columns", 20)
pd.set_option("display.float_format", lambda x: f"{x:,.2f}")

print(f"Python: {platform.python_version()}")
print(f"NumPy: {np.__version__} / pandas: {pd.__version__}")
print(f"random numberseed: {SEED}")
[OUT: 1]
Python: 3.14.4
NumPy: 2.5.1 / pandas: 3.0.3
random numberseed: 42

Creation of Fictional Data

Prepare product and capacity tables for P-100 and P-200. Each exercise simplifies a different aspect of the factory with its own resource counts and processing times. These are separate demonstrations, not one integrated model reading the same master tables throughout.

In practice, you first define whether standard time is net time or margin, whether demand is on the order date or preferred delivery date, and whether out-of-stock results in backlog or lost order. Before the accuracy of the simulation, discrepancies in the meaning of the data can change the conclusion.

Synthetic-data setup code ([IN: 2])
[IN: 2]
products = pd.DataFrame(
    {
        "Products": ["P-100 Standard model", "P-200 High Pressure Resistance Type"],
        "average_monthly_demand_platform": [620, 310],
        "sale_price_ten_thousand_yen": [18.0, 27.0],
        "material_cost_ten_thousand_yen": [8.2, 12.5],
        "processing_minutes": [18, 26],
        "assembly_minutes": [22, 34],
        "inspection_minutes": [14, 24],
    }
).set_index("Products")

resources = pd.DataFrame(
    {
        "Process": ["processing", "assembly", "inspection"],
        "Facilities and Number of Personnel": [2, 3, 2],
        "net_daily_time_minutes": [450, 450, 450],
        "coefficient_of_variation": [0.18, 0.12, 0.22],
    }
).set_index("Process")

print("Product Master")
display(products)
print("Process Capability Master")
display(resources)
[OUT: 2]
Product Master
average_monthly_demand_platform sale_price_ten_thousand_yen material_cost_ten_thousand_yen processing_minutes assembly_minutes inspection_minutes
Products
P-100 Standard model 620 18.00 8.20 18 22 14
P-200 High Pressure Resistance Type 310 27.00 12.50 26 34 24
Process Capability Master
Facilities and Number of Personnel net_daily_time_minutes coefficient_of_variation
Process
processing 2 450 0.18
assembly 3 450 0.12
inspection 2 450 0.22

No.081: Monte Carlo — Measuring the Downside of Annual Profits by Probability

Practical Purpose

If you set the budget’s sales, material unit price, and downtime into one point, the planned profit is determined as one. However, in management decisions, not only average profit but also loss amounts in certain cases and probability of losses are necessary. This directly leads to consideration of capital investment quotas, working capital, and long-term contract prices.

Method and Assumptions

Annual profit for scenario ss

Πs=Qs(P−Cm,s−Cv)−F−Cd,s\Pi_s=Q_s(P-C_{m,s}-C_v)-F-C_{d,s}

QQ is sales volume, PP is price, CmC_m is material cost, CvC_v is variable processing cost, FF is fixed cost, CdC_d is stopping loss. Input variables are repeatedly generated from probability distributions, and P(Π<0)P(\Pi<0) and 5% quantiles (profits exceeding 95% of cases) are evaluated.

Check with Python

[IN: 3]
mc_rng = np.random.default_rng(SEED + 81)
n_mc = 20_000
annual_demand = np.maximum(0, mc_rng.normal(11_200, 1_250, n_mc))
material_cost = mc_rng.triangular(9.2, 10.0, 12.4, n_mc)  # 10,000 yen per vehicle
downtime_days = mc_rng.poisson(8, n_mc)
selling_price = 21.2
variable_cost = 3.6
fixed_cost = 73_000
capacity = 11_800
sales = np.minimum(annual_demand, capacity - downtime_days * 28)
profit = (
    sales * (selling_price - material_cost - variable_cost)
    - fixed_cost
    - downtime_days * 55
)

profit_kpi = pd.Series(
    {
        "average_profit_ten_thousand_yen": profit.mean(),
        "interest5th percentile_ten_thousand_yen": np.quantile(profit, 0.05),
        "interest95th percentile_ten_thousand_yen": np.quantile(profit, 0.95),
        "deficit probability": (profit < 0).mean(),
    },
    name="value",
)
display(profit_kpi.to_frame())

fig, ax = plt.subplots(figsize=(8, 3.8))
ax.hist(profit, bins=45, color="#4472C4", edgecolor="white")
ax.axvline(0, color="#C00000", linestyle="--", label="Break-even profit")
ax.axvline(
    np.quantile(profit, 0.05), color="#ED7D31", linestyle=":", label="5th percentile"
)
ax.set_title(

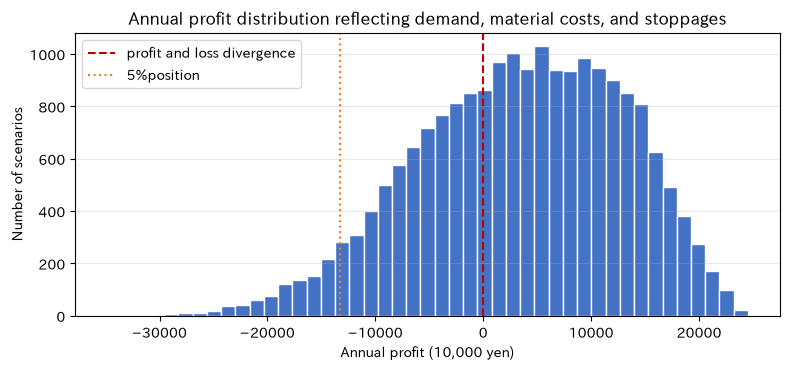

    "Annual profit distribution reflecting demand, material costs, and stoppages"
)
ax.set_xlabel("Annual profit (10,000 yen)")
ax.set_ylabel("Number of scenarios")
ax.grid(axis="y", alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 3]
value
average_profit_ten_thousand_yen 3,384.79
interest5th percentile_ten_thousand_yen -13,233.85
interest95th percentile_ten_thousand_yen 17,770.93
deficit probability 0.36

No.081: Monte Carlo — Measuring the Downside of Annual Profits by Probability: result chart

Interpreting the Results

Even if the average profit is positive, if the distribution is to the left of zero, the risk of losses remains. The 5% percentile is a conservative standard for discussing financial capacity and investment limits. However, the shape of the distribution depends on the input assumption. In practice, we estimate the correlation between demand and material prices, the time lag for price pass-through, and the capability ceiling based on actual results, and also check the conditions for entering deficit scenarios.

No.082: Discrete Event — Recreating Process Competition and Job Waiting

Practical Purpose

After machining is complete, the product proceeds to assembly and waits until equipment becomes available. In systems where the state changes at the point of events such as “arrival” or “processing complete,” discrete event simulation is more efficient than simply tracking the time. It can be used for responding to deadlines, reducing work-in-progress, and considering the order of preparation.

Method and Assumptions

The start and completion times of process kk of Job jj

Sj,k=max⁡(Aj,k,Rk)Cj,k=Sj,k+Pj,k\begin{gathered} S_{j,k}=\max(A_{j,k},R_k)\\ C_{j,k}=S_{j,k}+P_{j,k} \end{gathered}

AA is the arrival of the process, RR is the time when resources become available, and PP is the processing time. Events are processed in priority queues arranged by time, and wait times and lead times are aggregated from the event log.

Check with Python

[IN: 4]
des_rng = np.random.default_rng(SEED + 82)
routes = ["processing", "assembly", "inspection"]
resource_ready = {m: 0.0 for m in routes}
event_queue = []
log = []
n_jobs = 18
arrival_times = np.cumsum(des_rng.exponential(16, n_jobs))

for j, arrival in enumerate(arrival_times):
    heapq.heappush(event_queue, (arrival, j, 0))

while event_queue:
    arrival, job, step = heapq.heappop(event_queue)
    machine = routes[step]
    means = [20, 27, 18]
    duration = des_rng.lognormal(np.log(means[step]), 0.18)
    start = max(arrival, resource_ready[machine])
    finish = start + duration
    resource_ready[machine] = finish
    log.append([job, machine, step + 1, arrival, start, finish, start - arrival])
    if step + 1 < len(routes):
        heapq.heappush(event_queue, (finish, job, step + 1))

event_log = pd.DataFrame(
    log,
    columns=[
        "job",
        "Process",
        "Smooth engineering",
        "Arrival",
        "start",
        "completed",
        "waiting time",
    ],
)
job_kpi = event_log.groupby("job").agg(
    invest=("Arrival", "min"),
    completed=("completed", "max"),
    mass_waiting=("waiting time", "sum"),
)
job_kpi["lead time"] = job_kpi["completed"] - job_kpi["invest"]
display(event_log.head(10))
display(job_kpi.describe().loc[["mean", "50%", "max"]])

fig, ax = plt.subplots(figsize=(8, 3.8))
for i, machine in enumerate(routes):
    part = event_log[event_log["Process"] == machine]
    ax.scatter(
        part["start"], [i] * len(part), s=part["waiting time"] * 5 + 20, label=machine
    )
ax.set_yticks(range(len(routes)), routes)
ax.set_title(

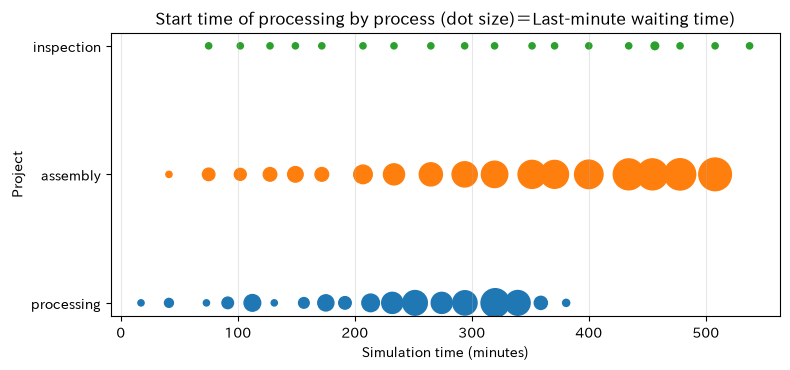

    "Start time of processing by process (dot size)=Last-minute waiting time)"
)
ax.set_xlabel("Simulation time (minutes)")
ax.set_ylabel("Process")
ax.grid(axis="x", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 4]
job Process Smooth engineering Arrival start completed waiting time
0 0 processing 1 17.26 17.26 41.15 0.00
1 1 processing 1 36.88 41.15 62.93 4.27
2 0 assembly 2 41.15 41.15 75.09 0.00
3 1 assembly 2 62.93 75.09 102.12 12.16
4 2 processing 1 73.18 73.18 91.40 0.00
5 0 inspection 3 75.09 75.09 93.83 0.00
6 3 processing 1 81.55 91.40 112.45 9.85
7 4 processing 1 87.67 112.45 128.27 24.78
8 2 assembly 2 91.40 102.12 127.52 10.72
9 1 inspection 3 102.12 102.12 117.42 0.00
invest completed mass_waiting lead time
mean 177.21 322.24 79.07 145.04
50% 182.37 325.33 77.44 144.69
max 379.36 555.73 176.19 233.52

No.082: Discrete Event — Recreating Process Competition and Job Waiting: result chart

Interpreting the Results

Even within the same standard time, lead times for each job vary depending on the overlapping arrivals. Processes or times with large points are places where waiting has accumulated. We look not only at the average waiting time but also at the maximum value and job breakdown to create candidates for increases, priority orders, and lot splits. The production model adds events such as multiple equipment breakdowns, scheduling, breaks, and adjustments.

No.083: Agent-Based — Capturing Local Decisions and Equipment Behavior by Security Personnel

Practical Purpose

The condition of deterioration varies by equipment, and the maintenance staff patrol for limited time. The interaction where each facility issues alerts and the maintenance team determines priorities is a problem that is difficult to express with aggregation alone. It can be used to design preventive maintenance rules, patrol capabilities, and alarm thresholds.

Method and Assumptions

Each piece of equipment is designated as an agent with a status hi(t)∈[0,1]h_i(t)\in[0,1], and each quarter di(t)d_i(t) deterioration and recovery ri(t)r_i(t) through maintenance.

hi(t+1)=min⁡{1,max⁡[0,hi(t)−di(t)+ri(t)]}h_i(t+1)=\min\{1,\max[0,h_i(t)-d_i(t)+r_i(t)]\}

After deterioration, the code counts health at or below 0.12 as failure and repairs it to 0.58. It then preventively maintains at most one nonfailed asset per day, choosing the lowest health below the threshold. Corrective-repair staffing constraints are omitted.

Check with Python

[IN: 5]
def run_agents(threshold, seed, days=120, n_machines=18):
    agent_rng = np.random.default_rng(seed)
    health = agent_rng.uniform(0.65, 1.0, n_machines)
    failures = maintenance = lost_hours = 0
    history = []
    for day in range(days):
        health -= agent_rng.gamma(shape=2.0, scale=0.015, size=n_machines)
        failed = health <= 0.12
        failures += failed.sum()
        lost_hours += failed.sum() * 7.5
        health[failed] = 0.58  # Post-event repair
        targets = np.where((health < threshold) & (~failed))[0]
        targets = targets[np.argsort(health[targets])][:1]
        maintenance += len(targets)
        lost_hours += len(targets) * 1.2
        health[targets] = np.minimum(1.0, health[targets] + 0.38)
        history.append([day, health.mean(), failures, maintenance])
    return (
        failures,
        maintenance,
        lost_hours,
        pd.DataFrame(
            history,
            columns=[
                "days",
                "average health",
                "cumulative fault",
                "Cumulative preventive maintenance",
            ],
        ),
    )

agent_rows = []
histories = {}
for threshold in [0.30, 0.45, 0.60]:
    # Comparing only the maintenance rules with the same degraded random number (common random number method)
    f, m, lost, hist = run_agents(threshold, SEED + 83)
    agent_rows.append([threshold, f, m, lost])
    histories[threshold] = hist
agent_result = pd.DataFrame(
    agent_rows,
    columns=[
        "Maintenance threshold",
        "Number of Failures",
        "Number of preventive maintenance cases",
        "Stop conversion time",
    ],
)
display(agent_result)

fig, ax = plt.subplots(figsize=(8, 3.8))
for threshold, hist in histories.items():
    ax.plot(hist["days"], hist["average health"], label=f"threshold {threshold:.2f}")

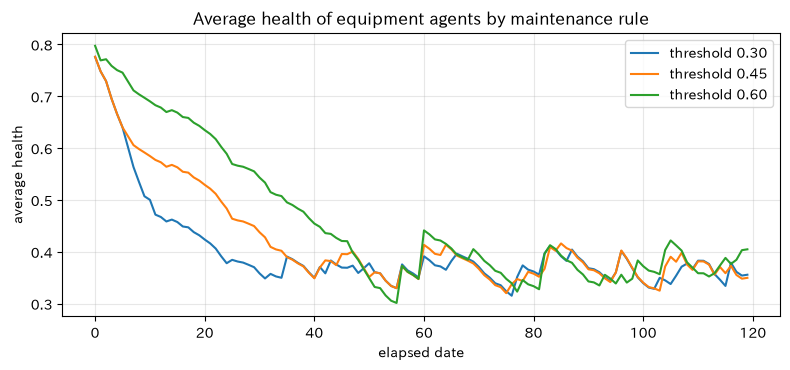

ax.set_title("Average health of equipment agents by maintenance rule")
ax.set_xlabel("Elapsed days")
ax.set_ylabel("average health")
ax.grid(alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 5]
Maintenance threshold Number of Failures Number of preventive maintenance cases Stop conversion time
0 0.30 32 109 370.80
1 0.45 28 114 346.80
2 0.60 26 119 337.80

No.083: Agent-Based — Capturing Local Decisions and Equipment Behavior by Security Personnel: result chart

Interpreting the Results

A high threshold increases early preventive maintenance, suppressing failures while increasing planned downtime. Evaluations are conducted not only by the number of failures but also by the equivalent downtime time and maintenance costs. Since results fluctuate probabilistically, each rule is traditionally iterated across multiple seeds. In practice, equipment importance, parts inventory, maintenance staff’s skills, and priority rules for simultaneous failures are also considered agent attributes.

No.084: Queue — Determining the Number of Final Inspection Personnel Based on Service Level

Practical Purpose

Irregular arrivals can create queues even with spare average capacity. Compare waits until inspection starts and the fraction starting within ten minutes. Time until completion additionally includes service time.

Method and Assumptions

If we set the arrival rate as λ\lambda, the processing rate per person as μ\mu, and the number of counters as cc, then the usage rate is

ρ=λcμ\rho=\frac{\lambda}{c\mu}

For ρ≥1\rho\ge1, the standard M/M/c queue has no stationary waiting-time distribution. Here arrivals are Poisson and service times exponential. Simulate inspection and compare mean waiting time and the share starting within ten minutes.

Check with Python

[IN: 6]
def simulate_queue(servers, seed, n=3000, arrival_rate=5.2, service_rate=3.0):
    queue_rng = np.random.default_rng(seed)
    arrivals = np.cumsum(queue_rng.exponential(60 / arrival_rate, n))
    service = queue_rng.exponential(60 / service_rate, n)
    ready = np.zeros(servers)
    waits = np.zeros(n)
    for i, (arrival, duration) in enumerate(zip(arrivals, service)):
        k = np.argmin(ready)
        start = max(arrival, ready[k])
        waits[i] = start - arrival
        ready[k] = start + duration
    return waits

queue_rows = []
queue_samples = {}
for c in [2, 3, 4]:
    waits = simulate_queue(c, SEED + 840 + c)
    queue_samples[c] = waits
    queue_rows.append(
        [
            c,
            5.2 / (c * 3.0),
            waits.mean(),
            np.quantile(waits, 0.95),
            (waits <= 10).mean(),
        ]
    )
queue_result = pd.DataFrame(
    queue_rows,
    columns=[
        "Number of Inspectors",
        "utilization rate",
        "average_waiting_time_minutes",
        "wait95%quantile",
        "Fraction starting within 10 minutes",
    ],
)
display(queue_result)

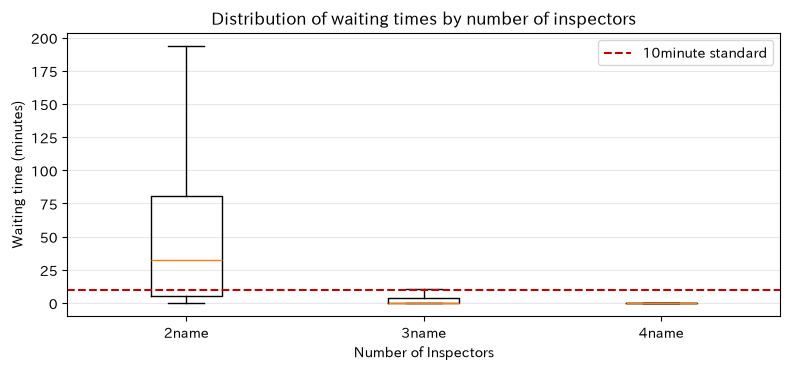

fig, ax = plt.subplots(figsize=(8, 3.8))
ax.boxplot(
    [queue_samples[c] for c in [2, 3, 4]],
    tick_labels=["2name", "3name", "4name"],
    showfliers=False,
)
ax.axhline(10, color="#C00000", linestyle="--", label="10-minute target")
ax.set_title("Distribution of waiting times by number of inspectors")
ax.set_xlabel("Number of Inspectors")
ax.set_ylabel("Waiting time (minutes)")
ax.grid(axis="y", alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 6]
Number of Inspectors utilization rate average_waiting_time_minutes wait95%quantile Fraction starting within 10 minutes
0 2 0.87 48.88 156.23 0.31
1 3 0.58 5.24 29.70 0.82
2 4 0.43 1.08 8.09 0.97

No.084: Queue — Determining the Number of Final Inspection Personnel Based on Service Level: result chart

Interpreting the Results

For proposals with high usage rates, the upper end of the waiting time will be significantly longer. Instead of just looking at average wait times, we link the start rate to the 95% or within 10 minutes to the shipping deadline. If the improvement in the four-person proposal is small, support during busy hours rather than constant staff increases is a good option. If the arrival is in lots and processing times are by product, the actual distribution is directly resampled.

No.085: System Dynamics — Viewing Backlog and Ability Adjustment Feedback

Practical Purpose

As orders increase, the backlog builds up, and overtime and support work boost shipping capacity. However, capacity adjustment is delayed, and if you increase it too much, inventory can balloon, which can lead to a reduction in the process. It can be used to align the timelines for S&OP, workforce planning, and production increase decisions.

Method and Assumptions

Inventory ItI_t and BtB_t backorders are stocked, production and shipping are the flow, and daily difference equations are used.

It+1=It+Pt−StBt+1=Bt+Dt−St\begin{gathered} I_{t+1}=I_t+P_t-S_t\\ B_{t+1}=B_t+D_t-S_t \end{gathered}

Ability CtC_t reacts to the difference from the target backlog but moves later due to the adjustment coefficient. Compare sudden and smooth responses.

Check with Python

[IN: 7]
def system_dynamics(adjustment, days=120):
    demand = np.full(days, 42.0)
    demand[25:65] = 58.0
    inventory = np.zeros(days)
    backlog = np.zeros(days)
    capacity = np.zeros(days)
    shipment = np.zeros(days)
    inventory[0], backlog[0], capacity[0] = 90, 10, 44
    for t in range(days - 1):
        production = capacity[t]
        shipment[t] = min(inventory[t] + production, demand[t] + backlog[t])
        inventory[t + 1] = max(0, inventory[t] + production - shipment[t])
        backlog[t + 1] = max(0, backlog[t] + demand[t] - shipment[t])
        target_capacity = 44 + 0.22 * (backlog[t] - 20) - 0.08 * (inventory[t] - 80)
        capacity[t + 1] = np.clip(
            capacity[t] + adjustment * (target_capacity - capacity[t]), 30, 70
        )
    return pd.DataFrame(
        {
            "days": np.arange(days),
            "need": demand,
            "Inventory": inventory,
            "Backlog": backlog,
            "ability": capacity,
        }
    )

fast_sd = system_dynamics(0.55)
smooth_sd = system_dynamics(0.12)
sd_kpi = pd.DataFrame(
    {
        "adjustment policy": ["Sudden reaction", "smooth reaction"],
        "Maximum Order Backlog": [
            fast_sd["Backlog"].max(),
            smooth_sd["Backlog"].max(),
        ],
        "Maximum inventory": [fast_sd["Inventory"].max(), smooth_sd["Inventory"].max()],
        "Maximum daily capacity changes": [
            fast_sd["ability"].diff().abs().max(),
            smooth_sd["ability"].diff().abs().max(),
        ],
    }
)
display(sd_kpi)

fig, axes = plt.subplots(1, 2, figsize=(10, 3.8), sharey=True)
for ax, df, title in zip(
    axes, [fast_sd, smooth_sd], ["Sudden reaction", "smooth reaction"]
):
    ax.plot(df["days"], df["Inventory"], label="Finished goods inventory")
    ax.plot(df["days"], df["Backlog"], label="Backlog")
    ax.set_title(f"Capacity adjustment:{title}")
    ax.set_xlabel("days")
    ax.set_ylabel("Units")
    ax.grid(alpha=0.3)
    ax.legend()
plt.tight_layout()
plt.show()
[OUT: 7]
adjustment policy Maximum Order Backlog Maximum inventory Maximum daily capacity changes
0 Sudden reaction 58.05 90.00 2.97
1 smooth reaction 110.36 91.40 1.86

No.085: System Dynamics — Viewing Backlog and Ability Adjustment Feedback: result chart

Interpreting the Results

Maximum backlog is about 58 units under fast adjustment and 110 under smoothing, while fast adjustment needs larger daily capacity changes. Inventory swings depend on parameters; inspect the trajectories and maxima. Compare late-delivery, staffing-change, and inventory costs.

No.086: Inventory Simulation — Comparing Reorder Points and Order Quantities by Cost and Fulfillment Rate

Practical Purpose

Shortages of key seal parts halt the line, but excess inventory locks in funds and increases waste during design changes. In an environment where demand and procurement lead times fluctuate, it is necessary not only to calculate averages but also to reproduce ordering policies as daily operations.

Method and Assumptions

For a (Q,R)(Q,R) policy, inventory position is on-hand stock plus outstanding purchase orders minus customer backorders. Order lots of QQ until the position exceeds RR. Daily cost is

C=hI+bU+KNorderC=hI+bU+K N_{\mathrm{order}}

II is end-of-day stock, UU end-of-day backlog, hh holding cost per unit-day, bb delay cost per backlogged unit-day, and KK cost per order. NorderN_{\mathrm{order}} is the number of orders placed that day. Immediate fill rate counts today’s demand served today after older backorders. Compare three policies with the same demand and lead-time paths.

Check with Python

Simulation function and execution code ([IN: 8])
[IN: 8]
def inventory_sim(R, Q, seed, days=365):
    inv_rng = np.random.default_rng(seed)
    demand = inv_rng.poisson(18, days)
    lead_times = inv_rng.integers(3, 9, days)
    on_hand, backlog = 130, 0
    pipeline = []
    total_demand = filled = holding = shortage = order_count = 0
    history = []
    for day in range(days):
        arrivals = sum(q for due, q in pipeline if due == day)
        pipeline = [(due, q) for due, q in pipeline if due > day]
        on_hand += arrivals
        requested = backlog + demand[day]
        shipped = min(on_hand, requested)
        on_hand -= shipped
        backlog = requested - shipped
        total_demand += demand[day]
        filled += min(demand[day], max(0, shipped - max(0, requested - demand[day])))
        inventory_position = on_hand + sum(q for _, q in pipeline) - backlog
        while inventory_position <= R:
            pipeline.append((day + int(lead_times[day]), Q))
            order_count += 1
            inventory_position += Q
        holding += on_hand
        shortage += backlog
        history.append([day, on_hand, backlog, inventory_position])
    cost = holding * 35 + shortage * 1200 + order_count * 2500
    return (
        filled / total_demand,
        cost,
        np.mean([x[1] for x in history]),
        pd.DataFrame(
            history,
            columns=[
                "days",
                "Inventory on hand",
                "Backlog",
                "Inventory position",
            ],
        ),
    )

policies = [(70, 120), (100, 140), (140, 180)]
inv_rows, inv_hist = [], {}
for R, Q in policies:
    fill, cost, avg_inv, hist = inventory_sim(R, Q, SEED + 86)
    name = f"R={R }, Q={Q }"
    inv_rows.append([name, fill, avg_inv, cost])
    inv_hist[name] = hist
inventory_result = pd.DataFrame(
    inv_rows,
    columns=[
        "Policy",
        "Immediate Payment Satisfaction Rate",
        "Average Inventory Holding",
        "annual_related_expenses_yen",
    ],
)
display(inventory_result)

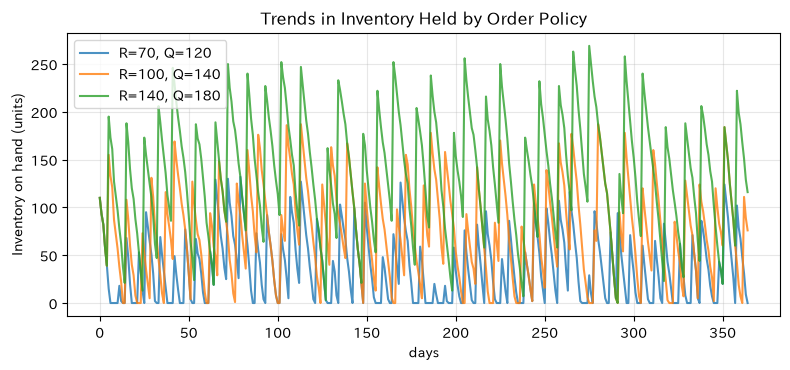

fig, ax = plt.subplots(figsize=(8, 3.8))
for name, hist in inv_hist.items():
    ax.plot(hist["days"], hist["Inventory on hand"], label=name, alpha=0.8)
ax.set_title("Trends in Inventory Held by Order Policy")
ax.set_xlabel("days")
ax.set_ylabel("Inventory on hand (units)")
ax.grid(alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 8]
Policy Immediate Payment Satisfaction Rate Average Inventory Holding annual_related_expenses_yen
0 R=70, Q=120 0.78 35.92 3951485
1 R=100, Q=140 0.94 75.34 1807165
2 R=140, Q=180 1.00 135.67 1856865

No.086: Inventory Simulation — Comparing Reorder Points and Order Quantities by Cost and Fulfillment Rate: result chart

Interpreting the Results

Increasing reorder points and quantity makes it easier to reduce stockouts, while also increasing average inventory and storage costs. First, check whether the minimum cost plan meets the company’s target fulfillment rate, and if it does not meet it, choose policies based on service level constraints. In practice, we also include lot constraints, holiday calendars, remaining orders, minimum order quantities, and replacement parts in case of shortages.

No.087: Production Line Simulation — Comparing Bottleneck Improvement Proposals

Practical Purpose

An upstream stoppage can leave downstream machines idle, while a downstream bottleneck increases work in progress. Simulate the whole line when comparing extra equipment, shorter cycle times, and preventive maintenance.

Method and Assumptions

Sequence of the three series processes in order of job completion

Cj,k=max⁡(Cj−1,k,Cj,k−1)+Pj,kC_{j,k}=\max(C_{j-1,k},C_{j,k-1})+P_{j,k}

Generate lognormal processing times and add failure downtime. Despite its name, means specifies medians. Compare baseline, 10% faster assembly, and 15% faster inspection with common random numbers. Each stage has one machine and an unlimited buffer. Utilization includes processing and downtime, rather than productive time alone.

Check with Python

[IN: 9]
def line_sim(scenario, seed, jobs=240):
    line_rng = np.random.default_rng(seed)
    means = np.array([18.0, 25.0, 21.0])
    if scenario == "assembly10%Abbreviation":
        means[1] *= 0.90
    if scenario == "inspection15%Abbreviation":
        means[2] *= 0.85
    durations = line_rng.lognormal(np.log(means), [0.18, 0.14, 0.22], size=(jobs, 3))
    failures = line_rng.random((jobs, 3)) < [0.025, 0.015, 0.035]
    durations += failures * line_rng.uniform(20, 55, size=(jobs, 3))
    completion = np.zeros((jobs, 3))
    busy = durations.sum(axis=0)
    for j in range(jobs):
        for k in range(3):
            prev_job = completion[j - 1, k] if j else 0
            prev_stage = completion[j, k - 1] if k else 0
            completion[j, k] = max(prev_job, prev_stage) + durations[j, k]
    makespan = completion[-1, -1]
    return makespan, jobs / (makespan / 450), busy / makespan, completion

line_rows = []
line_completion = {}
for scenario in ["standard", "assembly10%Abbreviation", "inspection15%Abbreviation"]:
    makespan, daily, utilization, completion = line_sim(scenario, SEED + 87)
    line_rows.append([scenario, makespan, daily, *utilization])
    line_completion[scenario] = completion
line_result = pd.DataFrame(
    line_rows,
    columns=[
        "Scenario",
        "completion_time_minutes",
        "nissan_equivalent_platform",
        "Processing utilization rate",
        "Assembly Utilization Rate",
        "Test utilization rate",
    ],
)
display(line_result)

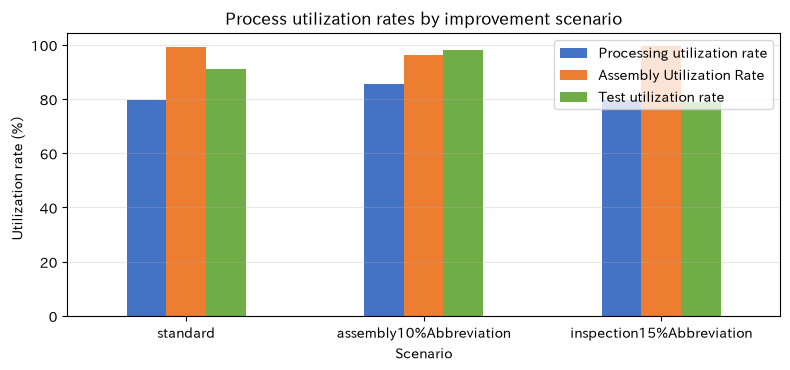

fig, ax = plt.subplots(figsize=(8, 3.8))
plot_data = (
    line_result.set_index("Scenario")[
        [
            "Processing utilization rate",
            "Assembly Utilization Rate",
            "Test utilization rate",
        ]
    ]
    * 100
)
plot_data.plot.bar(ax=ax, color=["#4472C4", "#ED7D31", "#70AD47"], rot=0)
ax.set_title("Process utilization rates by improvement scenario")
ax.set_xlabel("Scenario")
ax.set_ylabel("Utilization rate (%)")
ax.grid(axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 9]
Scenario completion_time_minutes nissan_equivalent_platform Processing utilization rate Assembly Utilization Rate Test utilization rate
0 standard 6,127.66 17.62 0.80 0.99 0.91
1 assembly10%Abbreviation 5,698.83 18.95 0.86 0.96 0.98
2 inspection15%Abbreviation 6,124.45 17.63 0.80 0.99 0.79

No.087: Production Line Simulation — Comparing Bottleneck Improvement Proposals: result chart

Interpreting the Results

The cycle shortening rate and the daily improvement rate do not match. Even if you improve anything other than the constrained process, the effect on the overall completion time is limited. While considering processes with high utilization rates as candidates for improvement, we also check for long stoppages due to breakdowns and work-in-progress between processes. In investment decisions, the average and downward percentiles of multiple iterations are compared with the cost per unit per additional production unit.

No.088: Supply Chain Simulation — Choosing Buffers for Supply Disruptions

Practical Purpose

Supplier stoppages for key components can cause factory shortages after a few days’ delay, further affecting customer delivery deadlines. Safety stock, alternative procurement, and express shipping enhance resilience but come with peacetime costs. You can use BCP not just to be safe, but to compare out-of-stock ratios and costs.

Method and Assumptions

Track scheduled arrivals and suspend new regular orders on days 55–71, while allowing orders in transit to arrive as planned. Share demand and regular lead-time paths across policies. Over 180 days, compare immediate fill rate, maximum backlog, holding cost, cumulative delay cost, expedited purchasing, and recovery time. Delay costs 1,800 yen per backlogged unit-day.

Check with Python

Simulation function and execution code ([IN: 10])
[IN: 10]
def supply_chain_sim(policy, seed, days=180):
    sc_rng = np.random.default_rng(seed)
    # Pre-generate common demand and lead-time paths for both policies.
    demand_path = sc_rng.poisson(42, days)
    lead_time_path = sc_rng.integers(5, 10, days)
    on_hand, backlog = 280, 0
    pipeline = []
    total_demand = immediate_total = holding = expedite = 0
    max_backlog = 0
    backlog_days = 0
    history = []
    R, Q = (180, 260) if policy == "Standard" else (280, 320)
    for day in range(days):
        arrivals = sum(q for due, q in pipeline if due == day)
        pipeline = [(due, q) for due, q in pipeline if due > day]
        on_hand += arrivals
        demand = int(demand_path[day])
        total_demand += demand
        old_backlog = backlog
        immediate_total += min(demand, max(0, on_hand - old_backlog))
        requested = old_backlog + demand
        shipped = min(on_hand, requested)
        on_hand -= shipped
        backlog = requested - shipped
        inventory_position = on_hand + sum(q for _, q in pipeline) - backlog
        disruption = 55 <= day < 72
        if inventory_position <= R and not disruption:
            pipeline.append((day + int(lead_time_path[day]), Q))
        if policy == "BCPCountermeasures" and backlog > 80:
            emergency = min(120, backlog)
            pipeline.append((day + 2, emergency))
            expedite += emergency
        holding += on_hand
        backlog_days += backlog
        max_backlog = max(max_backlog, backlog)
        history.append([day, on_hand, backlog])
    cost = holding * 28 + backlog_days * 1800 + expedite * 650
    hist = pd.DataFrame(
        history, columns=["days", "factory inventory", "Backlog"]
    )
    after = hist.loc[hist["days"] >= 72]
    recovered = after.loc[after["Backlog"] <= 5, "days"]
    recovery_days = (recovered.iloc[0] - 72) if len(recovered) else np.nan
    return immediate_total / total_demand, max_backlog, cost, recovery_days, hist

sc_rows, sc_hist = [], {}
for policy in ["Standard", "BCPCountermeasures"]:
    fill, max_b, cost, recovery, hist = supply_chain_sim(policy, SEED + 88)
    sc_rows.append([policy, fill, max_b, cost, recovery])
    sc_hist[policy] = hist
supply_result = pd.DataFrame(
    sc_rows,
    columns=[
        "Policy",
        "Immediate Payment Satisfaction Rate",
        "Maximum Order Backlog",
        "total_cost_yen",
        "Days to recover after interruption",
    ],
)
display(supply_result)

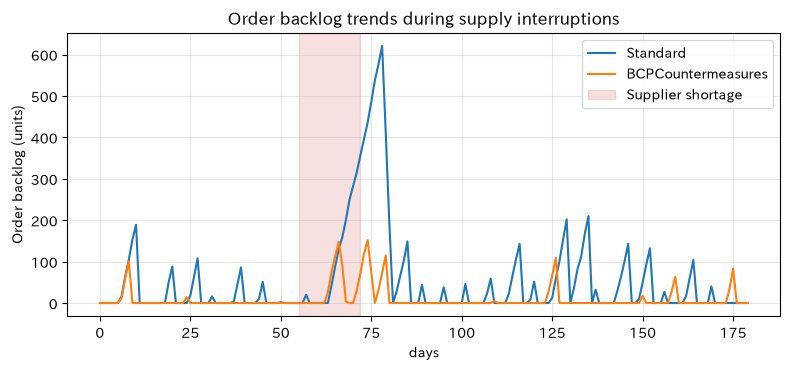

fig, ax = plt.subplots(figsize=(8, 3.8))
for policy, hist in sc_hist.items():
    ax.plot(hist["days"], hist["Backlog"], label=policy)
ax.axvspan(55, 72, color="#C00000", alpha=0.12, label="Supplier disruption")
ax.set_title("Order backlog trends during supply interruptions")
ax.set_xlabel("days")
ax.set_ylabel("Order backlog (units)")
ax.grid(alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 10]
Policy Immediate Payment Satisfaction Rate Maximum Order Backlog total_cost_yen Days to recover after interruption
0 Standard 0.56 591 20831772 15
1 BCPCountermeasures 0.89 164 3271194 2

No.088: Supply Chain Simulation — Choosing Buffers for Supply Disruptions: result chart

Interpreting the Results

Check how buffer stock and expedited purchasing change backlog and recovery time. Costs accumulate over 180 days; final-day backlog alone does not measure delay losses. Repeat the comparison for different penalties, disruption starts, durations, and simultaneous supplier failures.

No.089: Demand Simulation — Comparing S&OP Capability Proposals with Probabilism

Practical Purpose

Even if the sales forecast is 1,000 units per month, performance fluctuates depending on promotional effects, seasonality, and the number of large projects. Matching capacity to the forecast average increases overtime and out-of-stock during busy months. S&OP uses demand scenarios and agrees on combinations of usual capability, overtime, and outsourcing.

Method and Assumptions

Demand for tt months

Dt=(L+Tt)St+Mt+εtD_t=(L+T_t)S_t+M_t+\varepsilon_t

LL is base demand, TtT_t trend, StS_t seasonality, MtM_t promotions and large orders, and εt\varepsilon_t routine variation. Generate 3,000 annual paths. Monthly exceedance probability is the fraction of all path-months above capacity; annual shortage sums monthly shortfalls without inventory carryover offsets.

Check with Python

[IN: 11]
demand_rng = np.random.default_rng(SEED + 89)
n_paths, months = 3000, 12
season = np.array(
    [0.90, 0.92, 0.98, 1.02, 1.05, 1.08, 0.95, 0.93, 1.00, 1.08, 1.16, 1.22]
)
trend = np.arange(months) * 8
base = (900 + trend) * season
noise = demand_rng.normal(0, 75, size=(n_paths, months))
campaign = (demand_rng.random((n_paths, months)) < 0.16) * demand_rng.normal(
    180, 45, (n_paths, months)
)
large_order = (demand_rng.random((n_paths, months)) < 0.08) * demand_rng.integers(
    180, 380, (n_paths, months)
)
demand_paths = np.maximum(0, base + noise + campaign + large_order)

capacity_options = {
    "Normal Abilities": 1050,
    "Overtime slot": 1180,
    "Including outsourcing quotas": 1320,
}
demand_rows = []
for name, cap in capacity_options.items():
    shortage = np.maximum(0, demand_paths - cap)
    demand_rows.append(
        [
            name,
            cap,
            (demand_paths > cap).mean(),
            shortage.sum(axis=1).mean(),
            np.quantile(shortage.sum(axis=1), 0.95),
        ]
    )
demand_result = pd.DataFrame(
    demand_rows,
    columns=[
        "capability plan",
        "moon_ability_platform",
        "Monthly ability exceeds probability",
        "average_annual_shortfall_platform",
        "annual shortage95th percentile_platform",
    ],
)
display(demand_result)

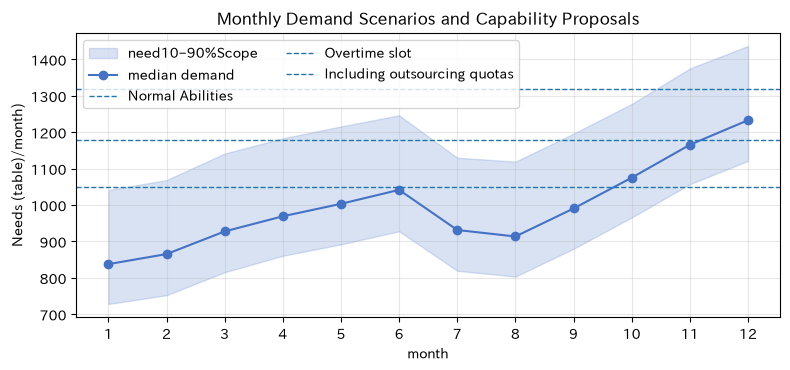

q10, q50, q90 = np.quantile(demand_paths, [0.1, 0.5, 0.9], axis=0)
fig, ax = plt.subplots(figsize=(8, 3.8))
ax.fill_between(
    np.arange(1, 13), q10, q90, color="#4472C4", alpha=0.2, label="10th–90th percentile demand"
)
ax.plot(np.arange(1, 13), q50, color="#4472C4", marker="o", label="median demand")
for name, cap in capacity_options.items():
    ax.axhline(cap, linestyle="--", linewidth=1, label=name)
ax.set_title("Monthly Demand Scenarios and Capability Proposals")
ax.set_xlabel("month")
ax.set_ylabel("Demand (units/month)")
ax.set_xticks(range(1, 13))
ax.grid(alpha=0.3)
ax.legend(ncol=2)
plt.tight_layout()
plt.show()
[OUT: 11]
capability plan moon_ability_platform Monthly ability exceeds probability average_annual_shortfall_platform annual shortage95th percentile_platform
0 Normal Abilities 1050 0.38 670.75 1,188.59
1 Overtime slot 1180 0.18 242.43 613.50
2 Including outsourcing quotas 1320 0.05 65.70 289.95

No.089: Demand Simulation — Comparing S&OP Capability Proposals with Probabilism: result chart

Interpreting the Results

Even if the median is within capacity, there will be shortfalls at the upper end of the demand distribution. Normal capacity is treated as fixed cost, overtime and outsourcing as variable costs, and the probability of overcapacity and the tolerance for shortfall costs are agreed upon. Since promotional and large-scale deals are not pure random numbers but linked to sales activities, scenarios based on project accuracy are set jointly with the sales department and updated monthly.

No.090: Digital Twin — Updating status and proactively evaluating measures at on-site events

Practical Purpose

Digital twins are not just 3D displays themselves; they synchronize the current state of the site with data and compare future scenarios from that state. If standard time remains outdated, even sophisticated models can make mistakes. We update the model based on daily cycle performance and provide the expected completion of the remaining balance for the day.

Method and Assumptions

The estimated cycle time of process kk is achieved exponentially smoothing by the observation yk,ty_{k,t},

μ^k,t=αyk,t+(1−α)μ^k,t−1\hat\mu_{k,t}=\alpha y_{k,t}+(1-\alpha)\hat\mu_{k,t-1}

Update process-time estimates, then approximate completion as remaining quantity times the slowest stage time plus downtime. One random multiplier affects the whole remaining batch; waiting and startup are omitted. Compare baseline, assembly support, and reduced downtime.

Check with Python

[IN: 12]
twin_rng = np.random.default_rng(SEED + 90)
standards = {"processing": 18.0, "assembly": 25.0, "inspection": 21.0}
events = []
for machine, standard in standards.items():
    drift = {"processing": 1.03, "assembly": 1.12, "inspection": 0.98}[machine]
    observed = twin_rng.lognormal(np.log(standard * drift), 0.12, 40)
    events.extend([[machine, i + 1, value] for i, value in enumerate(observed)])
event_data = pd.DataFrame(
    events, columns=["Process", "order of completion", "actual_ct_min"]
)

alpha = 0.20
state_rows = []
for machine, group in event_data.groupby("Process", sort=False):
    estimate = standards[machine]
    for value in group["actual_ct_min"]:
        estimate = alpha * value + (1 - alpha) * estimate
    state_rows.append(
        [machine, standards[machine], estimate, estimate / standards[machine] - 1]
    )
twin_state = pd.DataFrame(
    state_rows,
    columns=[
        "Process",
        "standard_ct_points",
        "update_ct_minutes",
        "standard deviation rate",
    ],
).set_index("Process")
display(twin_state)

def twin_forecast(ct, scenario, seed, remaining=80, reps=3000):
    r = np.random.default_rng(seed)
    adjusted = ct.copy()
    downtime_mean = 38
    if scenario == "Assembly Support":
        adjusted["assembly"] *= 0.88
    if scenario == "Shortened Stop":
        downtime_mean = 22
    bottleneck_ct = max(adjusted.values())
    finish = remaining * r.lognormal(np.log(bottleneck_ct), 0.06, reps) + r.gamma(
        2, downtime_mean / 2, reps
    )
    return finish

ct_now = twin_state["update_ct_minutes"].to_dict()
twin_rows, twin_samples = [], {}
for i, scenario in enumerate(["standard", "Assembly Support", "Shortened Stop"]):
    samples = twin_forecast(ct_now, scenario, SEED + 900 + i)
    twin_samples[scenario] = samples
    twin_rows.append(
        [scenario, samples.mean(), np.quantile(samples, 0.90), (samples <= 2100).mean()]
    )
twin_result = pd.DataFrame(
    twin_rows,
    columns=[
        "Scenario",
        "average_estimated_completion_in_minutes",
        "completed90%quantile",
        "Probability of completion within 2,100 minutes",
    ],
)
display(twin_result)

fig, ax = plt.subplots(figsize=(8, 3.8))
for scenario, samples in twin_samples.items():
    ax.hist(samples, bins=35, alpha=0.35, label=scenario)
ax.axvline(2100, color="#C00000", linestyle="--", label="Delivery Schedule")
ax.set_title("Completion-time scenarios for 80 remaining units")
ax.set_xlabel("Time to Completion (minutes)")
ax.set_ylabel("Number of simulations")
ax.grid(axis="y", alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 12]
standard_ct_points update_ct_minutes standard deviation rate
Process
processing 18.00 18.70 0.04
assembly 25.00 27.68 0.11
inspection 21.00 20.09 -0.04
Scenario average_estimated_completion_in_minutes completed90%quantile Probability of completion within 2,100 minutes
0 standard 2,257.37 2,433.68 0.12
1 Assembly Support 1,987.86 2,138.01 0.83
2 Shortened Stop 2,239.69 2,412.84 0.15

No.090: Digital Twin — Updating status and proactively evaluating measures at on-site events: result chart

Interpreting the Results

A large deviation from standard cycle time is a reason to inspect wear, product mix, or changed work methods. Updated completion probabilities allow a comparison of assembly support and reduced downtime. Monitor forecast errors, sensor faults, and time alignment; retain approval and manual operating procedures.

Using the Results in Practice

  1. Choose time expressions that fit the question: For total profit distribution, Monte Carlo is suitable; for process order, discrete events are suitable; for inter-agent interactions, agent-based is suitable.
  2. From the average to the distribution: In addition to average profit and average demand, the probability of deficits, downward percentiles, and the probability of exceeding capacity are used in decision-making.
  3. Not aiming for high utilization: In queues, the number of people in wait increases nonlinearly as usage increases. We list both the delivery service and the cost.
  4. Evaluate local improvements using system-wide KPIs: Process reduction, preventive maintenance, and safety inventory are compared in terms of effectiveness in throughput, stoppage, and total cost.
  5. Clearly indicate the time delay: There are delays in capacity adjustment, ordering, and supply disruptions. Monthly aggregation alone overlooks vibrations and ripples.
  6. Close the model to on-site performance: Digital twins operate as a single update cycle involving state synchronization, future comparison, and performance verification.

Operational Requirements

1. Define decision-making, scope, and KPIs in advance

Instead of starting with “recreating the entire factory,” define who decides what and when—such as the number of inspectors, ordering points, overtime slots, and alternative procurement. KPIs include not only averages but also on-time delivery rates, around the 95th percentile, maximum order backlog, and total costs.

2. Manage input data and business rules

Item, process, equipment, shifts, arrangements, order backlogs, reasons for stoppages, and definitions of orders received and lost orders are all gathered. Record and reproducibly record data extraction date and time, units, missing-value handling, and start date for standard time application.

3. Validation is conducted step by step

We check event order and inventory balance individually, reproduce past periods, and have on-site staff identify extreme cases. In addition to ensuring the model’s values match actual results, we also verify that the direction of cause and effect aligns with on-site knowledge.

4. Operate from small decision-making loops

For a limited product and process scope, repeat data updates, scenario comparison, approval, execution, and result review. Measure decision time and shortage reductions before expanding integration with ERP, MES, equipment, and procurement data.

5. Communicate uncertainty and the boundary of responsibility

Prediction intervals, assumptions, and non-applicable conditions are displayed on the screen and meeting materials. Includes acceptance or rejection of automated proposals, emergency overwrite permissions, alternative procedures when the model stops, and audit logs in business design.

Conclusion

From No.081 to No.090, we covered Monte Carlo assessments of profit risks, process events, interactions between equipment and maintenance personnel, queues, supply-demand feedback, inventory policies, production lines, supply disruptions, demand scenarios, and performance-linked digital twins.

The value of simulation lies not in creating complex models, but in comparing the outcomes and risks of options before execution. Verify income and expenses and events on a small scale, gradually adding only the elements necessary for decision-making. By continuously leaving gaps between predictions and actual results, the model can be developed from a one-time analysis into a decision-making foundation on the ground.

Consulting Services

At Surikobo, we offer consultations for everything from simulation in manufacturing, inventory, production, and supply chain design, to planning digital twins and support for implementation and in-house production.

  • Discrete Event Simulation Targeting Processes, Logistics, and Maintenance
  • Monte Carlo assessment and scenario design for demand, supply, and profit risks
  • Comparative verification of inventory policies, personnel allocation, capital investment, and BCP initiatives
  • Digital twin / decision-making platform connecting ERP, MES, and facility data
  • Corporate training covering Python, statistics, and simulation

📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
