100 Exercises / Mathematical optimization / Mathematical Optimization 100 Exercises
Introduction to Dynamic Programming in Manufacturing | Optimizing Inventory and Equipment Maintenance with Python
Use Python dynamic programming for production, inventory, and equipment replacement. Compare value iteration, policy iteration, and Q-learning.
Anticipating Demand Fluctuations and Equipment Deterioration: Dynamic Programming and Sequential Decision-Making 10 Exercises
Set in a fictional precision parts factory, it handles production, inventory, and equipment maintenance with The impact of this week’s decision on next week and beyond incorporated. The target is No.061〜No.070(Dynamic Programming and Sequential Decision-Making).
About the example data This article adapts a training notebook used by Suri Kobo or its representative, Hiroshi Wayama, with permission from the client. All data are fictional and do not describe actual companies or factories.
Manufacturing problem
On the manufacturing floor, increasing production, holding inventory, preventive maintenance, and equipment upgrades cannot be evaluated in a single period. This article introduces dynamic programming (DP) through small examples that select current actions while accounting for future costs.
Common planning difficulties
- Overproduction to avoid stockouts increases inventory costs and the risk of retention
- If maintenance is postponed, it can operate this week, but the probability of failure and downtime losses will increase.
- Extending the lifespan of aging equipment improves short-term financial balances while driving up future maintenance costs.
- Because conditions and demands change, fixed rules are not always the best
Why the decision is difficult
This is because the effects of actions span time and carry uncertainty. Sequential decision-making compares “current costs” and “future value after action” on the same scale. However, as states, actions, and periods increase, combinations increase rapidly, so model granularity is also an important design decision.
Exercises in this article
| No. | Theme | Judgment in the manufacturing industry |
|---|---|---|
| 061 | What is dynamic programming? | Determining the production volume over multiple periods |
| 062 | Bellman Equation | Separating current expenses from future value |
| 063 | Shortest Route and Dynamic Programming | Evaluating process routes from behind |
| 064 | The Knapsack Problem and Dynamic Programming | Select improvement projects within your budget |
| 065 | Inventory Management and Dynamic Programming | Determining order quantities under demand fluctuations |
| 066 | Equipment Replacement | Compare repair, continuation, and renewal |
| 067 | Markov Decision Process | Handling Probabilistic Transitions of Equipment States |
| 068 | value iteration | Seeking solutions with low long-term costs |
| 069 | Policy Iteration | Separating measure evaluation from improvement |
| 070 | Relationship with Reinforcement Learning | Learning Unknown Transitions from Driving Data |
Preparing the Python environment
No external data is used. Fix the random number seed so you can reproduce the same result. For clarity, the amount is in thousand yen units.
Run each article in a fresh kernel, starting with [IN: 1] in order. Each [OUT: n] corresponds to the input with the same number. Recorded versions and timings describe the saved output; final digits and solver termination states may vary by environment.
Show environment setup
# Run this article from top to bottom in a fresh notebook kernel.
import platform
import numpy as np
import pandas as pd
import matplotlib
import matplotlib.pyplot as plt
from IPython.display import display
rng = np.random.default_rng(42)
plt.rcParams["figure.figsize"] = (7.2, 4.5)
plt.rcParams["axes.unicode_minus"] = False
pd.DataFrame(
{
"package": ["Python", "NumPy", "pandas", "Matplotlib"],
"version": [
platform.python_version(),
np.__version__,
pd.__version__,
matplotlib.__version__,
],
}
)
| package | version | |
|---|---|---|
| 0 | Python | 3.13.1 |
| 1 | NumPy | 2.5.1 |
| 2 | pandas | 3.0.3 |
| 3 | Matplotlib | 3.11.0 |
Creating the example data
Assume a 12-week precision parts factory. Demand fluctuates gently and randomly, while equipment experiences weekly deterioration. This observation table is for contextual understanding, and for each subsequent exercise, small models are also used to separate decision-making issues.
Show data preparation
weeks = np.arange(1, 13)
demand = np.maximum(
2, np.rint(6 + 1.5 * np.sin(weeks / 2) + rng.normal(0, 1.0, len(weeks)))
).astype(int)
condition = np.maximum(
45, np.rint(96 - 3.5 * weeks + rng.normal(0, 2.5, len(weeks)))
).astype(int)
factory = pd.DataFrame(
{"week": weeks, "demand_lots": demand, "equipment_condition": condition}
)
display(factory)

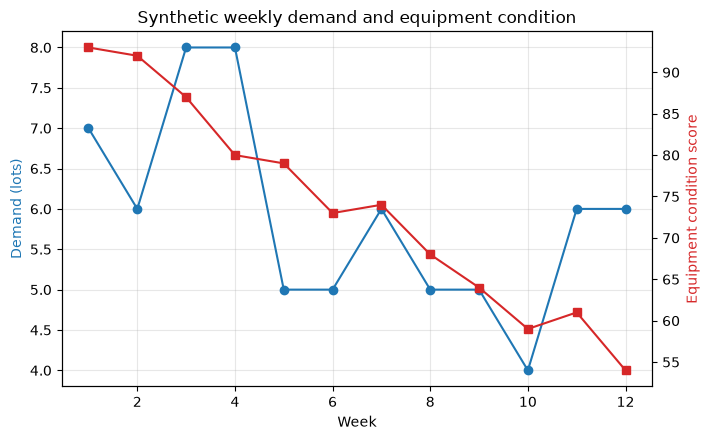

fig, ax1 = plt.subplots()
ax1.plot(weeks, demand, marker="o", label="Demand", color="tab:blue")
ax1.set_xlabel("Week")
ax1.set_ylabel("Demand (lots)", color="tab:blue")
ax2 = ax1.twinx()
ax2.plot(weeks, condition, marker="s", label="Condition", color="tab:red")
ax2.set_ylabel("Equipment condition score", color="tab:red")
ax1.set_title("Synthetic weekly demand and equipment condition")
ax1.grid(True, alpha=0.3)
fig.tight_layout()
plt.show()
| week | demand_lots | equipment_condition | |
|---|---|---|---|
| 0 | 1 | 7 | 93 |
| 1 | 2 | 6 | 92 |
| 2 | 3 | 8 | 87 |
| 3 | 4 | 8 | 80 |
| 4 | 5 | 5 | 79 |
| 5 | 6 | 5 | 73 |
| 6 | 7 | 6 | 74 |
| 7 | 8 | 5 | 68 |
| 8 | 9 | 5 | 64 |
| 9 | 10 | 4 | 59 |
| 10 | 11 | 6 | 61 |
| 11 | 12 | 6 | 54 |

No.061: What is Dynamic Programming?
Meaning in Practice
Dynamic programming divides multi-period problems into “states” and “actions,” reusing the same subproblems. Here, starting inventory is considered the condition, production volume is the action, and production costs are minimized over three weeks.
Approach to Analysis and Modeling
With demand , opening inventory , and production , the next inventory is . Demand is known in this example, shortages are forbidden, and production and inventory are integers from zero to eight. is the minimum remaining cost. Terminal value is zero, and closing stock in the final week still incurs holding cost.
Check with Python
# Work backward from the terminal period and compare feasible production choices.
dp_demand = [4, 7, 5]
capacity, max_inventory = 8, 8
unit_cost, holding_cost = [5, 8, 6], 1.2
V = {3: {s: 0.0 for s in range(max_inventory + 1)}}
policy = {}
for t in range(2, -1, -1):
V[t], policy[t] = {}, {}
for s in range(max_inventory + 1):
choices = []
for a in range(capacity + 1):
nxt = s + a - dp_demand[t]
if 0 <= nxt <= max_inventory:
choices.append(
(unit_cost[t] * a + holding_cost * nxt + V[t + 1][nxt], a)
)
if choices:
V[t][s], policy[t][s] = min(choices)
s, plan = 0, []
for t in range(3):
a = policy[t][s]
nxt = s + a - dp_demand[t]
plan.append([t + 1, s, dp_demand[t], a, nxt, unit_cost[t] * a + holding_cost * nxt])
s = nxt
display(
pd.DataFrame(
plan,
columns=[
"week",
"opening_inventory",
"demand",
"production",
"closing_inventory",
"current_cost_kJPY",
],
)
)
print(f"Minimum 3-week cost: {V[0][0]:.1f} kJPY")
| week | opening_inventory | demand | production | closing_inventory | current_cost_kJPY | |
|---|---|---|---|---|---|---|
| 0 | 1 | 0 | 4 | 8 | 4 | 44.8 |
| 1 | 2 | 4 | 7 | 3 | 0 | 24.0 |
| 2 | 3 | 0 | 5 | 5 | 0 | 30.0 |
Minimum 3-week cost: 98.8 kJPY
Reading the results
Because production is more expensive in week two, the plan produces extra in week one and holds inventory. Optimizing each week in isolation misses this saving. On the other hand, if storage capacity, yield, arrangement, and shortage tolerance are excluded, the plan becomes unfeasible, so it is necessary to check state transitions and constraints.
No.062: Bellman’s Equation
Meaning in Practice
The Bellman equation divides current actions into “costs that occur now” and “future costs in the next state.” This breakdown explains why you chose that production volume.
Approach to Analysis and Modeling
If you set the total evaluation value for candidate action as , it is . The principle of optimality states that the remaining parts of the optimal plan are also optimal from the perspective of their reached state.
Check with Python
t, s = 0, 0
rows = []
for a in range(capacity + 1):
nxt = s + a - dp_demand[t]
if nxt in V[t + 1]:
immediate = unit_cost[t] * a + holding_cost * nxt
rows.append([a, nxt, immediate, V[t + 1][nxt], immediate + V[t + 1][nxt]])
bellman = pd.DataFrame(
rows,
columns=[
"production",
"next_inventory",
"immediate_cost",
"future_cost",
"total_Q",
],
)
display(bellman.round(1))

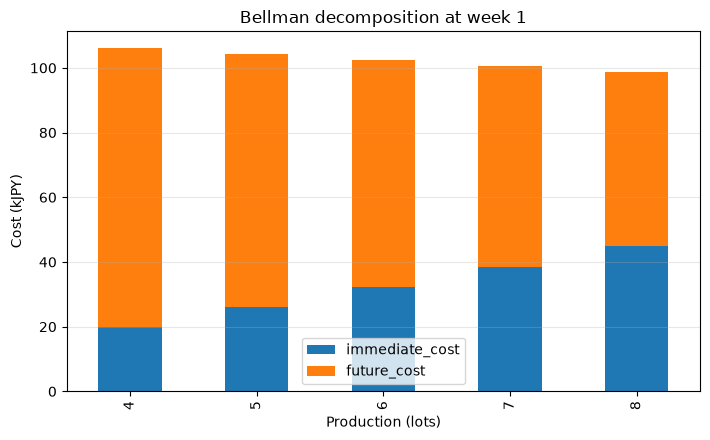

bellman.set_index("production")[["immediate_cost", "future_cost"]].plot(
kind="bar", stacked=True
)
plt.title("Bellman decomposition at week 1")
plt.xlabel("Production (lots)")
plt.ylabel("Cost (kJPY)")
plt.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
| production | next_inventory | immediate_cost | future_cost | total_Q | |
|---|---|---|---|---|---|
| 0 | 4 | 0 | 20.0 | 86.0 | 106.0 |
| 1 | 5 | 1 | 26.2 | 78.0 | 104.2 |
| 2 | 6 | 2 | 32.4 | 70.0 | 102.4 |
| 3 | 7 | 3 | 38.6 | 62.0 | 100.6 |
| 4 | 8 | 4 | 44.8 | 54.0 | 98.8 |

Reading the results
The more production volume increases, the higher current cost increases, but since you can avoid high-price weeks, future costs decrease. The minimum total action is adopted. During the site briefing, presenting this breakdown makes it easier to share “why we are making extra now.”
No.063: Shortest Path and Dynamic Programming
Meaning in Practice
Route selection for products passing through multiple processes can be represented as dynamic programming, with the current location as the state and the next chosen process as the action. Process time, outsourcing costs, and quality risks are converted into common costs.
Approach to Analysis and Modeling
With directed acyclic graphs, you can calculate in reverse order from the endpoint. For general graphs without negative edges, choose solutions that fit the problem structure, such as the Dijkstra method.
Check with Python
edges = {
"Material": [("Cut-A", 4.0), ("Cut-B", 5.0)],
"Cut-A": [("Heat-1", 7.0), ("Heat-2", 5.0)],
"Cut-B": [("Heat-1", 4.0), ("Heat-2", 6.0)],
"Heat-1": [("Inspect", 3.0)],
"Heat-2": [("Inspect", 4.0)],
"Inspect": [("Ship", 2.0)],
"Ship": [],
}
order = ["Ship", "Inspect", "Heat-2", "Heat-1", "Cut-B", "Cut-A", "Material"]
route_value, next_node = {"Ship": 0.0}, {}
for node in order[1:]:
route_value[node], next_node[node] = min(
(cost + route_value[j], j) for j, cost in edges[node]
)
path, node = ["Material"], "Material"
while node != "Ship":
node = next_node[node]
path.append(node)
display(
pd.DataFrame(
{
"node": list(route_value),
"minimum_remaining_cost": list(route_value.values()),
}
).sort_values("minimum_remaining_cost")
)
print("Best route:", " -> ".join(path), f" / cost={route_value['Material']:.1f}")
| node | minimum_remaining_cost | |
|---|---|---|
| 0 | Ship | 0.0 |
| 1 | Inspect | 2.0 |
| 3 | Heat-1 | 5.0 |
| 2 | Heat-2 | 6.0 |
| 4 | Cut-B | 9.0 |
| 5 | Cut-A | 11.0 |
| 6 | Material | 14.0 |
Best route: Material -> Cut-B -> Heat-1 -> Inspect -> Ship / cost=14.0
Reading the results
The minimum residual cost from each process to shipment can be determined, allowing you to restore the optimal route. When adding quality loss or lead time to the cost coefficient, the basis for the amount conversion and the prohibition or capability limit are separately managed.
No.064: The Knapsack Problem and Dynamic Programming
Meaning in Practice
When the improvement budget is limited, ranking projects based solely on effect amounts may waste budget combinations. The 0-1 knapsack problem determines the acceptance or rejection of each project simultaneously.
Approach to Analysis and Modeling
Let project have investment and annual benefit . Maximize subject to and . table[i, b] stores the maximum benefit from the first projects under budget limit . During reconstruction, subtract each selected project’s cost from the remaining budget.
Check with Python
projects = pd.DataFrame(
{
"project": [
"Vision inspection",
"Tool monitoring",
"Energy control",
"AGV routing",
"Predictive maintenance",
],
"investment": [6, 4, 3, 5, 7],
"annual_benefit": [11, 7, 5, 9, 13],
}
)
B, n = 12, len(projects)
table = np.zeros((n + 1, B + 1), dtype=int)
for i in range(1, n + 1):
w, v = projects.loc[i - 1, ["investment", "annual_benefit"]]
for b in range(B + 1):
table[i, b] = table[i - 1, b]
if w <= b:
table[i, b] = max(table[i, b], table[i - 1, b - w] + v)
b, chosen = B, []
for i in range(n, 0, -1):
if table[i, b] != table[i - 1, b]:
chosen.append(i - 1)
b -= projects.loc[i - 1, "investment"]
display(projects.assign(selected=[i in chosen for i in range(n)]))
print(f"Investment={projects.loc[chosen,'investment'].sum()}, benefit={table[n,B]}")

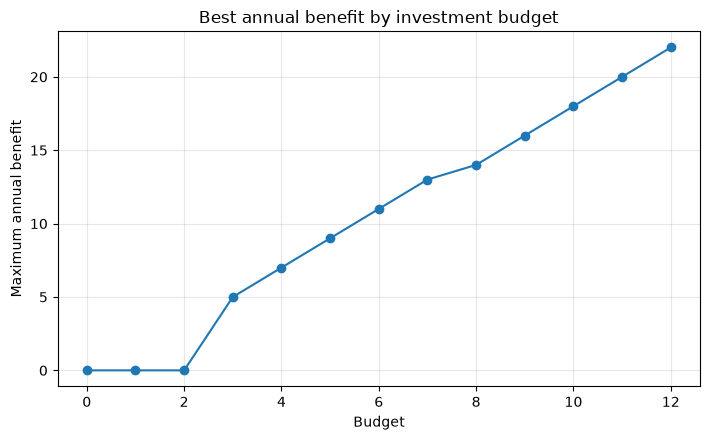

plt.plot(range(B + 1), table[n], marker="o")
plt.title("Best annual benefit by investment budget")
plt.xlabel("Budget")
plt.ylabel("Maximum annual benefit")
plt.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| project | investment | annual_benefit | selected | |
|---|---|---|---|---|
| 0 | Vision inspection | 6 | 11 | False |
| 1 | Tool monitoring | 4 | 7 | False |
| 2 | Energy control | 3 | 5 | False |
| 3 | AGV routing | 5 | 9 | True |
| 4 | Predictive maintenance | 7 | 13 | True |
Investment=12, benefit=22

Reading the results
The adoption set is the most effective combination across the entire budget. Use scenario analysis or integer programming when benefits are uncertain, projects depend on one another, staffing is limited, or some projects cannot run simultaneously.
No.065: Inventory Management and Dynamic Programming Method
Meaning in Practice
For parts whose demand is not yet certain, the order quantity is determined by considering not only inventory costs but also shortage costs. Shortage fees reflect express shipping, line stoppages, and delivery delays.
Approach to Analysis and Modeling
If demand is a random variable, then the Bellman equation containing the expected value
Here and . Orders arrive before that period’s demand, and terminal value is zero.
Here, unmet demand is treated as a shortage for the current period and will not be carried over to the next period.
Check with Python
# Orders arrive before demand; unmet demand is lost rather than backlogged.
dvals, probs = np.array([2, 4, 6, 8]), np.array([0.15, 0.35, 0.35, 0.15])
T, Smax, Amax = 3, 12, 10
fixed, purchase, hold, shortage = 6.0, 3.0, 1.0, 9.0
IV = {T: np.zeros(Smax + 1)}
IP = {}
for t in range(T - 1, -1, -1):
IV[t], IP[t] = np.zeros(Smax + 1), np.zeros(Smax + 1, dtype=int)
for s in range(Smax + 1):
qvals = []
for a in range(Amax + 1):
if s + a > Smax:
continue
exp = fixed * (a > 0) + purchase * a
for d, pr in zip(dvals, probs):
nxt = max(s + a - d, 0)
lost = max(d - s - a, 0)
exp += pr * (hold * nxt + shortage * lost + IV[t + 1][nxt])
qvals.append((exp, a))
IV[t][s], IP[t][s] = min(qvals)
inventory_policy = pd.DataFrame(
{
"opening_inventory": range(Smax + 1),
"order_week1": IP[0],
"expected_cost_to_go": IV[0],
}
)
display(inventory_policy.round(2))

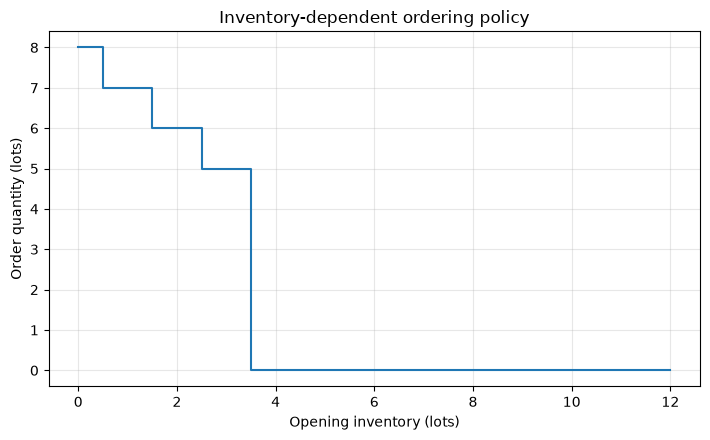

plt.step(inventory_policy.opening_inventory, inventory_policy.order_week1, where="mid")
plt.title("Inventory-dependent ordering policy")
plt.xlabel("Opening inventory (lots)")
plt.ylabel("Order quantity (lots)")
plt.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| opening_inventory | order_week1 | expected_cost_to_go | |
|---|---|---|---|
| 0 | 0 | 8 | 73.07 |
| 1 | 1 | 7 | 70.07 |
| 2 | 2 | 6 | 67.07 |
| 3 | 3 | 5 | 64.07 |
| 4 | 4 | 0 | 60.80 |
| 5 | 5 | 0 | 55.30 |
| 6 | 6 | 0 | 49.80 |
| 7 | 7 | 0 | 46.58 |
| 8 | 8 | 0 | 43.07 |
| 9 | 9 | 0 | 40.66 |
| 10 | 10 | 0 | 37.33 |
| 11 | 11 | 0 | 35.03 |
| 12 | 12 | 0 | 31.33 |

Reading the results
When inventory is low, orders are placed in bulk, and orders are not placed above a certain level. Because there are fixed order costs, it is not a simple replenishment every period. In practice, we also verify updates on demand distribution, order lead times, lot rounding, storage periods, and service levels.
No.066: Equipment Replacement Problem
Meaning in Practice
Equipment renewal involves comparing not only the purchase price but also maintenance costs due to aging, downtime losses, and residual value after renewal over multiple years.
Approach to Analysis and Modeling
Keeping equipment increases its age by one next period; replacement makes it age one next period. discount=0.95 is a discount factor, related to annual discount rate by . State eight represents equipment aged eight or more. Terminal salvage value reduces cost; proceeds from disposing of replaced equipment are omitted.
Check with Python
horizon, max_age, discount = 5, 8, 0.95
replace_cost = 65.0
maintenance = np.array([5 + 2 * a + 0.8 * a * a for a in range(max_age + 2)])
EV = {horizon: {a: -max(3, 18 - 2 * a) for a in range(max_age + 1)}}
EP = {}
for t in range(horizon - 1, -1, -1):
EV[t], EP[t] = {}, {}
for age in range(max_age + 1):
keep = maintenance[age] + discount * EV[t + 1][min(age + 1, max_age)]
replace = replace_cost + maintenance[0] + discount * EV[t + 1][1]
EV[t][age], EP[t][age] = min((keep, "Keep"), (replace, "Replace"))
eq = pd.DataFrame(
{
"equipment_age": range(max_age + 1),
"decision_now": [EP[0][a] for a in range(max_age + 1)],
"discounted_cost": [EV[0][a] for a in range(max_age + 1)],
}
)
display(eq.round(1))
plt.plot(eq.equipment_age, eq.discounted_cost, marker="o")

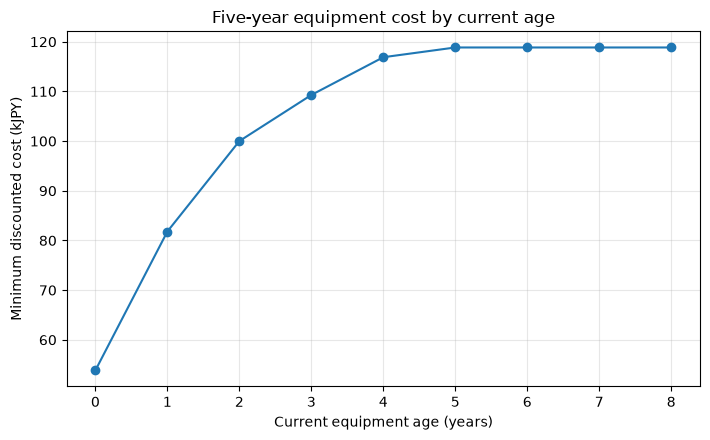

plt.title("Five-year equipment cost by current age")
plt.xlabel("Current equipment age (years)")
plt.ylabel("Minimum discounted cost (kJPY)")
plt.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| equipment_age | decision_now | discounted_cost | |
|---|---|---|---|
| 0 | 0 | Keep | 53.8 |
| 1 | 1 | Keep | 81.8 |
| 2 | 2 | Keep | 100.0 |
| 3 | 3 | Keep | 109.3 |
| 4 | 4 | Keep | 116.9 |
| 5 | 5 | Replace | 118.8 |
| 6 | 6 | Replace | 118.8 |
| 7 | 7 | Replace | 118.8 |
| 8 | 8 | Replace | 118.8 |

Reading the results
Young equipment continues and is replaced as it ages. Since thresholds vary depending on maintenance costs, renewal costs, discount rates, and residual value, a sensitivity table should be attached to the capital investment review rather than a single conclusion.
No.067: Markov Decision Process
Meaning in Practice
The Markov Decision Process (MDP) represents the condition of equipment as a state of health, deterioration, or failure, and the probability of the next state changes depending on operation, maintenance, and replacement.
Approach to Analysis and Modeling
An MDP specifies states , actions , transition probabilities , costs , and a discount factor . We use an infinite-horizon model with . The Markov assumption means the current state contains the historical information needed to predict the next-state distribution.
Check with Python
states = ["Healthy", "Degraded", "Failed"]
actions = ["Run", "Maintain", "Replace"]
P = np.array(
[
[[0.85, 0.14, 0.01], [0.95, 0.05, 0], [1, 0, 0]],
[[0.25, 0.55, 0.20], [0.75, 0.23, 0.02], [1, 0, 0]],
[[0, 0, 1], [0.55, 0.40, 0.05], [1, 0, 0]],
]
)
C = np.array([[2, 8, 25], [5, 10, 25], [45, 35, 25]], dtype=float)
rows = []
for si, s in enumerate(states):
for ai, a in enumerate(actions):
rows.append([s, a, C[si, ai], *P[si, ai]])
mdp_table = pd.DataFrame(
rows, columns=["state", "action", "cost", "P_healthy", "P_degraded", "P_failed"]
)
display(mdp_table)
print("Maximum transition-row error:", np.abs(P.sum(axis=2) - 1).max())
| state | action | cost | P_healthy | P_degraded | P_failed | |
|---|---|---|---|---|---|---|
| 0 | Healthy | Run | 2.0 | 0.85 | 0.14 | 0.01 |
| 1 | Healthy | Maintain | 8.0 | 0.95 | 0.05 | 0.00 |
| 2 | Healthy | Replace | 25.0 | 1.00 | 0.00 | 0.00 |
| 3 | Degraded | Run | 5.0 | 0.25 | 0.55 | 0.20 |
| 4 | Degraded | Maintain | 10.0 | 0.75 | 0.23 | 0.02 |
| 5 | Degraded | Replace | 25.0 | 1.00 | 0.00 | 0.00 |
| 6 | Failed | Run | 45.0 | 0.00 | 0.00 | 1.00 |
| 7 | Failed | Maintain | 35.0 | 0.55 | 0.40 | 0.05 |
| 8 | Failed | Replace | 25.0 | 1.00 | 0.00 | 0.00 |
Maximum transition-row error: 0.0
Reading the results
Even with the same ‘operation,’ the probability of failure is high when deteriorated, and maintenance pays for improvements in transitions. If states omit relevant history, the Markov assumption may fail. We verify whether information necessary for future forecasting, such as vibration, cumulative operation, and near-term maintenance, is included in the condition.
No.068: Value Iteration
Meaning in Practice
The value iteration method repeatedly updates the long-term costs of each state and seeks actions with minimal cost. This forms the basis for establishing standard response rules for each equipment condition.
Approach to Analysis and Modeling
For an infinite-horizon problem with discount factor ,
Repeat until convergence. Residuals are an indicator of numerical convergence and do not guarantee model validity.
Check with Python
# einsum computes expected next-state value for every state-action pair.
gamma = 0.95
value = np.zeros(len(states))
residuals = []
for k in range(1000):
Q = C + gamma * np.einsum("sak,k->sa", P, value)
new_value = Q.min(axis=1)
residuals.append(np.max(np.abs(new_value - value)))
value = new_value
if residuals[-1] < 1e-10:
break
vi_policy = Q.argmin(axis=1)
display(
pd.DataFrame(
{
"state": states,
"long_run_cost": value,
"recommended_action": [actions[i] for i in vi_policy],
}
).round(2)
)
plt.semilogy(residuals)

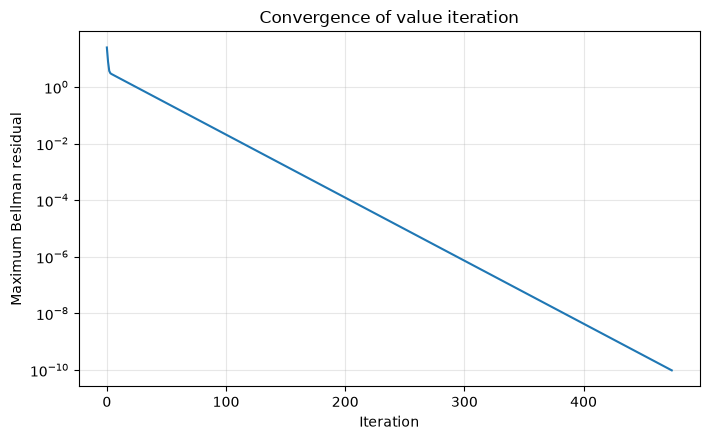

plt.title("Convergence of value iteration")
plt.xlabel("Iteration")
plt.ylabel("Maximum Bellman residual")
plt.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
print("Iterations:", len(residuals))
| state | long_run_cost | recommended_action | |
|---|---|---|---|
| 0 | Healthy | 67.97 | Run |
| 1 | Degraded | 76.94 | Maintain |
| 2 | Failed | 89.57 | Replace |

Iterations: 475
Reading the results
You can get condition-dependent strategies: operation when healthy, maintenance when deteriorating, and replacement when broken. The closer the discount factor is to 1, the more distant the future is emphasized, and the slower convergence becomes. We also check the stability of measures that change costs and transition probabilities.
No.069: Policy Iteration
Meaning in Practice
Policy iteration evaluates the long-term costs of current standard rules and only changes actions where improvement is possible. The comparison with current measures is clear.
Approach to Analysis and Modeling
Fix to solve and use its value to improve behavior in each state. If the strategy no longer changes, it will end.
Check with Python
pi = np.array([0, 0, 1]) # Healthy=Run, Degraded=Run, Failed=Maintain
history = []
for it in range(20):
Ppi = P[np.arange(3), pi]
cpi = C[np.arange(3), pi]
vpi = np.linalg.solve(np.eye(3) - gamma * Ppi, cpi)
qpi = C + gamma * np.einsum("sak,k->sa", P, vpi)
improved = qpi.argmin(axis=1)
history.append([it, *[actions[x] for x in pi], *vpi])
if np.array_equal(improved, pi):
break
pi = improved
display(
pd.DataFrame(
history,
columns=[
"iteration",
"Healthy_action",
"Degraded_action",
"Failed_action",
"V_healthy",
"V_degraded",
"V_failed",
],
).round(2)
)
print("Stable policy:", dict(zip(states, [actions[x] for x in pi])))
| iteration | Healthy_action | Degraded_action | Failed_action | V_healthy | V_degraded | V_failed | |
|---|---|---|---|---|---|---|---|
| 0 | 0 | Run | Run | Maintain | 90.65 | 106.94 | 129.14 |
| 1 | 1 | Run | Maintain | Replace | 67.97 | 76.94 | 89.57 |
Stable policy: {'Healthy': 'Run', 'Degraded': 'Maintain', 'Failed': 'Replace'}
Reading the results
From the initial current rules, through evaluation and improvement, we reach the same approach as value iteration. If the number of states is large, the problem of solving linear equations increases, so iterative evaluation and approximation methods are considered.
No.070: Relationship with Reinforcement Learning
Meaning in Practice
DP and MDP assume that transition probabilities and cost models are known. Reinforcement learning estimates value based on the “state, behavior, cost, and next state” obtained through trials. Here, we will learn the same maintenance problems using Q-learning.
Approach to Analysis and Modeling
The cost-minimized version of Q-learning is based on observation samples.
This update uses sampled transitions without requiring their probability model, but it needs sufficient exploration. This does not mean unlimited exploration on the actual device.
Check with Python
# The learning-rate floor is illustrative; it does not certify exact Q convergence.
qrng = np.random.default_rng(42)
Qlearn = np.zeros((3, 3))
visits = np.zeros((3, 3), int)
episodes, steps = 12000, 25
agreement = []
for ep in range(episodes):
s = int(qrng.integers(0, 3))
eps = max(0.03, 0.8 * (1 - ep / episodes))
for _ in range(steps):
a = (
int(qrng.integers(0, 3))
if qrng.random() < eps
else int(np.argmin(Qlearn[s]))
)
sn = int(qrng.choice(3, p=P[s, a]))
cost = C[s, a]
visits[s, a] += 1
alpha = max(0.02, 0.5 / (visits[s, a] ** 0.55))
Qlearn[s, a] += alpha * (cost + gamma * Qlearn[sn].min() - Qlearn[s, a])
s = sn
agreement.append(np.mean(Qlearn.argmin(axis=1) == vi_policy))
learned = Qlearn.argmin(axis=1)
display(
pd.DataFrame(
{
"state": states,
"MDP_action": [actions[i] for i in vi_policy],
"learned_action": [actions[i] for i in learned],
"minimum_visits": visits.min(axis=1),
}
)
)

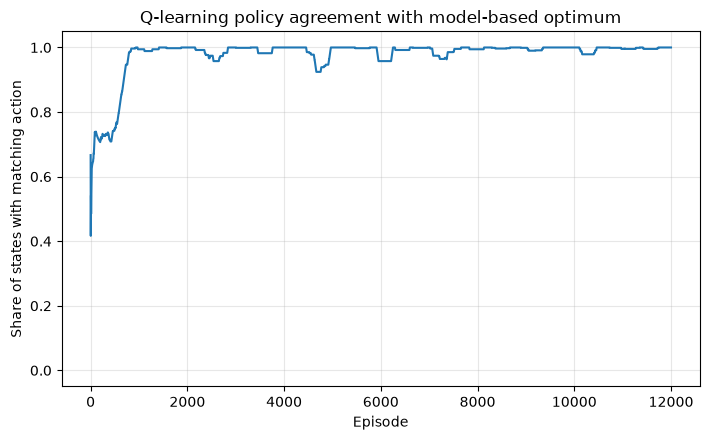

plt.plot(pd.Series(agreement).rolling(300, min_periods=1).mean())
plt.title("Q-learning policy agreement with model-based optimum")
plt.xlabel("Episode")
plt.ylabel("Share of states with matching action")
plt.ylim(-0.05, 1.05)
plt.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| state | MDP_action | learned_action | minimum_visits | |
|---|---|---|---|---|
| 0 | Healthy | Run | Run | 33523 |
| 1 | Degraded | Maintain | Maintain | 5006 |
| 2 | Failed | Replace | Replace | 1222 |

Reading the results
For this seed and training budget, the learned action in each of the three states matches value iteration. The learning rate has a floor of 0.02, so this agreement is not a proof that Q-values converge exactly. Evaluate costs and policy stability using multiple seeds and unused simulated trajectories.
Practical implications
- Sequential decision-making evaluates not only current-period KPIs but also the future value of the following state
- Conditions are narrowed down to providing sufficient information for future forecasts, preventing an explosion in the number of states.
- Prepare explanatory materials not only for optimal measures but also for immediate costs, future costs, and differences from alternative actions
- Transition probabilities, demand distribution, and cost factors are regularly re-estimated to monitor changes in strategy
- Rather than a simple binary of DP/MDP if the model is known, or learning if unknown, it combines known information with data.
- Reinforcement learning exploration is conducted under simulators or safety constraints, without directly connecting to actual machines
Putting the model into practice
| Topic | Checks | Main Deliverables |
|---|---|---|
| Decision-making | Who chooses, when, and what | Business Flow & Approval Responsibilities |
| Condition | How to represent inventory, deterioration, work-in-progress, and delivery dates | State Definition & Data Dictionary |
| Actions and Constraints | Capacity, safety, lots, and maintenance windows | List of Constraints and Rationale |
| Fees | Shortage, downtime, quality, and salvage value | Cost Conversion Table & Sensitivity Analysis |
| probability | Demand and Fault Transition Estimation Accuracy | Estimation Procedure & Verification Results |
| Utilization | Recalculation, exceptions, model degradation | SOP and Monitoring Dashboard |
Initially, limit the number of states and actions, then use the current rules as a baseline for backtesting with past data. Starting with decision support where people confirm reasons for recommendations and alternatives, it simultaneously monitors downtime losses, service levels, and workload.
Conclusion
Multi-period production, process routes, improvement projects, inventory, and equipment renewals are represented as DP, and probabilistic equipment maintenance is expanded into MDP, value iteration, policy iteration, and Q-learning. What matters is not the advanced solution itself, but the clarity of the carryover effects as state transitions, making them decision-making rules that can be verified by the field.
Business inquiries
At Suri Kobo, we support sequential decision-making in production, inventory, and equipment maintenance, including problem organization, data design, simulation, optimization PoC, and operational design.
📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
