All articles →

100 Exercises / Mathematical optimization / Mathematical Optimization 100 Exercises

Introduction to Stochastic and Robust Optimization in Manufacturing | Creating Production Plans Resistant to Demand Fluctuations in Python

Plan production under uncertain demand and yield in Python. Compare expected profit, service targets, robust models, CO2 trade-offs, and tail risk.

Production planning that resists demand fluctuations: 10-step stochastic optimization that balances profit, stockouts, and resilience

Using a fictional precision parts factory as the subject, we examine how to determine production volume before demand or yield is finalized. The target is No.071〜No.080(Stochastic Optimization / Robust Optimization). Not only expected profits, but also out-of-stock probability, worst-case scenarios, CVaR, and balancing profit and CO2 are compared from the same data to differences in decision-making.

About the example data This article adapts a training notebook used by Suri Kobo or its representative, Hiroshi Wayama, with permission from the client. All data are fictional and do not describe actual companies or factories.

Manufacturing problem

Monthly production volumes may be decided before all orders are finalized. Making more can avoid stockouts, but it increases excess inventory, overtime, and waste. Producing less may seem more efficient, but opportunities can be lost when demand exceeds the forecast. The purpose of this article is not to “guess a single prediction value,” but to create a plan that can be explained including prediction errors.

Common planning difficulties

  • Sales forecasts change monthly and are finalized later than manufacturing lead times.
  • Yield, equipment shutdowns, and the unit price of express materials also fluctuate
  • Not only profit maximization, but also targets for on-time delivery rates, overtime, and CO2 emissions
  • Plans made solely on average demand run out of stock during busy months and stagnate in slow months

Why the decision is difficult

This is because your attitude toward uncertainty can change the “best” plan. You need to agree in advance whether to prioritize average profits, meet demand with a certain probability, or protect the worst-case scenario within the observation range. Additionally, overly conservative planning drives up normal operating costs. Therefore, we judge not only the optimal value but also profit distribution, out-of-stock rate, and sensitivity to assumptions side by side.

Exercises in this article

No.ThemeQuestions Answered On-Site
071Optimization with UncertaintyWhat do average-only plans miss?
072Stochastic programmingHow to Consolidate Profit and Loss by Scenario
073scenario optimizationHow to evaluate the combination of demand and yield
074Chance constraintHow to Keep the Probability of Out-of-Stock Within an Acceptable Range
075Robust optimizationHow to Meet Worst-Demand Within the Expected Range
076Distributionally Robust OptimizationHow to Prepare for Distribution Estimate Biases
077Multiobjective OptimizationHow to handle profits and CO2 simultaneously
078Pareto optimalityHow to present alternatives that management can choose from.
079Risk Measures and CVaRHow to measure losses in bad cases
080Production planning considering demand fluctuationsHow to compare policies and decide on recommended plans

Preparing the Python environment

No external data is used. Fix the random number seed so you can reproduce the same result. The amount is ten thousand yen, the quantity is lot, and the CO2 is kg-CO2. All graphs are created using Matplotlib.

Run each article in a fresh kernel, starting with [IN: 1] in order. Each [OUT: n] corresponds to the input with the same number. Recorded versions and timings describe the saved output; final digits and solver termination states may vary by environment.

Show environment setup
[IN: 1]
# Run this article from top to bottom in a fresh notebook kernel.
import platform
import numpy as np
import pandas as pd
import matplotlib
import matplotlib.pyplot as plt
from scipy.optimize import minimize_scalar
from scipy.stats import norm
from IPython.display import display

rng = np.random.default_rng(20260712)
plt.rcParams["figure.figsize"] = (8, 4.5)
plt.rcParams["axes.unicode_minus"] = False

print("Python     :", platform.python_version())
print("NumPy      :", np.__version__)
print("pandas     :", pd.__version__)
print("Matplotlib :", matplotlib.__version__)
[OUT: 1]
Python     : 3.13.1
NumPy      : 2.5.1
pandas     : 3.0.3
Matplotlib : 3.11.0

Creating the example data

We assume a monthly plan for precision parts A. Let qq be production quantity, DD demand, and YY yield. Good output is qYqY. The selling price is 18,000 yen, normal production costs are 9,000 yen, the disposal value of surplus items is 3,500 yen, and the additional shortage penalty, beyond lost sales revenue, is 8,000 yen.

Profit in scenario ss

πs(q)=pmin⁡(qYs,Ds)+v(qYs−Ds)+−cq−b(Ds−qYs)+.\begin{aligned}\pi_s(q)={}&p\min(qY_s,D_s)\\&+v(qY_s-D_s)_+-cq\\&-b(D_s-qY_s)_+.\end{aligned}

Here (x)+=max⁡(x,0)(x)_+=\max(x,0). We introduce a negative correlation between demand and yield, representing a hypothetical scenario where yield slightly declines during busy periods.

Show data preparation
[IN: 2]
n_scenarios = 3000
z_d = rng.normal(size=n_scenarios)
z_y = rng.normal(size=n_scenarios)
demand = np.clip(100 + 18 * z_d, 45, 160)
yield_rate = np.clip(0.94 - 0.018 * z_d + 0.018 * z_y, 0.84, 0.99)
scenarios = pd.DataFrame({"demand": demand, "yield_rate": yield_rate})

price, unit_cost, salvage, shortage_penalty = 1.80, 0.90, 0.35, 0.80

def profit(q, d=demand, y=yield_rate):
    good = q * y
    sold = np.minimum(good, d)
    surplus = np.maximum(good - d, 0)
    shortage = np.maximum(d - good, 0)
    return (
        price * sold + salvage * surplus - unit_cost * q - shortage_penalty * shortage
    )

display(scenarios.describe(percentiles=[0.05, 0.5, 0.95]).round(2))

fig, ax = plt.subplots()

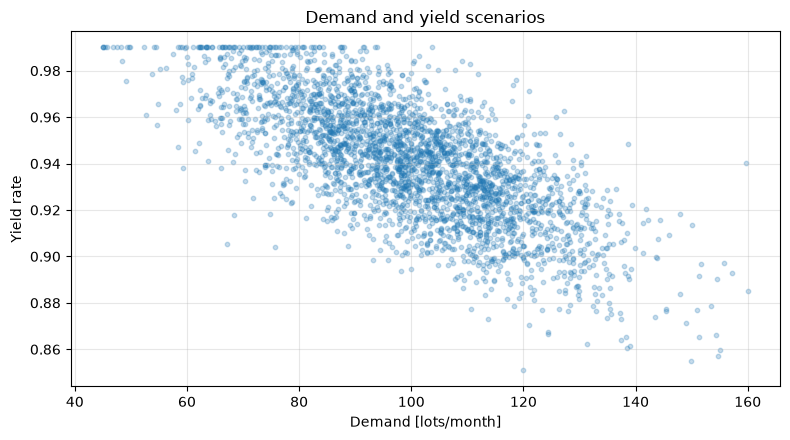

ax.scatter(demand, yield_rate, s=10, alpha=0.25)
ax.set_title("Demand and yield scenarios")
ax.set_xlabel("Demand [lots/month]")
ax.set_ylabel("Yield rate")
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 2]
demand yield_rate
count 3000.00 3000.00
mean 99.77 0.94
std 18.01 0.03
min 45.00 0.85
5% 69.90 0.90
50% 99.73 0.94
95% 129.11 0.98
max 160.00 0.99

Example data: computed result (figure 1)

No.071: Optimization with Uncertainty

Meaning in Practice

If you plan only on average demand, you ignore the tails of the demand distribution and yield decline. In optimization involving uncertainty, unknown quantities are treated as random variables or intervals before decision-making, and the performance of the plan is evaluated by distribution.

Approach to Analysis and Modeling

First, compare a fixed plan that substitutes only the average value with a plan that maximizes expected returns across multiple scenarios. Expected value planning is

max⁡q  E[π(q,D,Y)]\max_q\;\mathbb{E}[\pi(q,D,Y)]

A high expected profit alone does not imply low downside risk.

Check with Python

[IN: 3]
q_grid = np.arange(70, 151)
deterministic_profit = [
    profit(q, np.array([demand.mean()]), np.array([yield_rate.mean()]))[0]
    for q in q_grid
]
expected_profit = np.array([profit(q).mean() for q in q_grid])
q_det = q_grid[np.argmax(deterministic_profit)]
q_sto = q_grid[np.argmax(expected_profit)]

comparison_071 = pd.DataFrame(
    {
        "plan": ["mean-value", "stochastic"],
        "production_q": [q_det, q_sto],
        "expected_profit": [profit(q_det).mean(), profit(q_sto).mean()],
        "shortage_probability": [
            (q_det * yield_rate < demand).mean(),
            (q_sto * yield_rate < demand).mean(),
        ],
    }
)
display(comparison_071.round(3))

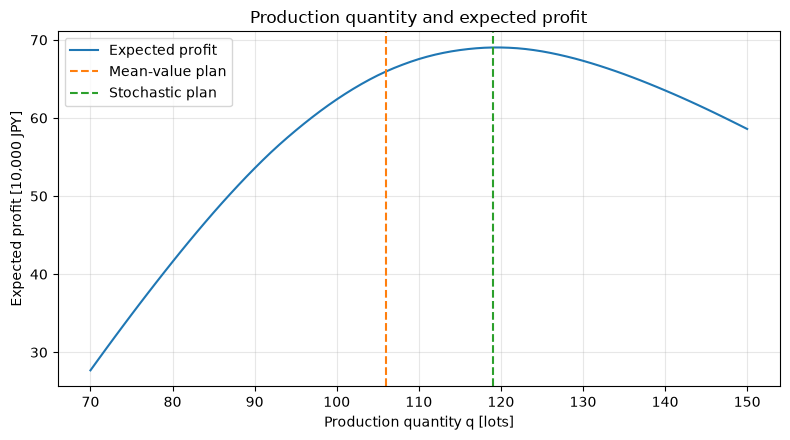

fig, ax = plt.subplots()
ax.plot(q_grid, expected_profit, label="Expected profit")
ax.axvline(q_det, color="tab:orange", linestyle="--", label="Mean-value plan")
ax.axvline(q_sto, color="tab:green", linestyle="--", label="Stochastic plan")
ax.set_title("Production quantity and expected profit")
ax.set_xlabel("Production quantity q [lots]")
ax.set_ylabel("Expected profit [10,000 JPY]")
ax.grid(True, alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 3]
plan production_q expected_profit shortage_probability
0 mean-value 106 65.951 0.501
1 stochastic 119 69.028 0.283

No.071: computed result (figure 1)

Reading the results

Average and stochastic planning differ in recommended quantities and out-of-stock probabilities. The difference is not a “difference in forecasting accuracy,” but rather the effect of evaluating asymmetric surplus and out-of-stock costs across the entire distribution. On site, the average profit and out-of-stock rate are always listed together.

No.072: Stochastic Programming

Meaning in Practice

If additional production or outsourcing can be done after demand is identified, separating regular production in advance and post-response can better reflect the reality. This is a two-stage stochastic plan that distinguishes between the “amount decided now” and the “amount to be adjusted later.”

Approach to Analysis and Modeling

The code below uses a one-stage stochastic model: choose one production quantity qq before uncertainty is resolved, then average its scenario profits. It does not include post-demand production or outsourcing decisions. The sample-average objective is

max⁡q  1S∑s=1Sπs(q)\max_q\;\frac{1}{S}\sum_{s=1}^S \pi_s(q)

The shortage penalty is an additional loss on unmet demand; the model does not record revenue from delivering that shortage later. A two-stage extension would need scenario-specific recourse quantities, their costs and capacity limits, and consistent sales accounting.

Check with Python

[IN: 4]
rows = []
for q in q_grid:
    p = profit(q)
    rows.append([q, p.mean(), p.std(ddof=1), np.quantile(p, 0.10)])
table_072 = pd.DataFrame(rows, columns=["q", "mean_profit", "profit_sd", "p10_profit"])
best_072 = table_072.loc[table_072["mean_profit"].idxmax()]
display(table_072.sort_values("mean_profit", ascending=False).head(8).round(2))
print("Production maximizing expected profit:", int(best_072["q"]))
[OUT: 4]
q mean_profit profit_sd p10_profit
49 119 69.03 17.85 43.22
50 120 69.03 18.20 42.75
48 118 68.99 17.51 43.51
51 121 68.99 18.54 42.27
52 122 68.93 18.88 41.75
47 117 68.93 17.16 44.00
53 123 68.83 19.21 41.43
46 116 68.82 16.81 44.42
Production maximizing expected profit: 119

Reading the results

By saving not only the average but also the standard deviation and 10% points for each candidate quantity, you can compare candidates with only a small difference in expected profit from a risk perspective. During implementation, constraints such as scenario occurrence probability, express capability, and procurement lead time are also added.

No.073: Scenario Optimization

Meaning in Practice

A few cases, such as “boom,” “standard,” or “recession,” can sometimes overlook the combination of demand and yield. Create numerous coherent scenarios and see under what conditions the plan will collapse.

Approach to Analysis and Modeling

Generate paired demand and yield scenarios (Ds,Ys)(D_s,Y_s) and apply the same qq to all of them. Here, subsets of the original 3,000 scenarios select qq, and a separately seeded set of 3,000 scenarios evaluates it. A separate generator keeps validation independent without changing the training subsets or subsequent random draws.

Check with Python

[IN: 5]
# Use a separate validation generator without changing the training random stream.
validation_rng = np.random.default_rng(20260713)
z_d_valid = validation_rng.normal(size=3000)
z_y_valid = validation_rng.normal(size=3000)
validation_demand = np.clip(100 + 18 * z_d_valid, 45, 160)
validation_yield = np.clip(0.94 - 0.018 * z_d_valid + 0.018 * z_y_valid, 0.84, 0.99)

train_sizes = [50, 200, 1000, 3000]
rows = []
for n in train_sizes:
    idx = rng.choice(n_scenarios, size=n, replace=False)
    train_scores = [profit(q, demand[idx], yield_rate[idx]).mean() for q in q_grid]
    q_hat = q_grid[np.argmax(train_scores)]
    rows.append(
        [
            n,
            q_hat,
            profit(q_hat, validation_demand, validation_yield).mean(),
            (q_hat * validation_yield < validation_demand).mean(),
        ]
    )
stability_073 = pd.DataFrame(
    rows,
    columns=[
        "scenario_count",
        "selected_q",
        "validation_profit",
        "validation_shortage_rate",
    ],
)
display(stability_073.round(3))

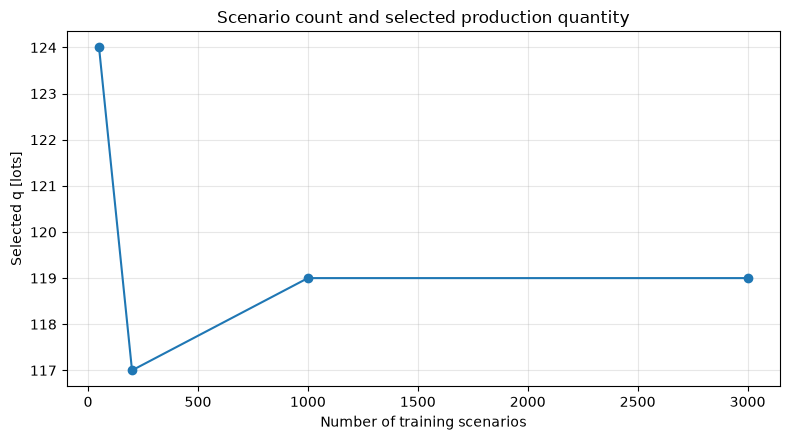

fig, ax = plt.subplots()
ax.plot(stability_073["scenario_count"], stability_073["selected_q"], marker="o")
ax.set_title("Scenario count and selected production quantity")
ax.set_xlabel("Number of training scenarios")
ax.set_ylabel("Selected q [lots]")
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 5]
scenario_count selected_q validation_profit validation_shortage_rate
0 50 124 69.285 0.211
1 200 117 69.502 0.313
2 1000 119 69.594 0.284
3 3000 119 69.594 0.284

No.073: computed result (figure 1)

Reading the results

If the number of scenarios is small, the recommended amount will be adjusted based on the demand mix that happens to be included. Select a number where the recommended amount and validation KPIs are sufficiently stable, and record the generation logic, random seed, and target period.

No.074: Chance Constraint

Meaning in Practice

For key customers, a service level is needed that is not “average enough,” but “at least 95% of the time demand is met.”

Approach to Analysis and Modeling

If the probability of allowing stockouts to be α\alpha, the chance constraint is

Pr⁡(qY≥D)≥1−α\Pr(qY\ge D)\ge 1-\alpha

We estimate service probability as the fraction of scenarios meeting demand and find the minimum production quantity that meets the constraints. Since estimation errors exist with finite samples, confidence intervals and safety margins are also considered in actual operation.

Check with Python

[IN: 6]
service = np.array([(q * yield_rate >= demand).mean() for q in q_grid])
chance_rows = []
for target in [0.90, 0.95, 0.99]:
    feasible = q_grid[service >= target]
    q_req = int(feasible[0]) if len(feasible) else np.nan
    chance_rows.append(
        [target, q_req, profit(q_req).mean() if np.isfinite(q_req) else np.nan]
    )
chance_074 = pd.DataFrame(
    chance_rows, columns=["target_service", "minimum_q", "expected_profit"]
)
display(chance_074.round(2))

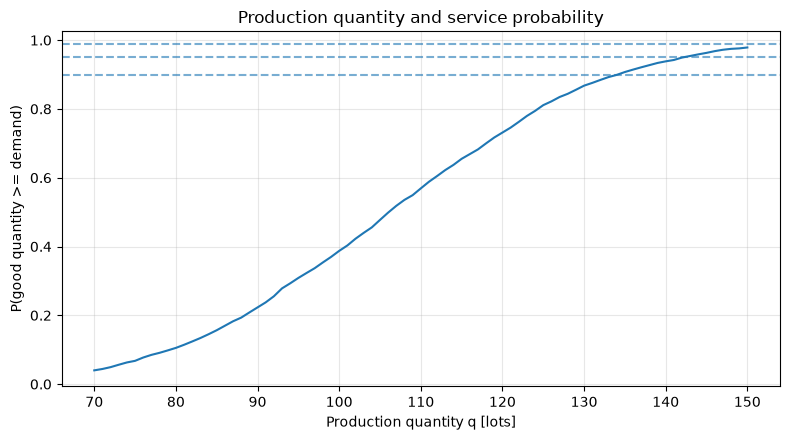

fig, ax = plt.subplots()
ax.plot(q_grid, service, label="Estimated service probability")
for target in [0.90, 0.95, 0.99]:
    ax.axhline(target, linestyle="--", alpha=0.6)
ax.set_title("Production quantity and service probability")
ax.set_xlabel("Production quantity q [lots]")
ax.set_ylabel("P(good quantity >= demand)")
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 6]
target_service minimum_q expected_profit
0 0.90 135.0 65.61
1 0.95 143.0 62.15
2 0.99 NaN NaN

No.074: computed result (figure 1)

Reading the results

This sample requires 135 lots for 90% service and 143 for 95%. NaN at 99% means that no candidate in the searched range of 70–150 lots satisfies the target, not that 99% service is intrinsically impossible. Choose the search range and target using actual capacity and incremental cost.

No.075: Robust Optimization

Meaning in Practice

For new products or disaster response products where predicted distributions are difficult to trust, the likelihood of “protection anywhere within the expected range” may be prioritized over occurrence probability.

Approach to Analysis and Modeling

Constraints that can be fulfilled even under worst-case conditions from the demand ceiling DUD^{U} and yield floor YLY^{L}

qYL≥DUqY^{L}\ge D^{U}

This constraint does not require probabilities, but if the uncertainty set is too large, it leads to overproduction.

Check with Python

[IN: 7]
robust_rows = []
for d_upper, y_lower, label in [
    (125, 0.91, "moderate"),
    (140, 0.88, "strict"),
    (160, 0.84, "extreme"),
]:
    q_req = int(np.ceil(d_upper / y_lower))
    robust_rows.append(
        [
            label,
            d_upper,
            y_lower,
            q_req,
            profit(q_req).mean(),
            (q_req * yield_rate >= demand).mean(),
        ]
    )
robust_075 = pd.DataFrame(
    robust_rows,
    columns=[
        "uncertainty_set",
        "demand_upper",
        "yield_lower",
        "q",
        "expected_profit",
        "service_rate",
    ],
)
display(robust_075.round(2))
[OUT: 7]
uncertainty_set demand_upper yield_lower q expected_profit service_rate
0 moderate 125 0.91 138 64.40 0.93
1 strict 140 0.88 160 53.15 0.99
2 extreme 160 0.84 191 35.62 1.00

Reading the results

A wider uncertainty set can increase required production and reduce mean profit. This calculation has no upper bound of 150 lots: the earlier search grid is not a capacity constraint. Add the actual capacity limit explicitly when one exists. We do not arbitrarily set upper or lower limits; instead, we agree on past forecast errors, equipment failure history, and BCP policies.

No.076: Distributionally Robust Optimization

Meaning in Practice

Stochastic programming depends on whether the estimated distribution is correct. If there are few samples or the composition changes with a new product, it is necessary to be prepared for deviations in the distribution itself.

Approach to Analysis and Modeling

Distributionally Robust Optimization (DRO) evaluates the worst-case expected benefit among candidate distribution sets P\mathcal P.

max⁡qmin⁡P∈PEP[π(q,D,Y)]\max_q\min_{P\in\mathcal P}\mathbb E_P[\pi(q,D,Y)]

Here, for explanation, we create three distribution models: standard, demand fluctuations, and yield deterioration to maximize their minimum expected returns.

Check with Python

[IN: 8]
models = {
    "baseline": (demand, yield_rate),
    "demand_shift": (demand + 8, yield_rate),
    "yield_shift": (demand, np.clip(yield_rate - 0.025, 0.80, 1.0)),
}
model_profit = pd.DataFrame(
    {name: [profit(q, d, y).mean() for q in q_grid] for name, (d, y) in models.items()},
    index=q_grid,
)
worst_expected = model_profit.min(axis=1)
q_dro = int(worst_expected.idxmax())
display(
    pd.DataFrame(
        {
            "model": model_profit.columns,
            "expected_profit_at_DRO": model_profit.loc[q_dro].values,
        }
    ).round(2)
)
print(
    "Illustrative DRO production quantity:",
    q_dro,
    "  Worst-case model expected profit:",
    round(worst_expected.loc[q_dro], 2),
)

fig, ax = plt.subplots()
for col in model_profit:
    ax.plot(q_grid, model_profit[col], label=col)
ax.plot(q_grid, worst_expected, color="black", linewidth=2, label="Worst model")
ax.axvline(q_dro, color="tab:red", linestyle="--")
ax.set_title("Expected profit under distribution shifts")
ax.set_xlabel("Production quantity q [lots]")
ax.set_ylabel("Expected profit [10,000 JPY]")
ax.grid(True, alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 8]
model expected_profit_at_DRO
0 baseline 68.93
1 demand_shift 75.04
2 yield_shift 66.05
Illustrative DRO production quantity: 122   Worst-case model expected profit: 66.05

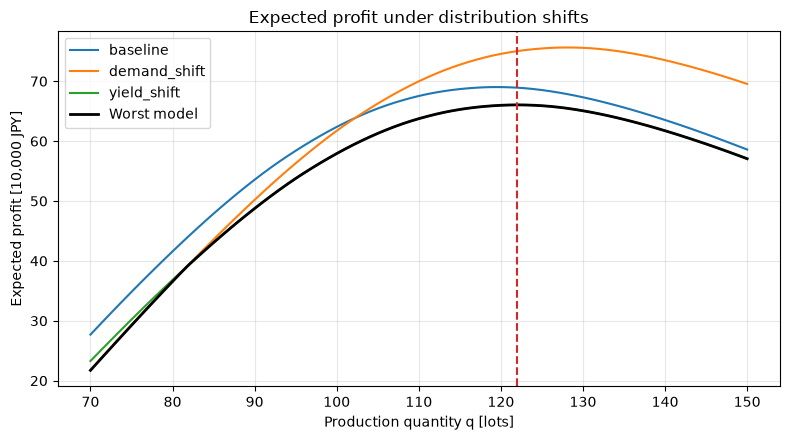

No.076: computed result (figure 1)

Reading the results

This illustrative three-model DRO plan reduces reliance on a single estimated distribution. In practice, since the size of the distribution set determines conservatism, backtesting is conducted to verify “how much distribution deviation is covered.”

No.077: Multiobjective Optimization

Meaning in Practice

Manufacturing planning serves multiple purposes, including profit, delivery time, CO2, and overtime. If you can’t convert everything into monetary value, instead of deciding on a single answer first, compare candidates with different weights.

Approach to Analysis and Modeling

Assume normal production emits 5.2 kg of CO2 per lot and each unmet lot incurs an additional emissions score of 11 kg, representing emergency responses. This is a simplified emissions model; actual recourse quantities and later deliveries are not modeled. The weighted-sum objective is

max⁡q{E[π(q)]−λE[C(q)]}\max_q\{\mathbb E[\pi(q)]-\lambda\mathbb E[C(q)]\}

Change λ\lambda. It is important to clearly specify the unit and scale for the target value.

Check with Python

[IN: 9]
def expected_co2(q):
    shortage = np.maximum(demand - q * yield_rate, 0)
    return 5.2 * q + 11.0 * shortage.mean()

co2 = np.array([expected_co2(q) for q in q_grid])
multi_rows = []
for lam in [0, 0.02, 0.05, 0.10, 0.20]:
    score = expected_profit - lam * co2
    i = np.argmax(score)
    multi_rows.append([lam, q_grid[i], expected_profit[i], co2[i], service[i]])
multi_077 = pd.DataFrame(
    multi_rows,
    columns=["carbon_weight", "q", "expected_profit", "expected_co2", "service_rate"],
)
display(multi_077.round(2))
[OUT: 9]
carbon_weight q expected_profit expected_co2 service_rate
0 0.00 119 69.03 656.43 0.72
1 0.02 118 68.99 654.19 0.70
2 0.05 117 68.93 652.11 0.68
3 0.10 114 68.54 646.79 0.64
4 0.20 112 68.11 644.05 0.60

Reading the results

Changing the carbon weight affects the recommended amount and service rate. Weights are not set behind closed doors by analysts, but are linked to internal policies such as carbon pricing, customer requirements, and SBT.

No.078: Pareto Optimality

Meaning in Practice

A plan is dominated if another offers at least as much profit and no more CO2, with a strict improvement in at least one measure. Removing dominated plans leaves alternatives that require a judgment about the trade-off between profit and emissions.

Approach to Analysis and Modeling

A dominates B if it has at least as much profit and no more CO2, with a strict improvement in one measure. A candidate is Pareto optimal if no other candidate dominates it. The Pareto set is not the “only correct answer,” but a boundary for making value judgments.

Check with Python

[IN: 10]
pareto = []
for i, q in enumerate(q_grid):
    dominated = np.any(
        (expected_profit >= expected_profit[i])
        & (co2 <= co2[i])
        & ((expected_profit > expected_profit[i]) | (co2 < co2[i]))
    )
    if not dominated:
        pareto.append(i)
pareto_078 = pd.DataFrame(
    {
        "q": q_grid[pareto],
        "expected_profit": expected_profit[pareto],
        "expected_co2": co2[pareto],
        "service_rate": service[pareto],
    }
)
display(pareto_078.iloc[:: max(1, len(pareto_078) // 8)].round(2))

fig, ax = plt.subplots()
ax.scatter(co2, expected_profit, alpha=0.45, label="Candidates")
ax.plot(
    co2[pareto],
    expected_profit[pareto],
    color="tab:red",
    marker="o",
    label="Pareto frontier",
)
ax.set_title("Profit-CO2 Pareto frontier")
ax.set_xlabel("Expected CO2 [kg-CO2]")
ax.set_ylabel("Expected profit [10,000 JPY]")
ax.grid(True, alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 10]
q expected_profit expected_co2 service_rate
0 106 65.95 640.16 0.50
1 107 66.40 640.35 0.52
2 108 66.82 640.75 0.54
3 109 67.20 641.29 0.55
4 110 67.54 642.01 0.57
5 111 67.85 642.94 0.59
6 112 68.11 644.05 0.60
7 113 68.34 645.34 0.62
8 114 68.54 646.79 0.64
9 115 68.70 648.42 0.66
10 116 68.82 650.20 0.67
11 117 68.93 652.11 0.68
12 118 68.99 654.19 0.70
13 119 69.03 656.43 0.72

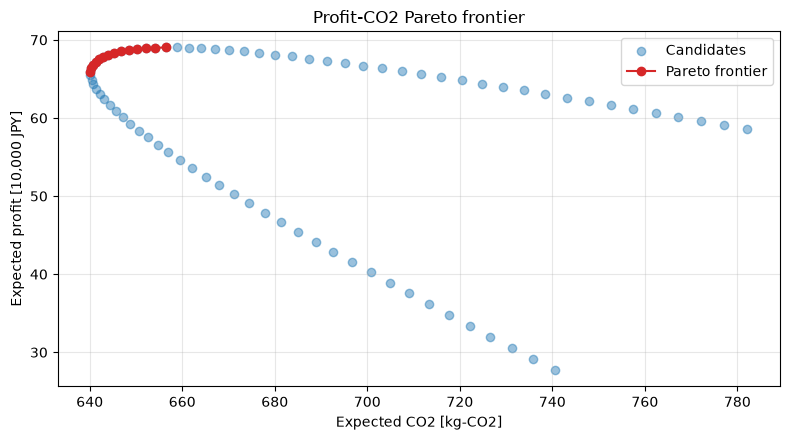

No.078: computed result (figure 1)

Reading the results

From the slope of the Pareto curve, you can read the CO2 increase for additional profit. In decision-making meetings, narrowing down to 3 to 5 representative proposals and presenting profit, CO2, and service rates in the same table makes it easier to reach consensus.

No.079: Risk Measures and CVaR

Meaning in Practice

Even if the average profit is the same, a plan that rarely runs a large deficit and a plan with stable losses are not the same. CVaR measures the average of the bad case group and represents downside risk to business continuity.

Approach to Analysis and Modeling

We use lower-tail CVaR to mean average profit over the worst fraction α\alpha of outcomes. When observations tie at the quantile, include only the fraction of boundary observations needed to make the tail probability exactly α\alpha.

CVaRαprofit(q)=1α∫0αFq−1(u) du.\mathrm{CVaR}^{\mathrm{profit}}_{\alpha}(q) =\frac{1}{\alpha}\int_0^{\alpha}F_q^{-1}(u)\,du.

Here Fq−1F_q^{-1} is the profit quantile function. With 3,000 equally weighted samples and α=0.10\alpha=0.10, we average the 300 smallest profits.

A larger value indicates better profit in the worst outcomes. This is the negative of upper-tail loss CVaR at confidence level 1−α1-\alpha when loss is defined as minus profit.

Check with Python

[IN: 11]
# The lower 10% of 3,000 samples contains exactly 300 observations.
alpha = 0.10
lower_cvar = []
for q in q_grid:
    p = profit(q)
    tail_count = int(round(alpha * len(p)))
    lower_cvar.append(np.sort(p)[:tail_count].mean())
lower_cvar = np.array(lower_cvar)

risk_rows = []
for gamma in [0, 0.25, 0.5, 0.75, 1.0]:
    score = (1 - gamma) * expected_profit + gamma * lower_cvar
    i = np.argmax(score)
    risk_rows.append([gamma, q_grid[i], expected_profit[i], lower_cvar[i], service[i]])
risk_079 = pd.DataFrame(
    risk_rows,
    columns=["risk_weight", "q", "expected_profit", "lower_10pct_CVaR", "service_rate"],
)
display(risk_079.round(2))

fig, ax = plt.subplots()
ax.plot(q_grid, expected_profit, label="Expected profit")
ax.plot(q_grid, lower_cvar, label="Lower 10% CVaR")
ax.set_title("Expected profit and downside profit")
ax.set_xlabel("Production quantity q [lots]")
ax.set_ylabel("Profit [10,000 JPY]")
ax.grid(True, alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
[OUT: 11]
risk_weight q expected_profit lower_10pct_CVaR service_rate
0 0.00 119 69.03 31.92 0.72
1 0.25 115 68.70 33.81 0.66
2 0.50 110 67.54 35.68 0.57
3 0.75 108 66.82 36.13 0.54
4 1.00 106 65.95 36.30 0.50

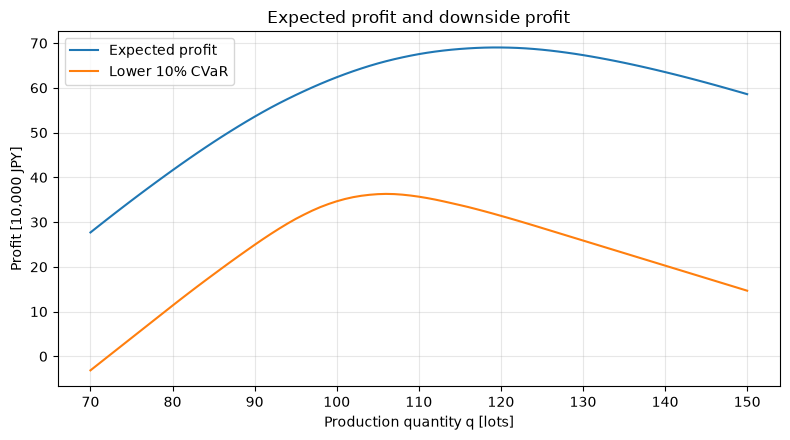

No.079: computed result (figure 1)

Reading the results

When risk weight increases, a plan is chosen to partially compromise average profit and improve lower-tier cases. The level and weight of CVaR are determined based on management losses such as financial capacity, penalties, and impact on key customers.

No.080: Production Planning Considering Demand Fluctuations

Meaning in Practice

Finally, we compare maximum expected profit, 95% service, robust, DRO style, and CVaR emphasis using the same KPIs. It is important not to choose based on the method name, but rather to select KPIs that align with your company’s scope of responsibility.

Approach to Analysis and Modeling

Compare each policy on the same 3,000 scenarios used for planning. This is an in-sample comparison, not independent validation. Among the five listed policies, select the one with highest expected profit subject to at least 95% sample service. Evaluate it on independent scenarios, as in No.073, before adoption.

Check with Python

[IN: 12]
q_chance = int(chance_074.loc[chance_074.target_service == 0.95, "minimum_q"].iloc[0])
q_robust = int(robust_075.loc[robust_075.uncertainty_set == "moderate", "q"].iloc[0])
q_cvar = int(risk_079.loc[risk_079.risk_weight == 1.0, "q"].iloc[0])
plans = {
    "Expected profit": int(q_sto),
    "95% service": q_chance,
    "Robust": q_robust,
    "DRO-like": q_dro,
    "CVaR-focused": q_cvar,
}

rows = []
for name, q in plans.items():
    p = profit(q)
    good = q * yield_rate
    rows.append(
        [
            name,
            q,
            p.mean(),
            np.sort(p)[: int(round(0.10 * len(p)))].mean(),
            (good >= demand).mean(),
            np.maximum(good - demand, 0).mean(),
            expected_co2(q),
        ]
    )
final_080 = pd.DataFrame(
    rows,
    columns=[
        "plan",
        "q",
        "expected_profit",
        "lower_10pct_CVaR",
        "service_rate",
        "expected_surplus",
        "expected_co2",
    ],
)
display(final_080.round(2).sort_values("expected_profit", ascending=False))

eligible = final_080[final_080.service_rate >= 0.95]
recommended = eligible.loc[eligible.expected_profit.idxmax()]
print(f"Recommendation: {recommended['plan']} / q={int(recommended['q'])} lots")

fig, ax = plt.subplots()
x = np.arange(len(final_080))
ax.bar(x, final_080["expected_profit"], color="tab:blue", alpha=0.75)
ax.set_xticks(x, final_080["plan"], rotation=20, ha="right")
ax.set_title("Expected profit by planning policy")
ax.set_xlabel("Planning policy")
ax.set_ylabel("Expected profit [10,000 JPY]")
ax.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 12]
plan q expected_profit lower_10pct_CVaR service_rate expected_surplus expected_co2
0 Expected profit 119 69.03 31.92 0.72 15.54 656.43
3 DRO-like 122 68.93 30.35 0.76 17.65 664.14
4 CVaR-focused 106 65.95 36.30 0.50 7.99 640.16
2 Robust 138 64.40 21.40 0.93 30.64 724.82
1 95% service 143 62.15 18.60 0.95 35.08 747.89
Recommendation: 95% service / q=143 lots

No.080: computed result (figure 1)

Reading the results

Even with the same data, production volume and KPIs can vary depending on policy. In this example, a sample service probability of at least 95% was required and recommended a plan with the highest expected profit within that constraint. In practice, candidate quantities are adjusted to equipment capacity, lot sizes, and setup constraints, and after rounding, all KPIs are re-evaluated.

Practical implications

  • Average demand is a summary of inputs and does not leave the risk information necessary for decision-making.
  • Probabilistic planning, chance constraints, robust optimization, and DRO differ from what you want to protect and the assumptions you want to protect.
  • It is necessary not only to increase the number of scenarios but also to reflect the correlation between demand and yield, seasonality, and structural changes.
  • Compare the additional costs of improving service rates with the losses caused by out-of-stock using the same meeting materials.
  • In multiobjective problems, candidates for Pareto are presented, and the weight of the objective is treated as a management decision.
  • CVaR visualizes bad cases that are not visible on average, but clearly defines target probabilities and signs.

Putting the model into practice

  1. Setting the boundaries of decision-making: Define the target part number, period, and the scope of normal production, outsourcing, and inventory.
  2. Take stock of profit and loss: Not only manufacturing costs, but also stockouts, express shipping, disposal, overtime, and customer impact are organized.
  3. Verify the scenario: Backtesting during unused periods, including forecast errors, correlations, busy periods, and equipment outages.
  4. Agree on a risk policy: Service level, uncertainty set, and CVaR level are determined by sales, manufacturing, and finance.
  5. Implement on-site constraints: Add capacity, scheduling, minimum lot, storage, raw materials, and personnel to the model.
  6. Monitor operations: Stores recommended values, adoption values, reasons for overwriting, performance KPIs, and distribution deviations, and sets conditions for retraining.

Conclusion

In production planning under uncertainty, the starting point is to evaluate profits and services across multiple scenarios rather than focusing on a single forecast. Probabilistic planning focuses on average outcomes, chance constraints focus on the probability of achievement, robust optimization guarantees assumed ranges, DRO focuses on distribution deviation, and CVaR focuses on downside risk. Before choosing an optimization method, defining what and to what extent to be followed leads to an explainable and actionable plan.

Business inquiries

Suri Kobo supports production and inventory planning under demand uncertainty, service-level design, scenario generation, and integration with existing systems. A PoC can start by comparing with current rules, designing KPIs, backtesting, and organizing on-site constraints.

📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
