100 Exercises / Mathematical optimization / Mathematical Optimization 100 Exercises
Introduction to Mathematical Optimization in Manufacturing | Practical Use of Production Planning, Inventory, Personnel, and Capital Investment with Python
Explore Python models for factory production, schedules, staffing, inventory, orders, and investment, with clear assumptions and decision records.
Connecting Factory Decision-Making: 10 Exercises on Production, Scheduling, Inventory, and Investment Optimization
Exercises No.091–No.100 apply optimization to a fictional precision-parts factory: production quantities, schedules, staffing, inventory, purchasing, and investment. The examples also show how to record recommendations for review and execution.
Here, DI (Decision Intelligence) refers to a system that does not just look at forecasts but translates them under constraints into “what to do, when, and how much to execute,” improving next decisions based on actual results.
About the example data This article adapts a training notebook used by Suri Kobo or its representative, Hiroshi Wayama, with permission from the client. All data are fictional and do not describe actual companies or factories.
Manufacturing problem
Sales plans tend to be made by product, equipment plans by machine, personnel plans by skills, and procurement plans by components. However, on the ground, increasing production increases planning and overtime, reducing inventory raises the risk of stockouts, and purchasing equipment changes fixed costs and future options. In this article, we connect these together with common data and objective metrics.
Common planning difficulties
- Different spreadsheets use different demand and capacity assumptions.
- Departmental KPIs such as “delivery priority” and “minimum inventory” clash
- Practical constraints such as skilled personnel, planning, and maintenance stoppages are not reflected in the plan.
- Optimization results are limited to just one number, and you can’t explain alternatives or how they deteriorate.
Why the decision is difficult
Decision variables are interdependent and include both integer and uncertainty. Because of forecasting errors, a plan that works out of the box may not always be executable as is. Therefore, it is necessary to clearly state objective functions, constraints, temporal granularity, and replanning conditions, and evaluate effectiveness by comparing with the current proposal.
Exercises in this article
| No. | Theme | Key Decisions | Key Evaluation Indicators |
|---|---|---|---|
| 091 | Production Planning Optimization | Production volume by product | Contribution margin, Capacity Margin |
| 092 | job shop | Work Sequence by Equipment | makespan |
| 093 | Flow Shop | Common Input Order for All Processes | Completion time |
| 094 | Line balancing | Work process allocation | Cycle time, efficiency |
| 095 | staffing | Skill-based shifts | Adequacy Rate, Personnel Expenses |
| 096 | Inventory optimization | Safety Stock & Ordering Point | Service Rate, Holdings |
| 097 | Order volume optimization | lot size | Order cost + storage fee |
| 098 | Capital Investment Optimization | Portfolio of Investment Projects | NPV, budget consumption |
| 099 | Simulation × Optimization | Policy under uncertainty | Total cost distribution, out-of-stock rate |
| 100 | Decision Engine | From input to approval | Value, Feasibility, Auditability |
Preparing the Python environment
No external data is used. Using only NumPy, pandas, SciPy, and Matplotlib, fix the random number generator’s seed and make it reproducible.
Run each article in a fresh kernel, starting with [IN: 1] in order. Each [OUT: n] corresponds to the input with the same number. Recorded versions and timings describe the saved output; final digits and solver termination states may vary by environment.
Show environment setup
# Run this article from top to bottom in a fresh notebook kernel.
import platform
import itertools
import numpy as np
import pandas as pd
import matplotlib
import matplotlib.pyplot as plt
import scipy
from scipy.optimize import linprog
from IPython.display import display
rng = np.random.default_rng(42)
plt.rcParams.update({"figure.figsize": (8, 4), "axes.grid": True})
print(f"Python {platform.python_version()}")
print(
f"NumPy {np.__version__} / pandas {pd.__version__} / SciPy {scipy.__version__} / Matplotlib {matplotlib.__version__}"
)
Python 3.13.1
NumPy 2.5.1 / pandas 3.0.3 / SciPy 1.18.0 / Matplotlib 3.11.0
Creating the example data
We consider a precision-parts factory producing three products. Money is generally in thousand yen, time in hours, and demand and inventory in units. The investment and NPV figures in No.098 are in million yen. Production and flow-shop examples use the tables below; other examples define their own illustrative data.
Show data preparation
products = pd.DataFrame(
{
"product": ["A-Standard", "B-High Precision", "C-Short delivery time"],
"demand": [420, 300, 260],
"contribution": [8.0, 11.0, 9.0],
"machining_h": [1.0, 1.6, 1.2],
"assembly_h": [0.8, 0.7, 1.1],
"material_kg": [2.0, 2.8, 1.7],
}
)
capacity = pd.Series({"machining_h": 1150, "assembly_h": 850, "material_kg": 2200})
jobs = pd.DataFrame(
{
"job": list("ABCDEF"),
"M1": [4, 7, 3, 6, 5, 4],
"M2": [6, 3, 5, 4, 7, 2],
"M3": [3, 5, 4, 6, 2, 5],
}
)
display(products)
display(capacity.rename("monthly_capacity").to_frame())
display(jobs)
| product | demand | contribution | machining_h | assembly_h | material_kg | |
|---|---|---|---|---|---|---|
| 0 | A-Standard | 420 | 8.0 | 1.0 | 0.8 | 2.0 |
| 1 | B-High Precision | 300 | 11.0 | 1.6 | 0.7 | 2.8 |
| 2 | C-Short delivery time | 260 | 9.0 | 1.2 | 1.1 | 1.7 |
| monthly_capacity | |
|---|---|
| machining_h | 1150 |
| assembly_h | 850 |
| material_kg | 2200 |
| job | M1 | M2 | M3 | |
|---|---|---|---|---|
| 0 | A | 4 | 6 | 3 |
| 1 | B | 7 | 3 | 5 |
| 2 | C | 3 | 5 | 4 |
| 3 | D | 6 | 4 | 6 |
| 4 | E | 5 | 7 | 2 |
| 5 | F | 4 | 2 | 5 |
No.091: Production Planning Optimization
Meaning in Practice
Within the upper limit of demand, it decides which products to allocate limited processing, assembly, and materials. The key issue is not “high-sales products,” but rather what to use one hour of bottleneck capability for to contribute to profit.
Approach to Analysis and Modeling
Let be product p_ia_{ri}r$. The model is
It can be expressed as such. Here, continuous solutions of linear programming are set as monthly goals, and in actual operation, quantities are adjusted to lot sizes and all constraints are checked again.
Check with Python
resource_cols = ["machining_h", "assembly_h", "material_kg"]
r91 = linprog(
-products["contribution"],
A_ub=products[resource_cols].to_numpy().T,
b_ub=capacity.to_numpy(),
bounds=list(zip(np.zeros(3), products["demand"])),
method="highs",
)
if not r91.success:
raise RuntimeError(r91.message)
plan = products[["product", "demand"]].copy()
plan["optimal_qty"] = r91.x
plan["contribution_kJPY"] = r91.x * products["contribution"]
usage = pd.DataFrame(
{"capacity": capacity, "used": products[resource_cols].to_numpy().T @ r91.x}
)
usage["utilization_%"] = 100 * usage["used"] / usage["capacity"]
display(plan.round(1))
display(usage.round(1))

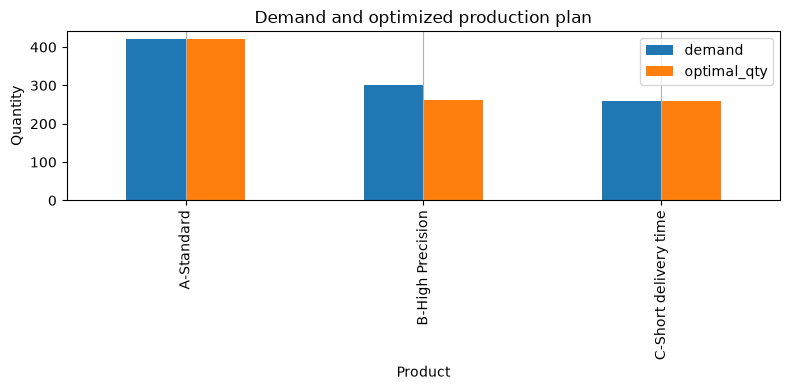

ax = plan.set_index("product")[["demand", "optimal_qty"]].plot.bar()
ax.set(
title="Demand and optimized production plan", xlabel="Product", ylabel="Quantity"
)
ax.grid(axis="y")
plt.tight_layout()
plt.show()
| product | demand | optimal_qty | contribution_kJPY | |
|---|---|---|---|---|
| 0 | A-Standard | 420 | 420.0 | 3360.0 |
| 1 | B-High Precision | 300 | 261.2 | 2873.8 |
| 2 | C-Short delivery time | 260 | 260.0 | 2340.0 |
| capacity | used | utilization_% | |
|---|---|---|---|
| machining_h | 1150 | 1150.0 | 100.0 |
| assembly_h | 850 | 804.9 | 94.7 |
| material_kg | 2200 | 2013.5 | 91.5 |

Reading the results
Rather than meeting all demand, constrained resources are allocated to combinations with higher profit contributions. Resources with an operating rate close to 100% are bottlenecks for increased production. However, rounding fractions into lots can result in exceedance, so re-verification after rounding and minimum supply constraints are necessary.
No.092: Job Shop Scheduling
Meaning in Practice
In processing sites where the equipment sequence passes through different jobs for each job, it is necessary to plan to ensure that work does not overlap with the same equipment and to follow the process order for each job. It affects not only delivery delays but also work-on backlogs and rescheduling.
Approach to Analysis and Modeling
Set the start time of work as , impose operation-precedence and machine non-overlap constraints on equipment, and minimize the makespan , the completion time of the final operation. Here, we solve small-scale examples using dispatch rules that prioritize tasks that can be executed early. It is also important to note that it is not always strictly optimal.
Check with Python
routes = {
"J1": [("M1", 4), ("M2", 3), ("M3", 2)],
"J2": [("M2", 2), ("M1", 5), ("M3", 4)],
"J3": [("M1", 3), ("M3", 5), ("M2", 2)],
"J4": [("M3", 3), ("M2", 4), ("M1", 2)],
}
machine_free = {m: 0 for m in ["M1", "M2", "M3"]}
job_free = {j: 0 for j in routes}
sched = []
remaining = [(j, k, m, p) for j, ops in routes.items() for k, (m, p) in enumerate(ops)]
while remaining:
eligible = [x for x in remaining if x[1] == sum(1 for r in sched if r[0] == x[0])]
j, k, m, p = min(
eligible, key=lambda x: (max(job_free[x[0]], machine_free[x[2]]), x[3])
)
start = max(job_free[j], machine_free[m])
end = start + p
sched.append((j, k, m, start, end))
job_free[j] = end
machine_free[m] = end
remaining.remove((j, k, m, p))
sched_df = pd.DataFrame(sched, columns=["job", "operation", "machine", "start", "end"])
display(sched_df.sort_values(["machine", "start"]))
fig, ax = plt.subplots()
for y, (m, g) in enumerate(sched_df.groupby("machine")):
for _, r in g.iterrows():
ax.barh(y, r.end - r.start, left=r.start)
ax.text((r.start + r.end) / 2, y, r.job, ha="center", va="center")
ax.set_yticks(range(3), sorted(sched_df.machine.unique()))
ax.set(title="Job-shop schedule", xlabel="Time", ylabel="Machine")
ax.grid(axis="x")
plt.tight_layout()
plt.show()

print("Makespan:", sched_df.end.max())
| job | operation | machine | start | end | |
|---|---|---|---|---|---|
| 1 | J3 | 0 | M1 | 0 | 3 |
| 3 | J1 | 0 | M1 | 3 | 7 |
| 6 | J4 | 2 | M1 | 7 | 9 |
| 8 | J2 | 1 | M1 | 9 | 14 |
| 0 | J2 | 0 | M2 | 0 | 2 |
| 4 | J4 | 1 | M2 | 3 | 7 |
| 7 | J1 | 1 | M2 | 7 | 10 |
| 10 | J3 | 2 | M2 | 10 | 12 |
| 2 | J4 | 0 | M3 | 0 | 3 |
| 5 | J3 | 1 | M3 | 3 | 8 |
| 9 | J1 | 2 | M3 | 10 | 12 |
| 11 | J2 | 2 | M3 | 14 | 18 |

Makespan: 18
Reading the results
There are no duplicates in the Gantt diagram, and the order of each job is followed. On the other hand, equipment gaps also occur while waiting for the previous process. In practice, we compare current rules, including deadlines, priorities, setup-time matrices, and downtime, as well as makespan, delays, and stability.
No.093: Flow Shop Scheduling
Meaning in Practice
On a line where all products follow the same process sequence, even just the order of input can greatly affect the waiting time for subsequent processes. If you simply change the order, there is a possibility of improving without capital investment.
Approach to Analysis and Modeling
For permutation , the completion time can be recursively calculated in . Since there are 6 jobs, you list all permutations and find the minimum makespan.
Check with Python
def flow_completion(order):
c = np.zeros((len(order), 3))
for i, j in enumerate(order):
for m, col in enumerate(["M1", "M2", "M3"]):
c[i, m] = (
max(c[i - 1, m] if i else 0, c[i, m - 1] if m else 0)
+ jobs.set_index("job").loc[j, col]
)
return c
records = []
for order in itertools.permutations(jobs.job):
records.append((order, flow_completion(order)[-1, -1]))
records.sort(key=lambda x: x[1])
best_order, best_ms = records[0]
base = tuple(jobs.job)
base_ms = flow_completion(base)[-1, -1]
display(
pd.DataFrame(
{
"plan": ["Current", "Optimized"],
"order": ["→".join(base), "→".join(best_order)],
"makespan": [base_ms, best_ms],
}
)
)
c = flow_completion(best_order)

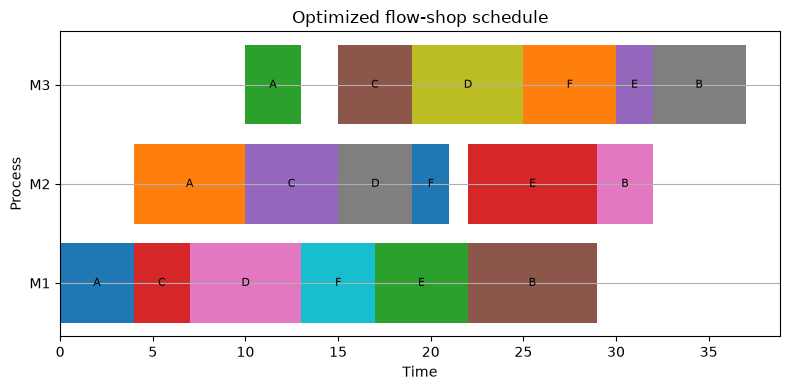

fig, ax = plt.subplots()
for i, j in enumerate(best_order):
for m in range(3):
p = jobs.set_index("job").loc[j, f"M{m+1}"]
ax.barh(m, p, left=c[i, m] - p)
ax.text(c[i, m] - p / 2, m, j, ha="center", va="center", fontsize=8)
ax.set_yticks(range(3), ["M1", "M2", "M3"])
ax.set(title="Optimized flow-shop schedule", xlabel="Time", ylabel="Process")
ax.grid(axis="x")
plt.tight_layout()
plt.show()
| plan | order | makespan | |
|---|---|---|---|
| 0 | Current | A→B→C→D→E→F | 39.0 |
| 1 | Optimized | A→C→D→F→E→B | 37.0 |

Reading the results
The gap in makespan between the current and best order is an area for improvement when changing the order of deployment. If there are multiple permutations with the best tie, you can select delivery time and setup stability as secondary indicators. As the number of varieties increases, the total enumeration surges, so switch to integer programming or heuristics.
No.094: Line Balancing
Meaning in Practice
Assembly work is assigned to the process, reducing load differences between processes while meeting the target cycle time. Since the maximum load process determines the overall production speed of the line, it is not possible to judge based solely on average time.
Approach to Analysis and Modeling
For total task time , station count , and prescribed cycle time , line efficiency is . The code processes tasks in fixed order A→B→…→H, opening a new station whenever the next task would exceed seven hours. This greedy packing rule is not ranked positional weight or a method for finding the minimum station count under arbitrary precedence constraints.
Check with Python
# Preserve task order A through H and open a new station when the next task will not fit.
tasks = pd.DataFrame(
{"task": list("ABCDEFGH"), "time": [2.4, 3.1, 1.8, 2.6, 3.4, 1.5, 2.2, 2.8]}
)
cycle = 7.0
stations = []
current = []
load = 0
for _, r in tasks.iterrows():
if load + r.time > cycle:
stations.append((current, load))
current = []
load = 0
current.append(r.task)
load += r.time
stations.append((current, load))
bal = pd.DataFrame(
{
"station": range(1, len(stations) + 1),
"tasks": [",".join(s[0]) for s in stations],
"load_h": [s[1] for s in stations],
}
)
bal["idle_h"] = cycle - bal.load_h
efficiency = tasks.time.sum() / (len(bal) * cycle)
display(bal.round(1))
print(f"Line efficiency: {efficiency:.1%}")
ax = bal.plot.bar(x="station", y=["load_h", "idle_h"], stacked=True)
ax.set(
title="Workload and idle time by station",
xlabel="Station",
ylabel="Hours per cycle",
)
ax.grid(axis="y")
plt.tight_layout()
plt.show()
| station | tasks | load_h | idle_h | |
|---|---|---|---|---|
| 0 | 1 | A,B | 5.5 | 1.5 |
| 1 | 2 | C,D | 4.4 | 2.6 |
| 2 | 3 | E,F | 4.9 | 2.1 |
| 3 | 4 | G,H | 5.0 | 2.0 |

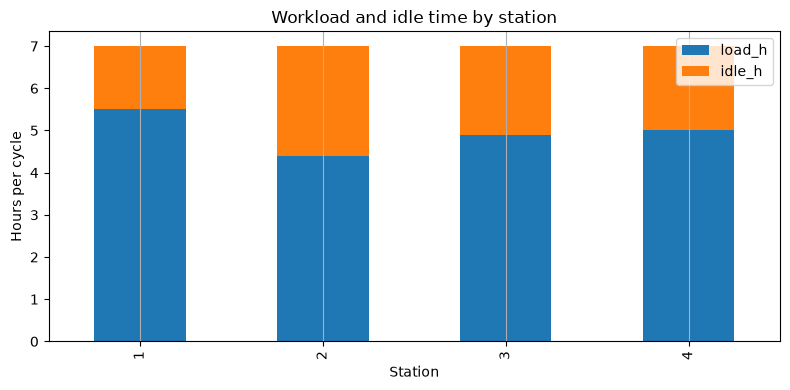

Line efficiency: 70.7%

Reading the results
Rather than blaming only low-load processes, we check precedence relationships, whether work can be split, and limitations of skills and jigs. Since shortening cycle times gradually increases the number of required processes, personnel and efficiency are evaluated according to demand scenarios.
No.095: Personnel Allocation Optimization
Meaning in Practice
While meeting the daily required number of people, we decide on work patterns and personnel costs. Not only the number of people, but also skills, qualifications, continuous working hours, desired leave, and fairness all determine feasibility.
Approach to Analysis and Modeling
Let be the number of workers assigned to pattern , and let indicate whether that pattern covers day . Minimize subject to . Enumerate the integer choices for this small example.
Check with Python
days = ["Mon", "Tue", "Wed", "Thu", "Fri", "Sat", "Sun"]
patterns = {
"Weekday": [1, 1, 1, 1, 1, 0, 0],
"Early": [1, 1, 1, 0, 0, 1, 1],
"Late": [0, 0, 1, 1, 1, 1, 1],
"Weekend": [0, 0, 0, 0, 0, 1, 1],
}
required = np.array([6, 7, 8, 8, 7, 5, 4])
costs = np.array([210, 205, 215, 90])
A = np.array(list(patterns.values())).T
candidates = []
for x in itertools.product(range(10), repeat=4):
cov = A @ x
if np.all(cov >= required):
candidates.append((costs @ x, *x, *cov))
best = min(candidates)
staffing_cost = best[0]
x = np.array(best[1:5])
coverage = A @ x

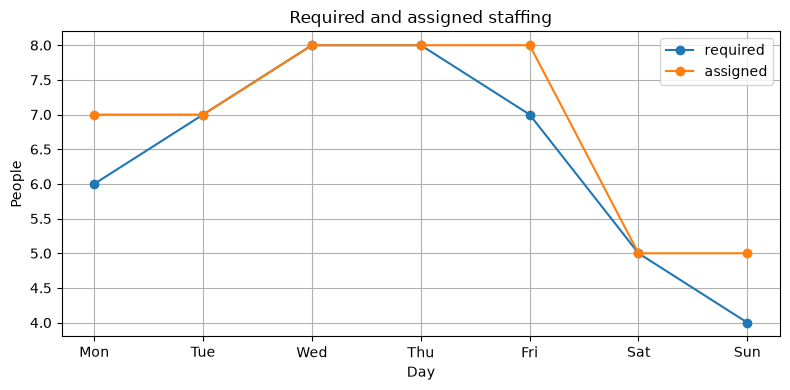

display(
pd.DataFrame({"pattern": list(patterns), "staff": x, "weekly_cost_kJPY": x * costs})
)
display(
pd.DataFrame(
{
"day": days,
"required": required,
"assigned": coverage,
"surplus": coverage - required,
}
)
)
ax = pd.DataFrame({"required": required, "assigned": coverage}, index=days).plot(
marker="o"
)
ax.set(title="Required and assigned staffing", xlabel="Day", ylabel="People")
ax.grid(True)
plt.tight_layout()
plt.show()
| pattern | staff | weekly_cost_kJPY | |
|---|---|---|---|
| 0 | Weekday | 7 | 1470 |
| 1 | Early | 0 | 0 |
| 2 | Late | 1 | 215 |
| 3 | Weekend | 4 | 360 |
| day | required | assigned | surplus | |
|---|---|---|---|---|
| 0 | Mon | 6 | 7 | 1 |
| 1 | Tue | 7 | 7 | 0 |
| 2 | Wed | 8 | 8 | 0 |
| 3 | Thu | 8 | 8 | 0 |
| 4 | Fri | 7 | 8 | 1 |
| 5 | Sat | 5 | 5 | 0 |
| 6 | Sun | 4 | 5 | 1 |

Reading the results
The selected pattern counts meet every day’s requirement at minimum cost in the candidate set. Surplus is a side effect of integer work patterns and can be used for education and maintenance support. In actual operations, before directly optimizing individual names, labor regulations, qualifications for substitutability, fairness agreements, and accountability are established.
No.096: Inventory Optimization
Meaning in Practice
Inventory prevents stockouts while consuming funds, storage space, and the risk of obsolescence. It determines not only average demand but also safety stock for demand fluctuations during lead times.
Approach to Analysis and Modeling
For independent, identically distributed daily demand with mean , standard deviation , and fixed lead time , lead-time demand has mean and standard deviation . Under a normal approximation, continuous review, and negligible reorder-point undershoot, use . Here is the standard-normal quantile for the target cycle service level, which differs from a unit fill rate.
Check with Python
mu_d, sigma_d, L = 40, 9, 5
service_table = pd.DataFrame(
{"service_level": [0.90, 0.95, 0.975, 0.99], "z": [1.282, 1.645, 1.960, 2.326]}
)
service_table["safety_stock"] = service_table.z * sigma_d * np.sqrt(L)
service_table["reorder_point"] = mu_d * L + service_table.safety_stock
display(
service_table.round(
{"service_level": 3, "z": 3, "safety_stock": 1, "reorder_point": 1}
)
)
ax = service_table.plot(x="service_level", y="safety_stock", marker="o")
ax.set(
title="Service level and safety stock",
xlabel="Cycle service level",
ylabel="Safety stock (units)",
)
ax.grid(True)
plt.tight_layout()
plt.show()

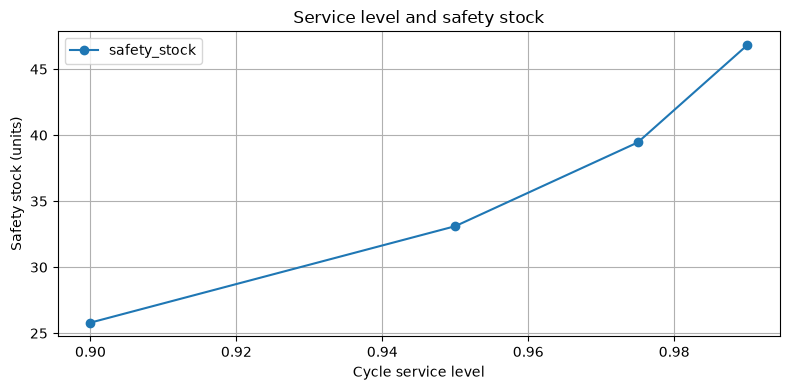

| service_level | z | safety_stock | reorder_point | |
|---|---|---|---|---|
| 0 | 0.900 | 1.282 | 25.8 | 225.8 |
| 1 | 0.950 | 1.645 | 33.1 | 233.1 |
| 2 | 0.975 | 1.960 | 39.4 | 239.4 |
| 3 | 0.990 | 2.326 | 46.8 | 246.8 |

Reading the results
The higher the service rate, the more nonlinear the safety stock increases. The choice is not about “higher is better,” but about comparing the impact of a single out-of-stock item with inventory costs. If there are significant differences in demand autocorrelation, lead time fluctuations, or carryover or lost orders during out-of-stock situations, we verify them through simulation rather than simple formulas.
No.097: Order Volume Optimization
Meaning in Practice
Small orders reduce average inventory but increase the number of orders, acceptances, and inspections. Bulk orders are the opposite. From this trade-off, the base lot is determined.
Approach to Analysis and Modeling
Assume constant demand, no shortages, and replenishment of a full order at once. With annual demand , ordering cost , and annual holding cost per unit , economic order quantity is . The relevant annual cost is ; purchasing cost is omitted because it does not depend on order size.
Check with Python
D, S, H = 12000, 18, 1.8
q_star = np.sqrt(2 * D * S / H)
q = np.arange(100, 1001, 10)
ordering = D / q * S
holding = q / 2 * H
total = ordering + holding
print(
f"EOQ: {q_star:.0f} units / relevant annual cost: {D/q_star*S+q_star/2*H:.1f} kJPY"
)
fig, ax = plt.subplots()
ax.plot(q, ordering, label="Ordering")
ax.plot(q, holding, label="Holding")
ax.plot(q, total, label="Total")
ax.axvline(q_star, color="black", ls="--", label="EOQ")
ax.set(
title="Economic order quantity",
xlabel="Order quantity",
ylabel="Annual relevant cost (kJPY)",
)
ax.grid(True)
ax.legend()
plt.tight_layout()
plt.show()

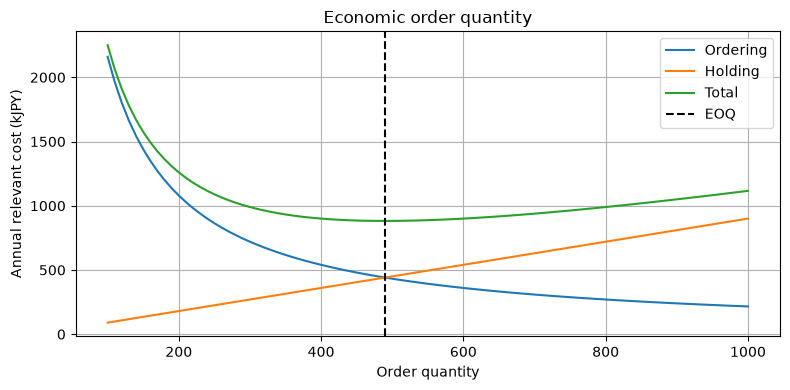

EOQ: 490 units / relevant annual cost: 881.8 kJPY

Reading the results
The total cost curve is relatively flat near the optimal point. Therefore, instead of using EOQ as an absolute value, you can compare nearby candidates by packaging unit, minimum order quantity, onboard efficiency, and storage ceiling. If there is a quantity discount, the price will be evaluated by price boundary, including the purchase cost.
No.098: Capital Investment Optimization
Meaning in Practice
Within the budget, select projects such as capacity enhancement, automated inspection, energy saving, and transport improvements. The payback years of individual projects alone cannot handle budget conflicts or set effects.
Approach to Analysis and Modeling
the acceptance or rejection of Project , the investment amount is set as , NPV as , and and . Furthermore, a dependency constraint of “automatic transport only when capacity enhancement is adopted” is applied to evaluate all combinations.
Check with Python
invest = pd.DataFrame(
{
"project": ["Capacity", "AutoInspection", "Energy", "AMR", "PredictiveMaint"],
"cost": [55, 32, 24, 28, 18],
"npv": [78, 47, 31, 44, 25],
}
)
budget = 90
opts = []
for y in itertools.product([0, 1], repeat=len(invest)):
y = np.array(y)
cost = y @ invest.cost
value = y @ invest.npv
if cost <= budget and y[3] <= y[0]:
opts.append((value, cost, y))
value, cost, y = max(opts, key=lambda z: z[0])
result = invest.copy()
result["selected"] = y.astype(bool)
display(result)
print(f"Total cost: {cost} / Budget: {budget} / Total NPV: {value}")
ax = result.plot.bar(x="project", y=["cost", "npv"])
ax.set(
title="Investment candidates and selected portfolio",
xlabel="Project",
ylabel="Million JPY",
)
for i, v in enumerate(y):
if v:
ax.text(i, max(result.loc[i, ["cost", "npv"]]) + 2, "SELECT", ha="center")
ax.grid(axis="y")
plt.tight_layout()
plt.show()

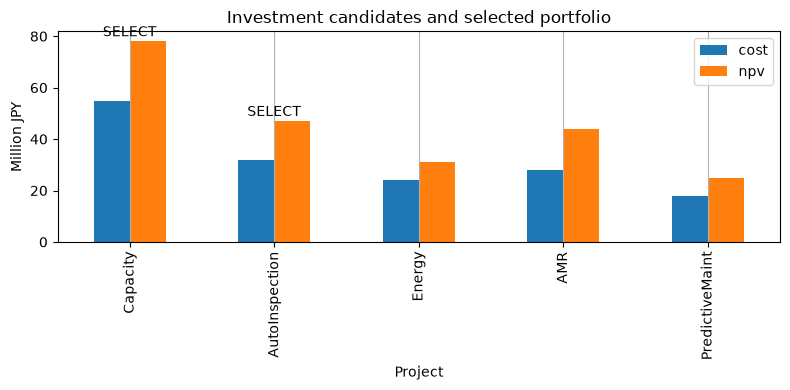

| project | cost | npv | selected | |
|---|---|---|---|---|
| 0 | Capacity | 55 | 78 | True |
| 1 | AutoInspection | 32 | 47 | True |
| 2 | Energy | 24 | 31 | False |
| 3 | AMR | 28 | 44 | False |
| 4 | PredictiveMaint | 18 | 25 | False |
Total cost: 87 / Budget: 90 / Total NPV: 125

Reading the results
The selection results simultaneously meet budget and dependencies. We check not only a single NPV estimate but also whether rankings change in scenarios such as decreased demand, launch delays, and residual value. Even if there is an unspent budget, it is not necessarily abnormal because it is a discrete project.
No.099: Integration of Simulation and Optimization
Meaning in Practice
Optimal inventory policies based on average demand can frequently cause stockouts under fluctuating conditions. Candidate policies are compared across many identical demand scenarios and selected from both cost and service perspectives.
Approach to Analysis and Modeling
Candidate order points and order quantities are selected, and daily inventory is simulated in Monte Carlo. The objective is average storage cost + order cost + out-of-stock penalty. Common random numbers are used to suppress comparison noise between candidates.
Check with Python
# Use identical demand paths for all candidates; unmet demand is lost sales.
scenarios = rng.poisson(40, size=(120, 180))
lead = 5
def inventory_policy(r, Q):
costs = []
stockout_days = []
for demand_path in scenarios:
onhand = r + Q
arrivals = {}
cost = 0
so = 0
for day, d in enumerate(demand_path):
onhand += arrivals.get(day, 0)
sold = min(onhand, d)
lost = d - sold
onhand -= sold
so += lost > 0
cost += 0.003 * onhand + 0.12 * lost
pipeline = sum(v for k, v in arrivals.items() if k > day)
if onhand + pipeline <= r:
arrivals[day + lead] = arrivals.get(day + lead, 0) + Q
cost += 18
costs.append(cost)
stockout_days.append(so / len(demand_path))
return np.mean(costs), np.quantile(costs, 0.95), np.mean(stockout_days)
rows = []
for r in [180, 200, 220, 240, 260]:
for Q in [300, 450, 600, 750]:
rows.append((r, Q, *inventory_policy(r, Q)))
policies = pd.DataFrame(
rows,
columns=[
"reorder_point",
"order_qty",
"mean_cost",
"p95_cost",
"stockout_day_rate",
],
)
best = policies.loc[policies.mean_cost.idxmin()]
display(policies.sort_values("mean_cost").head(8).round(3))

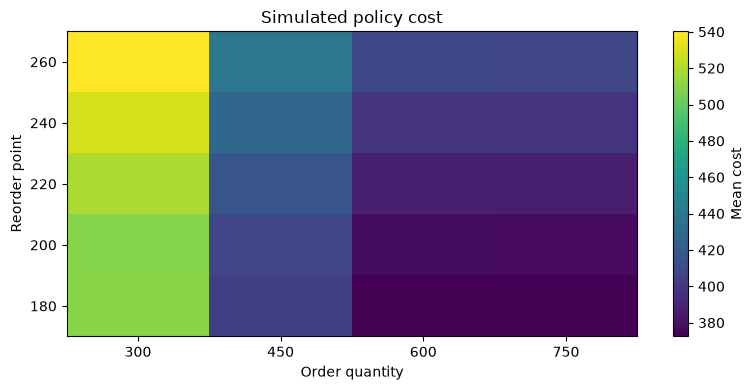

pivot = policies.pivot(index="reorder_point", columns="order_qty", values="mean_cost")
fig, ax = plt.subplots()
im = ax.imshow(pivot, aspect="auto", origin="lower")
fig.colorbar(im, ax=ax, label="Mean cost")
ax.set_xticks(range(len(pivot.columns)), pivot.columns)
ax.set_yticks(range(len(pivot.index)), pivot.index)
ax.set(title="Simulated policy cost", xlabel="Order quantity", ylabel="Reorder point")
ax.grid(False)
plt.tight_layout()
plt.show()
| reorder_point | order_qty | mean_cost | p95_cost | stockout_day_rate | |
|---|---|---|---|---|---|
| 2 | 180 | 600 | 372.401 | 387.116 | 0.029 |
| 3 | 180 | 750 | 373.321 | 377.966 | 0.023 |
| 7 | 200 | 750 | 377.349 | 381.652 | 0.007 |
| 6 | 200 | 600 | 378.014 | 388.077 | 0.008 |
| 11 | 220 | 750 | 386.794 | 390.855 | 0.001 |
| 10 | 220 | 600 | 387.471 | 397.669 | 0.001 |
| 15 | 240 | 750 | 397.487 | 401.655 | 0.000 |
| 14 | 240 | 600 | 398.173 | 408.469 | 0.000 |

Reading the results
The first row has the lowest mean cost among these 20 policies on 120 scenarios of 180 days. The 95% cost is the scenario-cost 95th percentile, and stockout-day rate is the fraction of days with a shortage. Each policy starts with inventory, shortages are lost sales, and terminal inventory and outstanding orders are not settled. For steady-state comparisons, add a warm-up period and evaluate on independent scenarios.
No.100: Suri Kobo’s Decision-Making Engine
Meaning in Practice
Value is not created by algorithms alone; it only emerges through a cycle of data acquisition, candidate generation, constraint validation, approval, execution, and performance learning. We will create a system where people can identify exceptions and track the reasons for recommendations.
Approach to Analysis and Modeling
Design the decision engine as a closed loop for Observe → Predict → Optimize → Simulate → Approve → Execute → Learn. Recommendations consolidate not only benefits but also constraint violations, risks, differences from current proposals, and reasons for adoption or rejection into one record.
Check with Python
decision_record = pd.DataFrame(
[
[
"Production plan",
-r91.fun,
"All resource use <= capacity",
"Approve if rounded plan remains feasible",
],
[
"Staffing",
-staffing_cost,
"Assigned >= required",
"Supervisor reviews skills",
],
[
"Inventory policy",
-float(policies.mean_cost.min()),
"Stockout-day rate monitored",
"Approve after shadow operation",
],
[
"Investment portfolio",
value,
"Cost <= budget; dependencies",
"Board approves scenario assumptions",
],
],
columns=["decision", "objective_or_value", "guardrail", "human_gate"],
)
decision_record["unit_and_period"] = [
"kJPY/month",
"kJPY/week",
"kJPY/180 days",
"million JPY (NPV)",
]
decision_record["run_id"] = "DI-2026-07-001"
decision_record["data_version"] = "synthetic-v1"
display(decision_record)
stages = pd.DataFrame(
{
"stage": [
"Observe",
"Predict",
"Optimize",
"Simulate",
"Approve",
"Execute",
"Learn",
],
"owner": [
"Data",
"Planning",
"OR",
"Risk",
"Manager",
"Operations",
"Analytics",
],
}
)
fig, ax = plt.subplots(figsize=(10, 2.5))
ax.scatter(range(len(stages)), np.zeros(len(stages)), s=900)
for i, r in stages.iterrows():
ax.text(i, 0, f"{r.stage}\n({r.owner})", ha="center", va="center", fontsize=8)
ax.plot(range(len(stages)), np.zeros(len(stages)))
ax.set(title="Decision Intelligence operating loop", xlabel="Stage", ylabel="Workflow")
ax.set_yticks([])
ax.grid(axis="x")
plt.tight_layout()
plt.show()
| decision | objective_or_value | guardrail | human_gate | unit_and_period | run_id | data_version | |
|---|---|---|---|---|---|---|---|
| 0 | Production plan | 8573.7500 | All resource use <= capacity | Approve if rounded plan remains feasible | kJPY/month | DI-2026-07-001 | synthetic-v1 |
| 1 | Staffing | -2045.0000 | Assigned >= required | Supervisor reviews skills | kJPY/week | DI-2026-07-001 | synthetic-v1 |
| 2 | Inventory policy | -372.4009 | Stockout-day rate monitored | Approve after shadow operation | kJPY/180 days | DI-2026-07-001 | synthetic-v1 |
| 3 | Investment portfolio | 125.0000 | Cost <= budget; dependencies | Board approves scenario assumptions | million JPY (NPV) | DI-2026-07-001 | synthetic-v1 |

Reading the results
Record the input version, objective, units, checks, and reviewer under the same run_id. Staffing and inventory costs are negated so larger values are better, but rows cannot be added: their monetary units and time horizons differ. This code illustrates record keeping; it does not implement approval or execution.
Practical implications
- Production, schedules, personnel, inventory, and investment need to be connected by a common demand assumption and capability master.
- Before the optimal value, agree on the unit of the objective function, the absolute constraints to be observed, and the desired conditions.
- Showing differences from current proposals, alternatives, sensitivity, and constraint margins makes it easier for the field to make judgments.
- The impact of forecasting errors on decision-making is examined through scenarios or simulations.
- Manual revisions to recommended proposals are not failures but important logs for discovering unmodeled constraints.
Putting the model into practice
| Topic | Checks | Deliverable |
|---|---|---|
| Business Definition | Who decides, when, and what | Decision Flow, RACI |
| Data | Alignment of demand, capabilities, BOM, inventory, and skills at the time | Data Dictionary, Quality Reports |
| Mathematical model | Purpose, constraints, granularity, calculation time | Model Specifications and Test Cases |
| verification | Comparison with current proposals, past performance, and stress conditions | Effectiveness Verification and Sensitivity Analysis |
| Utilization | Replanning conditions, approvals, and alternative procedures in case of failure | Operational procedures and monitoring metrics |
| control | Tracking input versions, recommendations, corrections, and approvals | Audit Logs and Change Management |
Implementation starts with small decisions, then uses shadow operations to compare with human plans, fixes loopholes in constraints, and then expands the scope of application.
Conclusion
From No.091 to No.100, individual optimizations were integrated into the manufacturing decision-making loop. A good model is not a complex one, but one that meets the constraints of the field, explains the reasons for results, and can be updated based on actual experience. It is practical to start by reproducing current decisions targeting one factory, one meeting body, and one KPI.
Business inquiries
At Suri Kobo, we offer consultations on production planning, scheduling, inventory and ordering, staffing, capital investment, including problem organization, PoC, model development, integration with existing systems, and support for maintaining the models in-house.
📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
