100 Exercises / anomaly detection / Abnormality detection: 100 Exercises

Anomaly Detection Evaluation in Python | Metrics, Thresholds and Alert Design

Evaluate anomaly scores with precision, recall, F1, ROC-AUC and AP, then set cost-based thresholds, daily workloads, priorities and notification rules.

Turning Equipment Anomalies into Actionable Alerts: Evaluation and Alert Design

Anomaly detection models do not create value on site simply by producing anomaly scores. This article uses equipment monitoring at a fictional processing plant as a subject, treating Indicators for measuring model quality and Which alerts should the limited maintenance man-hours be assigned to? as a single decision-making issue. The target is No.081 to No.090.

About this material This article adapts notebooks used in corporate training by Surikobo or its representative, Hiroshi Wayama, and is published with permission from the client companies.
All data listed is fictional and has no relation whatsoever to real companies, factories, or figures.

Introduction: Practical Challenges in Manufacturing Covered in This Article

Imagine a factory where anomaly scores are sent every 5 minutes from processing equipment. There are few true signs of failure, and there is an upper limit to inspection capacity. What is needed in this situation is not only a “highly accurate model,” but also operational design that simultaneously considers downtime due to missed detections, inspection man-hours due to false positives, the importance of the equipment, and response deadlines.

The goal of this article is not to report technical indicators. It’s about creating a state where Which threshold is used, how many alerts result, and who checks them in what order? can be explained.

Common situations on site

  • Anomalies make up only a few percent of observations, so a detector that always predicts normal can still have high accuracy.
  • As false positives increase, inspectors lose trust in alerts.
  • Missed anomalies can lead to sudden stoppages, work-in-progress disposal, and delivery delays, but losses vary by equipment
  • Even with the same abnormal score, the order of response differs between critical and auxiliary equipment.
  • Model evaluation and on-site alert management tables are separated.

Why is this issue so difficult to judge?

Raising the threshold shrinks the alert set, so false-positive counts and recall cannot increase. Precision depends on the ordering of normal and anomalous scores and need not increase monotonically. F1, ROC-AUC and PR summaries do not directly specify staffing or cost, so also examine counts and operational costs.

Exercises covered in this article

No.ThemeConnecting to decision-making
081Evaluation IndicatorsCreating a Comprehensive Picture of Judgment from Confusion Matrices
082Precision/RecallBalancing false positives and missed spots
083F1 ScoreComparing the two using a single metric
084ROC-AUCCheck the identification order by full threshold
085PR-AUCSee effective performance against rare anomalies
086False positives and missed costsTranslate technical errors into amounts
087Threshold optimizationChoose operating thresholds with lower expected costs
088Number of alertsUnderstand daily and line loads
089priorityDecide the order of response based on importance and urgency
090On-site Operation DesignSetting SLAs, Notification Suppression, and Escalation

Preparing the Python environment

No external data is used; only NumPy, pandas, Matplotlib, and scikit-learn are used. Fix the random number seed so you can reproduce the same result. To avoid environment-dependent garbled text, the graphs are displayed in English, and the accompanying text explains how to read them.

Run the cells from top to bottom in Jupyter Notebook. [IN: n] identifies an input and [OUT: n] its output. Setup code and output are collapsed below.

Show environment setup code and output
[IN: 1]
import sys
import numpy as np
import pandas as pd
from IPython.display import display
import matplotlib
import matplotlib.pyplot as plt

from sklearn.metrics import (
    confusion_matrix,
    precision_score,
    recall_score,
    f1_score,
    roc_curve,
    roc_auc_score,
    precision_recall_curve,
    average_precision_score,
)

SEED = 202509
rng = np.random.default_rng(SEED)
pd.set_option("display.max_columns", 20)
pd.set_option("display.float_format", lambda x: f"{x:,.3f}")

print("Python     :", sys.version.split()[0])
print("NumPy      :", np.__version__)
print("pandas     :", pd.__version__)
print("Matplotlib :", matplotlib.__version__)
[OUT: 1]
Python     : 3.14.4
NumPy      : 2.5.1
pandas     : 3.0.3
Matplotlib : 3.11.0

Creation of Fictional Data

Although the operational scenario scores every five minutes, the teaching dataset contains 1,200 decision records spaced 36 minutes apart over 30 days to keep the example manageable. Each record is assigned to one of six machines on three lines. actual_anomaly is the reviewed label, while anomaly_score is an anomaly score between 0 and 1, not a failure probability.

Show synthetic data generation code and output
[IN: 2]
n = 1200
timestamps = pd.date_range("2025-01-01", periods=n, freq="36min")
lines = rng.choice(["Line-A", "Line-B", "Line-C"], n, p=[0.40, 0.35, 0.25])
machines = np.array([f"{line}-M{rng.integers(1, 3)}" for line in lines])
actual = rng.binomial(1, 0.06, n)

# Partial overlap of normal and abnormal distributions creates situations where complete distinction cannot be made
score = np.where(actual == 1, rng.beta(5.0, 2.2, n), rng.beta(1.5, 6.0, n))
score = np.clip(score + np.where(lines == "Line-C", 0.025, 0), 0, 1)
criticality = np.where(lines == "Line-A", 3, np.where(lines == "Line-B", 2, 1))
impact_k_yen = criticality * rng.integers(
    350, 701, n
)  # Suspension impact (thousand yen)
elapsed_min = rng.integers(5, 181, n)

df = pd.DataFrame(
    {
        "timestamp": timestamps,
        "line": lines,
        "machine": machines,
        "actual_anomaly": actual,
        "anomaly_score": score,
        "criticality": criticality,
        "impact_k_yen": impact_k_yen,
        "elapsed_min": elapsed_min,
    }
)
df["date"] = df["timestamp"].dt.date

print(
    f"Number of observations: {len(df):,}records / True anomaly: {df['actual_anomaly'].sum():,}records "
    f"({df['actual_anomaly'].mean():.1%})"
)
display(df.head())
[OUT: 2]
Number of observations: 1,200records / True anomaly: 64records (5.3%)
timestamp line machine actual_anomaly anomaly_score criticality impact_k_yen elapsed_min date
0 2025-01-01 00:00:00 Line-B Line-B-M2 0 0.253 2 962 10 2025-01-01
1 2025-01-01 00:36:00 Line-C Line-C-M2 0 0.367 1 622 98 2025-01-01
2 2025-01-01 01:12:00 Line-A Line-A-M2 1 0.610 3 1761 177 2025-01-01
3 2025-01-01 01:48:00 Line-A Line-A-M1 0 0.264 3 1059 25 2025-01-01
4 2025-01-01 02:24:00 Line-A Line-A-M2 0 0.113 3 1098 20 2025-01-01
[IN: 3]

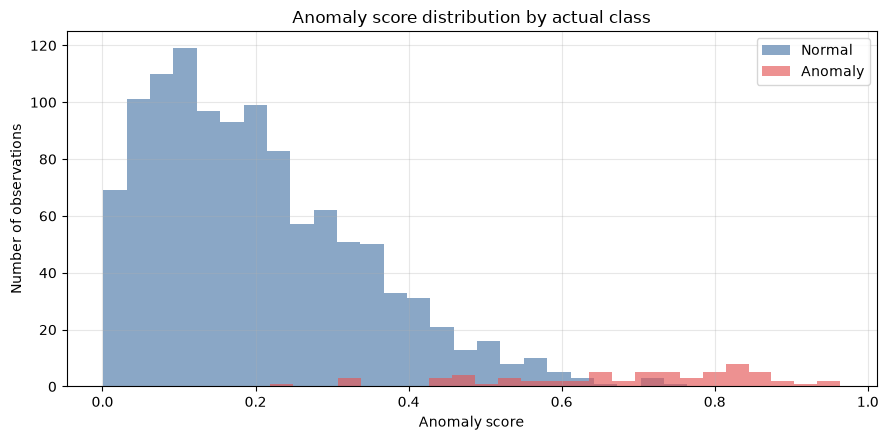

fig, ax = plt.subplots(figsize=(9, 4.5))
ax.hist(
    df.loc[df["actual_anomaly"] == 0, "anomaly_score"],
    bins=25,
    alpha=0.65,
    label="Normal",
    color="#4C78A8",
)
ax.hist(
    df.loc[df["actual_anomaly"] == 1, "anomaly_score"],
    bins=25,
    alpha=0.65,
    label="Anomaly",
    color="#E45756",
)
ax.set_title("Anomaly score distribution by actual class")
ax.set_xlabel("Anomaly score")
ax.set_ylabel("Number of observations")
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()
[OUT: 3]

Creation of Fictional Data

No.081: Organizing Evaluation Indicators for Anomaly Detection

Practical purpose

Compare predictions with reviewed outcomes using TP (true positive), FP (false positive), FN (false negative) and TN (true negative). False positives create unnecessary inspections, while false negatives can leave failure precursors unaddressed. Share these counts alongside accuracy.

Analysis and modeling

Set the threshold to tt and the score si≥ts_i \ge t as an alert. The representative indicators are as follows.

Accuracy=TP+TNTP+FP+FN+TN\mathrm{Accuracy}=\frac{TP+TN}{TP+FP+FN+TN} Precision=TPTP+FP,Recall=TPTP+FN\mathrm{Precision}=\frac{TP}{TP+FP},\qquad \mathrm{Recall}=\frac{TP}{TP+FN}

First, set the provisional threshold of 0.50 to create an evaluation table.

Check with Python

[IN: 4]
def metrics_at_threshold(data, threshold):
    y_true = data["actual_anomaly"].to_numpy()
    y_pred = (data["anomaly_score"].to_numpy() >= threshold).astype(int)
    tn, fp, fn, tp = confusion_matrix(y_true, y_pred, labels=[0, 1]).ravel()
    return {
        "threshold": threshold,
        "TP": tp,
        "FP": fp,
        "FN": fn,
        "TN": tn,
        "precision": precision_score(y_true, y_pred, zero_division=0),
        "recall": recall_score(y_true, y_pred, zero_division=0),
        "f1": f1_score(y_true, y_pred, zero_division=0),
        "accuracy": (tp + tn) / len(y_true),
    }


base = metrics_at_threshold(df, 0.50)
display(pd.DataFrame([base]))
display(
    pd.DataFrame(
        [[base["TN"], base["FP"]], [base["FN"], base["TP"]]],
        index=["Actual normal", "Actual anomaly"],
        columns=["Predicted normal", "Predicted alert"],
    )
)
[OUT: 4]
threshold TP FP FN TN precision recall f1 accuracy
0 0.500 53 41 11 1095 0.564 0.828 0.671 0.957
Predicted normal Predicted alert
Actual normal 1095 41
Actual anomaly 11 53

Reading the results

At threshold 0.50, there are 53 true positives, 41 false positives and 11 false negatives. The 94 alerts create inspection work, while the 11 missed anomalies require attention even though accuracy is 0.957. The confusion matrix makes these trade-offs visible.

No.082: Confirm Precision Recall

Practical purpose

Precision is about “how much is truly abnormal when an alert is activated,” which relates to on-site trust and inspection efficiency. Recall refers to “how much actual anomaly has been detected,” and relates to the strength of the maintenance safety net.

Analysis and modeling

Lowering the threshold can increase recall and alert counts or leave them unchanged. Precision often falls, but it is not guaranteed to change monotonically. Compare both metrics and actual counts at each candidate threshold.

Check with Python

[IN: 5]
thresholds = np.arange(0.20, 0.86, 0.05)
tradeoff = pd.DataFrame([metrics_at_threshold(df, t) for t in thresholds])
tradeoff["alerts"] = tradeoff["TP"] + tradeoff["FP"]
display(tradeoff[["threshold", "precision", "recall", "alerts"]].round(3))

fig, ax = plt.subplots(figsize=(8, 4.5))
ax.plot(tradeoff["threshold"], tradeoff["precision"], marker="o", label="Precision")

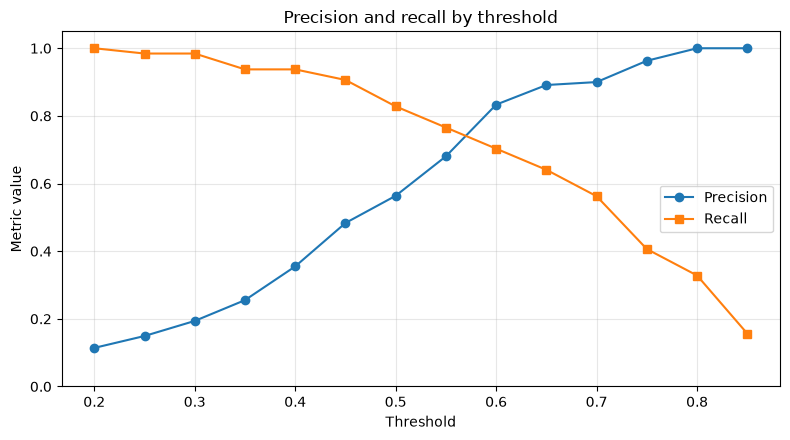

ax.plot(tradeoff["threshold"], tradeoff["recall"], marker="s", label="Recall")
ax.set_title("Precision and recall by threshold")
ax.set_xlabel("Threshold")
ax.set_ylabel("Metric value")
ax.set_ylim(0, 1.05)
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()
[OUT: 5]
threshold precision recall alerts
0 0.200 0.114 1.000 561
1 0.250 0.149 0.984 422
2 0.300 0.194 0.984 325
3 0.350 0.255 0.938 235
4 0.400 0.355 0.938 169
5 0.450 0.483 0.906 120
6 0.500 0.564 0.828 94
7 0.550 0.681 0.766 72
8 0.600 0.833 0.703 54
9 0.650 0.891 0.641 46
10 0.700 0.900 0.562 40
11 0.750 0.963 0.406 27
12 0.800 1.000 0.328 21
13 0.850 1.000 0.156 10

No.082: Confirm Precision Recall

Reading the results

A low threshold reduces missed cases but also generates numerous false positives. A higher threshold reduces the number of inspections but can miss more anomalies; precision must be checked at each threshold. In factories, specifying safety-side constraints such as “Recall 90% or higher” with processing capacity constraints like “no more than 10 cases per day” can make the discussion more concrete.

No.083: Check F1 Score

Practical purpose

F1 is the harmonic mean of precision and recall and treats those two metrics symmetrically. It is useful for comparing models or thresholds, but it neither assigns equal monetary losses to individual false positives and false negatives nor directly models those costs.

Analysis and modeling

F1=2Precision×RecallPrecision+RecallF_1=2\frac{\mathrm{Precision}\times\mathrm{Recall}} {\mathrm{Precision}+\mathrm{Recall}}

If either is lower, F1 will also be low. Check the most important points among the candidates.

Check with Python

[IN: 6]
f1_best = tradeoff.loc[tradeoff["f1"].idxmax()]
display(tradeoff[["threshold", "precision", "recall", "f1"]].round(3))
print(
    f"under candidateF1largest: threshold={f1_best['threshold']:.2f}, "
    f"F1={f1_best['f1']:.3f}"
)

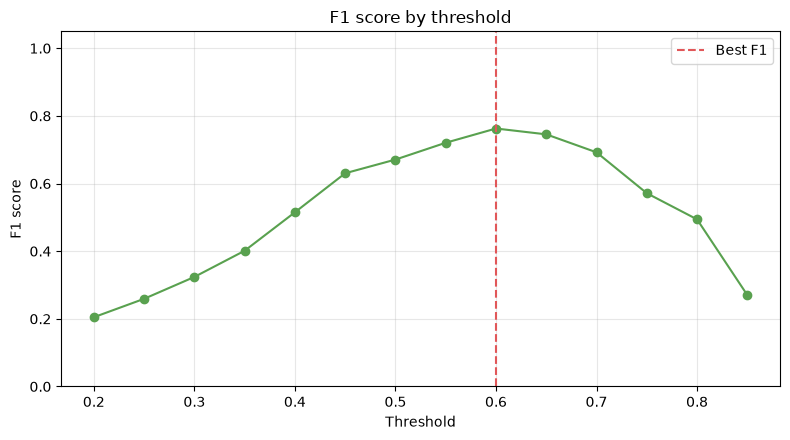

fig, ax = plt.subplots(figsize=(8, 4.5))
ax.plot(tradeoff["threshold"], tradeoff["f1"], marker="o", color="#59A14F")
ax.axvline(f1_best["threshold"], linestyle="--", color="#E15759", label="Best F1")
ax.set_title("F1 score by threshold")
ax.set_xlabel("Threshold")
ax.set_ylabel("F1 score")
ax.set_ylim(0, 1.05)
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()
[OUT: 6]
threshold precision recall f1
0 0.200 0.114 1.000 0.205
1 0.250 0.149 0.984 0.259
2 0.300 0.194 0.984 0.324
3 0.350 0.255 0.938 0.401
4 0.400 0.355 0.938 0.515
5 0.450 0.483 0.906 0.630
6 0.500 0.564 0.828 0.671
7 0.550 0.681 0.766 0.721
8 0.600 0.833 0.703 0.763
9 0.650 0.891 0.641 0.745
10 0.700 0.900 0.562 0.692
11 0.750 0.963 0.406 0.571
12 0.800 1.000 0.328 0.494
13 0.850 1.000 0.156 0.270
under candidateF1largest: threshold=0.60, F1=0.763

No.083: Check F1 Score

Reading the results

The F1 maximum point is useful as a statistical baseline. However, in factories where the stop loss is orders of magnitude greater than inspection costs, a threshold lower than the F1 maximum point may be reasonable. F1 serves as a “narrowing indicator” for narrowing down candidates, while cost evaluation is a “metric for determining operating thresholds.”

No.084: Checking ROC-AUC

Practical purpose

ROC-AUC can be interpreted as the probability that a randomly chosen anomaly scores above a randomly chosen normal observation, plus half the probability of a tie. It measures ranking ability before a particular decision threshold is selected.

Analysis and modeling

The ROC curve plots the false positive rate FPR=FP/(FP+TN)FPR=FP/(FP+TN) and the true positive rate (Recall) at full thresholds. The closer the AUC is to 1, the better the ranking, and 0.5 is equivalent to a random result. However, when abnormalities are rare, note that the FPR appears small due to a large number of TNs.

Check with Python

[IN: 7]
y_true = df["actual_anomaly"].to_numpy()
y_score = df["anomaly_score"].to_numpy()
fpr, tpr, roc_thresholds = roc_curve(y_true, y_score)
roc_auc = roc_auc_score(y_true, y_score)
print(f"ROC-AUC: {roc_auc:.3f}")

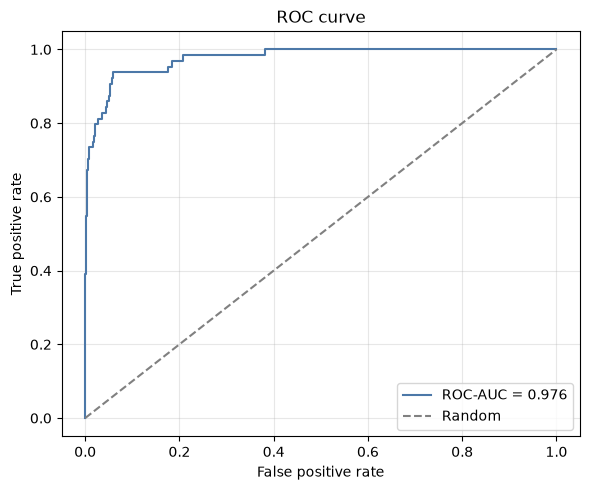

fig, ax = plt.subplots(figsize=(6, 5))
ax.plot(fpr, tpr, label=f"ROC-AUC = {roc_auc:.3f}", color="#4C78A8")
ax.plot([0, 1], [0, 1], linestyle="--", color="gray", label="Random")
ax.set_title("ROC curve")
ax.set_xlabel("False positive rate")
ax.set_ylabel("True positive rate")
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()
[OUT: 7]
ROC-AUC: 0.976

No.084: Checking ROC-AUC

Reading the results

A higher ROC-AUC means that prioritization based on scores is worth considering. However, AUC does not know how many false positives are generated per day. For anomaly detection with strong class imbalance, the following PR-AUC and actual case counts are always used together.

No.085: Check PR-AUC

Practical purpose

The PR curve directly represents the exchange between alert accuracy and anomaly recall. In manufacturing data where anomalies are rare, the evaluation makes it easier to imagine on-site loads than the ROC curve.

Analysis and modeling

We summarize the PR curve with Average Precision (AP), which weights precision by increments in recall. AP differs from the area calculated by trapezoidal integration of a PR curve. We show prevalence as a reference line and distinguish the metric name from its integration method.

Check with Python

[IN: 8]
precision_curve, recall_curve, pr_thresholds = precision_recall_curve(y_true, y_score)
average_precision = average_precision_score(y_true, y_score)
baseline = y_true.mean()
print(f"Average Precision (AP): {average_precision:.3f}")
print(f"Random Criteria (Anomaly Rate)      : {baseline:.3f}")

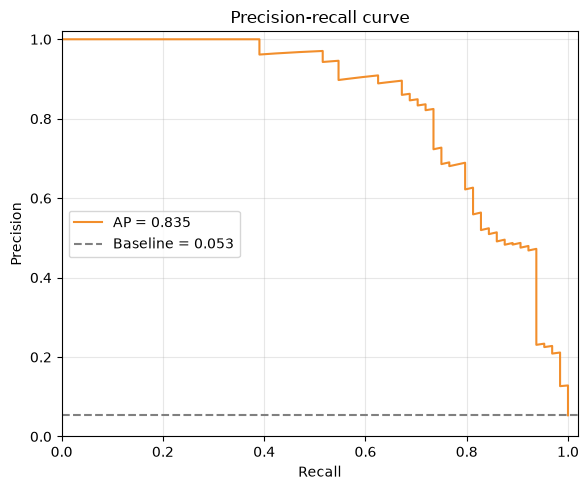

fig, ax = plt.subplots(figsize=(6, 5))
ax.plot(
    recall_curve,
    precision_curve,
    label=f"AP = {average_precision:.3f}",
    color="#F28E2B",
)
ax.axhline(baseline, linestyle="--", color="gray", label=f"Baseline = {baseline:.3f}")
ax.set_title("Precision-recall curve")
ax.set_xlabel("Recall")
ax.set_ylabel("Precision")
ax.set_xlim(0, 1.02)
ax.set_ylim(0, 1.02)
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()
[OUT: 8]
Average Precision (AP): 0.835
Random Criteria (Anomaly Rate)      : 0.053

No.085: Check PR-AUC

Reading the results

AP is 0.835 and prevalence is 0.053. Anomalies are concentrated near the top of this ranking, but AP does not determine an inspection workload. If only the top 50 observations can be reviewed, calculate their precision and anomaly count separately.

No.086: Organizing the Costs of False Positives and Missed Anomalies

Practical purpose

Even with the same case, FP causes inspection time, while FN causes stoppages, disposal, and delivery delays. When the margin of error is converted into amounts, manufacturing, maintenance, and management can discuss thresholds on the same scale.

Analysis and modeling

Let’s define a simple expected cost as follows.

C(t)=cFP FP(t)+cFN FN(t)+cTP TP(t)C(t)=c_{FP}\,FP(t)+c_{FN}\,FN(t)+c_{TP}\,TP(t)

cFPc_{FP} is the cost of unnecessary inspections, cFNc_{FN} is the missed loss, and cTPc_{TP} is the preventive inspection fee when the item is correctly detected. Here, we assume 20,000 yen, 800,000 yen, and 50,000 yen per case. In practice, it is further subdivided by the amount of downtime impact and safety impact by equipment type.

Check with Python

[IN: 9]
COST_FP = 20_000
COST_FN = 800_000
COST_TP = 50_000

cost_table = tradeoff.copy()
cost_table["false_alarm_cost_yen"] = cost_table["FP"] * COST_FP
cost_table["miss_cost_yen"] = cost_table["FN"] * COST_FN
cost_table["planned_check_cost_yen"] = cost_table["TP"] * COST_TP
cost_table["total_cost_yen"] = cost_table[
    ["false_alarm_cost_yen", "miss_cost_yen", "planned_check_cost_yen"]
].sum(axis=1)
display(
    cost_table[["threshold", "FP", "FN", "TP", "total_cost_yen"]].assign(
        total_cost_yen=lambda x: x["total_cost_yen"].map("¥{:,.0f}".format)
    )
)
[OUT: 9]
threshold FP FN TP total_cost_yen
0 0.200 497 0 64 ¥13,140,000
1 0.250 359 1 63 ¥11,130,000
2 0.300 262 1 63 ¥9,190,000
3 0.350 175 4 60 ¥9,700,000
4 0.400 109 4 60 ¥8,380,000
5 0.450 62 6 58 ¥8,940,000
6 0.500 41 11 53 ¥12,270,000
7 0.550 23 15 49 ¥14,910,000
8 0.600 9 19 45 ¥17,630,000
9 0.650 5 23 41 ¥20,550,000
10 0.700 4 28 36 ¥24,280,000
11 0.750 1 38 26 ¥31,720,000
12 0.800 0 43 21 ¥35,450,000
13 0.850 0 54 10 ¥43,700,000

Reading the results

Because the missed unit price is set high, even a small number of FNs have a significant impact on total costs. Even if the unit price is not a precise accounting value, you can confirm the robustness of decision-making by setting three scenarios: pessimism, standard, and optimism. Abnormalities related to safety or legal regulations are treated not only as monetary conversion but also as restrictions on the “Recall Lower Limit.”

No.087: Setting the threshold based on operational costs

Practical purpose

Thresholds are not parameters set solely by model developers. These are operational rules that reflect maintenance processing capacity, downtime losses, and safety requirements. It simultaneously indicates the minimum cost points and operational constraints, creating an approvable basis.

Analysis and modeling

Candidate thresholds are thoroughly scanned to minimize expected costs. We also check examples where a Recall rate of 85% or higher is mandatory. By optimizing with constraints, the design does not offset safety requirements at the cost of protection.

Check with Python

[IN: 10]
fine_thresholds = np.linspace(0.10, 0.90, 161)
optimization = pd.DataFrame([metrics_at_threshold(df, t) for t in fine_thresholds])
optimization["alerts"] = optimization["TP"] + optimization["FP"]
optimization["total_cost_yen"] = (
    optimization["FP"] * COST_FP
    + optimization["FN"] * COST_FN
    + optimization["TP"] * COST_TP
)
best_cost = optimization.loc[optimization["total_cost_yen"].idxmin()]
feasible = optimization[optimization["recall"] >= 0.85]
best_constrained = feasible.loc[feasible["total_cost_yen"].idxmin()]

display(
    pd.DataFrame(
        [best_cost, best_constrained],
        index=["Minimum cost", "Minimum cost with Recall >= 0.85"],
    )[["threshold", "precision", "recall", "f1", "alerts", "total_cost_yen"]].round(3)
)

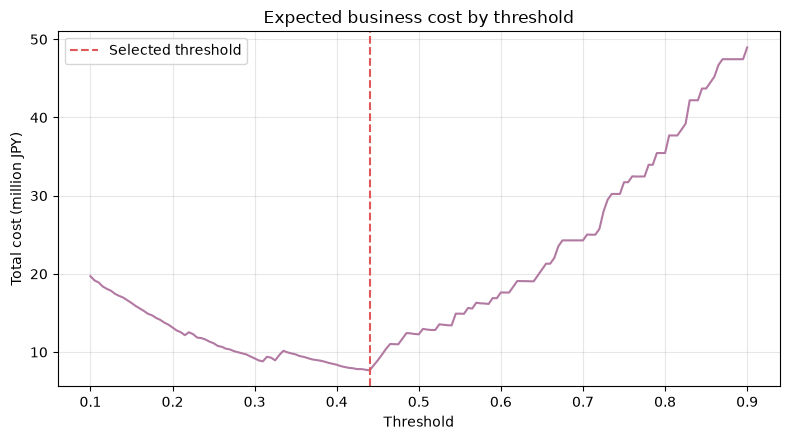

fig, ax = plt.subplots(figsize=(8, 4.5))
ax.plot(
    optimization["threshold"],
    optimization["total_cost_yen"] / 1_000_000,
    color="#B279A2",
)
ax.axvline(
    best_constrained["threshold"],
    linestyle="--",
    color="#E15759",
    label="Selected threshold",
)
ax.set_title("Expected business cost by threshold")
ax.set_xlabel("Threshold")
ax.set_ylabel("Total cost (million JPY)")
ax.grid(True, alpha=0.3)
ax.legend()
fig.tight_layout()
plt.show()

SELECTED_THRESHOLD = float(best_constrained["threshold"])
df["alert"] = (df["anomaly_score"] >= SELECTED_THRESHOLD).astype(int)
print(f"Adoption threshold: {SELECTED_THRESHOLD:.3f}")
[OUT: 10]
threshold precision recall f1 alerts total_cost_yen
Minimum cost 0.440 0.451 0.938 0.609 133.000 7,660,000.000
Minimum cost with Recall >= 0.85 0.440 0.451 0.938 0.609 133.000 7,660,000.000

No.087: Setting the threshold based on operational costs

Adoption threshold: 0.440

Reading the results

In this example, both the unconstrained search and the recall-at-least-85% search select 0.440, with recall 0.938. The constraint does not change the optimum. Because selection and reporting use the same data, this is a threshold-search demonstration. Evaluate cost and recall on a separate period before adoption.

No.088: Aggregating the Number of Alerts

Practical purpose

Even if the total number of cases is within an acceptable range, concentrating on a specific day or line will make it impossible to respond. Visualizes daily and line-by-line loads and connects them to shift personnel and patrol plans.

Analysis and modeling

Alerts are aggregated by date and line to detect days exceeding daily processing capacity. Here, we assume the standard processing capacity of 8 cases per day for the entire factory. The aggregation granularity is aligned with the assigned units assigned to actual operations.

Check with Python

[IN: 11]
daily_line = df[df["alert"] == 1].pivot_table(
    index="date", columns="line", values="alert", aggfunc="sum", fill_value=0
)
daily_line = daily_line.reindex(sorted(df["date"].unique()), fill_value=0)
daily_line["Total"] = daily_line.sum(axis=1)
DAILY_CAPACITY = 8
daily_line["Over capacity"] = daily_line["Total"] > DAILY_CAPACITY
display(daily_line.head(10))
print(
    f"Processing capacity exceeded date: {daily_line['Over capacity'].sum()}days / {len(daily_line)}days"
)

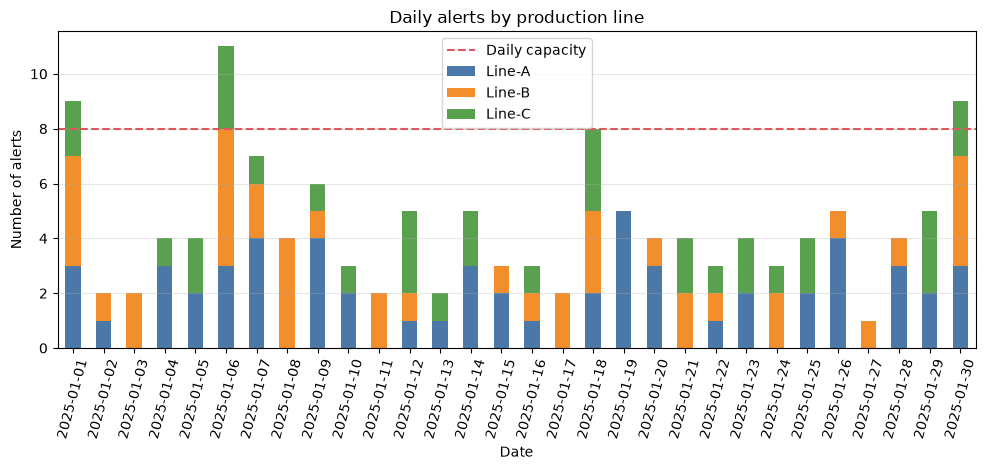

fig, ax = plt.subplots(figsize=(10, 4.8))
plot_cols = [c for c in ["Line-A", "Line-B", "Line-C"] if c in daily_line.columns]
daily_line[plot_cols].plot(
    kind="bar",
    stacked=True,
    ax=ax,
    color=["#4C78A8", "#F28E2B", "#59A14F"][: len(plot_cols)],
)
ax.axhline(DAILY_CAPACITY, linestyle="--", color="#E15759", label="Daily capacity")
ax.set_title("Daily alerts by production line")
ax.set_xlabel("Date")
ax.set_ylabel("Number of alerts")
ax.grid(True, axis="y", alpha=0.3)
ax.legend()
ax.tick_params(axis="x", labelrotation=75)
fig.tight_layout()
plt.show()
[OUT: 11]
line Line-A Line-B Line-C Total Over capacity
date
2025-01-01 3 4 2 9 True
2025-01-02 1 1 0 2 False
2025-01-03 0 2 0 2 False
2025-01-04 3 0 1 4 False
2025-01-05 2 0 2 4 False
2025-01-06 3 5 3 11 True
2025-01-07 4 2 1 7 False
2025-01-08 0 4 0 4 False
2025-01-09 4 1 1 6 False
2025-01-10 2 0 1 3 False
Processing capacity exceeded date: 3days / 30days

No.088: Aggregating the Number of Alerts

Reading the results

If there are days when processing capacity exceeds limits, before simply raising the threshold, consider reducing overlap within the same equipment, redistributing by shift, and queue splitting based on importance. Count KPIs monitor not only averages but also maximum, 95% points, and days overrun.

No.089: Designing Alert Priorities

Practical purpose

When all alerts are treated side by side, signs of critical equipment are buried behind minor alerts. Integrate anomalies, downtime impacts, and urgency to create rankings that a limited number of personnel can handle from above.

Analysis and modeling

As an example, align each element from 0 to 1 and define the following priority scores.

P=0.50 S+0.30 I+0.20 UP=0.50\,S+0.30\,I+0.20\,U

SS is the anomaly score, II is the equipment importance, and UU is the urgency based on elapsed time. Weights are assumptions and will be updated based on past response results and on-site reviews.

Check with Python

[IN: 12]
alerts = df[df["alert"] == 1].copy()
alerts["importance_norm"] = alerts["criticality"] / 3
alerts["urgency_norm"] = np.clip(alerts["elapsed_min"] / 120, 0, 1)
alerts["priority_score"] = (
    0.50 * alerts["anomaly_score"]
    + 0.30 * alerts["importance_norm"]
    + 0.20 * alerts["urgency_norm"]
)
alerts["priority"] = pd.cut(
    alerts["priority_score"],
    bins=[-np.inf, 0.65, 0.80, np.inf],
    labels=["P3", "P2", "P1"],
)
priority_counts = (
    alerts["priority"].value_counts().reindex(["P1", "P2", "P3"], fill_value=0)
)
display(priority_counts.rename("alerts").to_frame())
display(
    alerts.sort_values("priority_score", ascending=False)[
        [
            "timestamp",
            "line",
            "machine",
            "anomaly_score",
            "criticality",
            "impact_k_yen",
            "elapsed_min",
            "priority_score",
            "priority",
        ]
    ].head(10)
)

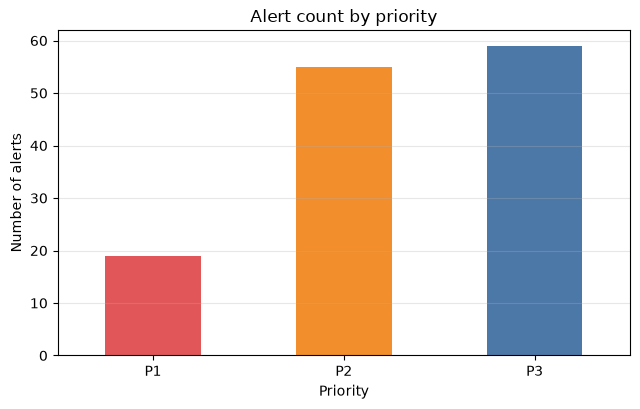

fig, ax = plt.subplots(figsize=(6.5, 4.2))
priority_counts.plot(kind="bar", ax=ax, color=["#E15759", "#F28E2B", "#4C78A8"])
ax.set_title("Alert count by priority")
ax.set_xlabel("Priority")
ax.set_ylabel("Number of alerts")
ax.grid(True, axis="y", alpha=0.3)
ax.tick_params(axis="x", labelrotation=0)
fig.tight_layout()
plt.show()
[OUT: 12]
alerts
priority
P1 19
P2 55
P3 59
timestamp line machine anomaly_score criticality impact_k_yen elapsed_min priority_score priority
786 2025-01-20 15:36:00 Line-A Line-A-M2 0.928 3 1587 121 0.964 P1
716 2025-01-18 21:36:00 Line-A Line-A-M1 0.896 3 1473 150 0.948 P1
237 2025-01-06 22:12:00 Line-A Line-A-M2 0.843 3 1296 166 0.922 P1
735 2025-01-19 09:00:00 Line-A Line-A-M2 0.803 3 1341 132 0.901 P1
574 2025-01-15 08:24:00 Line-A Line-A-M1 0.898 3 1587 88 0.896 P1
1083 2025-01-28 01:48:00 Line-A Line-A-M1 0.855 3 1911 92 0.881 P1
266 2025-01-07 15:36:00 Line-A Line-A-M2 0.776 3 1755 112 0.874 P1
751 2025-01-19 18:36:00 Line-A Line-A-M2 0.727 3 1899 143 0.864 P1
249 2025-01-07 05:24:00 Line-A Line-A-M1 0.722 3 1845 137 0.861 P1
1162 2025-01-30 01:12:00 Line-A Line-A-M1 0.827 3 1899 88 0.860 P1

No.089: Designing Alert Priorities

Reading the results

The priority is not a “model score reformulation,” but rather a response order that includes business impact. If there are always too many P1s, the segmentation is not working. Keep P1 to an immediate number of cases and leave each element and weight available for auditing.

No.090: Designing alerts usable on the field

Practical purpose

Finally, the responsibility and deadline from judgment to completion are determined. Even if the model is good, without notification recipients, duplication reduction, verification procedures, and result records, the improvement cycle will not continue.

Analysis and modeling

Assign an SLA and owner to each priority. This simplified example suppresses a notification when the previous alert from the same machine was within 120 minutes. It measures from the previous alert, not the last notification, so a continuing sequence may remain suppressed. Production rules should add periodic reminders and escalation when severity increases.

Check with Python

[IN: 13]
alerts = alerts.sort_values(["machine", "timestamp"]).copy()
alerts["minutes_since_previous"] = (
    alerts.groupby("machine")["timestamp"].diff().dt.total_seconds().div(60)
)
COOLDOWN_MIN = 120
alerts["notify"] = alerts["minutes_since_previous"].isna() | (
    alerts["minutes_since_previous"] > COOLDOWN_MIN
)

sla_map = {"P1": 15, "P2": 60, "P3": 240}
owner_map = {
    "P1": "Person responsible for maintenance+Manufacturing Manager",
    "P2": "On-duty maintenance technician",
    "P3": "Daily Patrols",
}
alerts["sla_min"] = alerts["priority"].astype(str).map(sla_map)
alerts["owner"] = alerts["priority"].astype(str).map(owner_map)
alerts["due_at"] = alerts["timestamp"] + pd.to_timedelta(alerts["sla_min"], unit="m")
queue = alerts[alerts["notify"]].sort_values(
    ["priority_score", "timestamp"], ascending=[False, True]
)

print(
    f"pre-suppression: {len(alerts)}records / After notification: {len(queue)}records / "
    f"suppression rate: {1 - len(queue) / len(alerts):.1%}"
)
# Show complete text for inspection instructions and owners.
with pd.option_context("display.max_colwidth", None):
    display(
        queue[
            [
                "timestamp",
                "machine",
                "priority",
                "owner",
                "sla_min",
                "due_at",
                "anomaly_score",
                "priority_score",
            ]
        ].head(12)
    )
[OUT: 13]
pre-suppression: 133records / After notification: 125records / suppression rate: 6.0%
timestamp machine priority owner sla_min due_at anomaly_score priority_score
786 2025-01-20 15:36:00 Line-A-M2 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-20 15:51:00 0.928 0.964
716 2025-01-18 21:36:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-18 21:51:00 0.896 0.948
237 2025-01-06 22:12:00 Line-A-M2 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-06 22:27:00 0.843 0.922
574 2025-01-15 08:24:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-15 08:39:00 0.898 0.896
1083 2025-01-28 01:48:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-28 02:03:00 0.855 0.881
266 2025-01-07 15:36:00 Line-A-M2 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-07 15:51:00 0.776 0.874
751 2025-01-19 18:36:00 Line-A-M2 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-19 18:51:00 0.727 0.864
249 2025-01-07 05:24:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-07 05:39:00 0.722 0.861
1162 2025-01-30 01:12:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-30 01:27:00 0.827 0.860
1012 2025-01-26 07:12:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-26 07:27:00 0.862 0.856
975 2025-01-25 09:00:00 Line-A-M1 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-25 09:15:00 0.724 0.844
1175 2025-01-30 09:00:00 Line-B-M2 P1 Person responsible for maintenance+Manufacturing Manager 15 2025-01-30 09:15:00 0.864 0.832

Reading the results

By suppressing notifications, we were able to create queues to process from P1 while reducing the number of cases the person in charge viewed. In actual operations, it is necessary to record transitions between states such as “Confirmed,” “Observation Required,” “Work Instructions,” “No Abnormalities,” and “Closed,” escalation when no action is taken, and reasons for judgment. Suppressed notifications are not deleted for audit purposes, and correspondences with previous events are preserved.

Practical points to check

  1. Model performance and operational quality are two different things.: Even if AUC is high, if the site cannot handle it due to concentrated notifications or duplicate notifications, it will not generate value.
  2. Thresholds vary depending on business conditions: Missed losses, inspection costs, safety restrictions, and changes in personnel count will also affect adoption values.
  3. For rare events, the actual number of cases is listed together: Shows not only the percentage, but also TP, FP, FN, daily alert count, and days exceeding capacity.
  4. Prioritize business impacts: Integrates not only anomaly scores but also critical equipment, downtime impacts, and elapsed times.
  5. The response results become the next training data.: By structuring and preserving on-site judgments and actions, reassessment and improvement become possible.

Requirements for deployment

  • Definition of correct labels: criteria and deadlines for determining faults, quality anomalies, signs, and false positives
  • Cost agreement: Evaluation of false positive man-hours, downtime, disposal, delivery schedules, and safety impacts
  • Operational capability: Number of personnel by shift, priority SLAs, communication network for nights and holidays
  • System integration: sensor infrastructure, maintenance management system, notifications, and audit log connections
  • KPIs: Recall, Precision, Number of FNs, Response Time, Days Beyond Capacity, Containment Rate, Recurrence Rate
  • Governance: Threshold change approval, model data version management, regular reviews

In the early stages of implementation, use shadow operation to verify alert counts and usefulness before automatically creating work orders. Each equipment group is trialed for 4 to 8 weeks, followed by on-site reviews and then gradually expanded to the target area.

Conclusion

From No.081 to No.090, we progressed from confusion matrices to Precision, Recall, F1, ROC-AUC, and PR-AUC, translating false positives and overlooks into operational costs. Furthermore, we selected thresholds based on cost and Recall constraints, and designed daily loads, priority, SLAs, and duplication reduction.

The anomaly detection deliverables are not limited to model files. Document the evaluation criteria, threshold rationale, alert queue, response rules and review history together so that operators can act on results and improve the system.

Consulting for businesses

At Surikobo, we support manufacturing site constraints, including anomaly detection PoC, evaluation design, equipment-specific loss assessment, threshold optimization, and alert operation design. You can consult from stages such as frequent false positives in existing models, wanting to link evaluation indicators to management decisions, or wanting to integrate with maintenance systems.

📩 Contact Us: www.surikobo.co.jp/contact
Contact us to discuss your project.
