All articles →

100 Exercises / Simulation / Simulation 100 Exercises

Introduction to Discrete Event Simulation | Improving Manufacturing Lines with Python and SimPy

Build discrete-event factory models with Python and SimPy. Compare equipment capacity, process waits, job-shop schedules and flow-shop sequences.

Discrete-event simulation for a factory with changing product mix and volume

No.041–No.050: Recreating the Process from Order Receipt to Completion in a Virtual Factory

Exercises No.041–No.050 introduce discrete-event simulation (DES) through a fictional precision-parts factory. Executable Python examples show how waiting, competition for equipment and job sequences affect delivery times, work-in-progress and investment choices.

This article adapts notebooks used in corporate training by Surikobo or its representative, Hiroshi Wayama, with permission from the client companies.
All data listed is fictional and has no relation whatsoever to real companies, factories, or figures.

Introduction: Practical Challenges in Manufacturing Covered in This Article

The target factory produces multiple types of metal parts to order, which are then machined, ground, and inspected before shipping. While equipment utilization rates are high on site, delays in delivery and work-in-progress are increasing. The question is where to add capacity and how to sequence jobs to meet delivery commitments.

In DES, time only advances at the moment the condition changes, such as order arrival, processing start, processing completion, or failure. This allows you to reproduce real-world competition and waiting without having to calculate all equipment in seconds.

Common situations on site

  • On a monthly average, there is enough capacity, but it only lingers during specific time periods.
  • As a result of increasing uptime, both work-in-progress and lead times increase.
  • The process sequence differs by product type, making it impossible to track equipment competition with just spreadsheets.
  • They want to try equipment expansion plans, but testing them on the actual line is costly.

Why is this issue so difficult to judge?

This is because variations in processing times, simultaneous arrivals, exclusive use of equipment, and priorities interact with each other. Static capability calculations made only by averages cannot express “when it will be crowded” or “who will wait.” DES models this time dependence. However, if the input distribution or operational rules are inaccurate, the results will also be inaccurate, so sensitivity analysis and on-site verification are essential.

Exercises covered in this article

No.ThemePerspectives gained from practical work
041What is DES?A model that only tracks state changes
042Event ListExplainability through time-series logs
043Future Event ListManaging the Next Events
044Event Scheduling MethodsEvent-Centric Implementation
045Process interaction methodImplementation centered on product flow
046SimPy IntroductionSimply expressing resource competition
047Production LineComparing the What-If of Ability Changes
048Process SimulationDiagnosis of Retention and Utilization Rates
049job shopCompetition by Variety Route
050Flow ShopJob sequence and makespan

Preparing the Python environment

The random number generator is fixed for reproducibility. Below, we use numpy, pandas, matplotlib, and simpy without using external data.

Run cells in order. [IN: n] marks an input and [OUT: n] its output; cells with no displayed result have no output label. Expand the setup panels to see longer code. Reproduce results by initializing the generator and running the same calls in the same order in the same library environment. Version numbers in outputs describe the recorded run. The examples also use IPython display and japanize-matplotlib for Japanese labels where present.

Setup code: Environment and random generator (expand)
[IN: 1]
import sys
import numpy as np
import pandas as pd
import matplotlib
import matplotlib.pyplot as plt
import japanize_matplotlib
import simpy
from IPython.display import display

SEED = 42
pd.set_option("display.max_columns", 20)
print(f"Python {sys.version.split()[0]}")
print(
    f"numpy {np.__version__}, pandas {pd.__version__}, matplotlib {matplotlib.__version__}, simpy {simpy.__version__}"
)
[OUT: 1]
Python 3.14.4
numpy 2.5.1, pandas 3.0.3, matplotlib 3.11.0, simpy 4.1.2

Creation of Fictional Data

Generate standard processing times for three product types and a set of 24 orders. Time is measured in minutes. The distributions are specified for this example; in practice, estimate them from arrival and processing records.

Setup code: Fictional data and shared functions (expand)
[IN: 2]
rng = np.random.default_rng(SEED)
routing = pd.DataFrame(
    {
        "product": ["A", "B", "C"],
        "route": [
            ["Cut", "Grind", "Inspect"],
            ["Cut", "Inspect"],
            ["Grind", "Cut", "Inspect"],
        ],
        "Cut": [18, 24, 15],
        "Grind": [14, 0, 22],
        "Inspect": [8, 10, 12],
    }
)
arrival = np.cumsum(rng.exponential(18, size=24))
orders = pd.DataFrame(
    {
        "job": [f"J{i:02d}" for i in range(1, 25)],
        "product": rng.choice(["A", "B", "C"], 24, p=[0.45, 0.35, 0.20]),
        "arrival": arrival.round(1),
        "due": (arrival + rng.integers(90, 181, 24)).round(1),
    }
)
display(routing)
display(orders.head(8))
[OUT: 2]
product route Cut Grind Inspect
0 A [Cut, Grind, Inspect] 18 14 8
1 B [Cut, Inspect] 24 0 10
2 C [Grind, Cut, Inspect] 15 22 12
job product arrival due
0 J01 B 43.3 154.3
1 J02 A 85.3 237.3
2 J03 B 128.3 275.3
3 J04 A 133.3 235.3
4 J05 A 134.8 299.8
5 J06 B 161.0 269.0
6 J07 B 186.4 349.4
7 J08 C 242.6 332.6

No.041: What is DES?

Practical context

By tracking only the points when equipment or product conditions change, you can reproduce wait times and changes in work-in-progress with reduced computational workload. This serves as the foundation for virtual experiments that change equipment capacity, deployment intervals, and operational rules.

Modeling approach

If you set the system state to S(t)S(t) and the event time to tkt_k, the state remains constant between events and updates to S(tk+)=f(S(tk−),ek)S(t_k^+)=f(S(t_k^-), e_k). Here, we check the arrival of three jobs per unit using the smallest manually calculated model.

Python example

[IN: 3]
jobs = pd.DataFrame(
    {"job": ["J1", "J2", "J3"], "arrival": [0, 4, 9], "process": [7, 5, 6]}
)
available = 0
rows = []
for r in jobs.itertuples():
    start = max(r.arrival, available)
    finish = start + r.process
    rows.append([r.job, r.arrival, start, finish, start - r.arrival])
    available = finish
des_basic = pd.DataFrame(rows, columns=["job", "arrival", "start", "finish", "wait"])
display(des_basic)
[OUT: 3]
job arrival start finish wait
0 J1 0 0 7 0
1 J2 4 7 12 3
2 J3 9 12 18 3

Interpreting the results

At J2, you have to wait 3 minutes until the 7 minutes when the facilities become available. You can see that not only the average processing time but also the timing of arrival and equipment release determines the waiting time.

No.042: Event List

Practical context

The event log is an audit trail that explains at which process and time the delivery delay occurred. It can also be used for on-site interviews and matching with performance logs.

Modeling approach

Events should have at least a minimum time, target, type, and state changes. By pairing start and end records, you can later re-aggregate equipment occupancy time, waiting times, and work-in-progress trends.

Python example

[IN: 4]
event_log = []
for r in des_basic.itertuples():
    event_log += [
        (r.arrival, r.job, "ARRIVAL"),
        (r.start, r.job, "START"),
        (r.finish, r.job, "FINISH"),
    ]
event_log = (
    pd.DataFrame(event_log, columns=["time", "job", "event"])
    .sort_values(["time", "event"])
    .reset_index(drop=True)
)
display(event_log)
[OUT: 4]
time job event
0 0 J1 ARRIVAL
1 0 J1 START
2 4 J2 ARRIVAL
3 7 J1 FINISH
4 7 J2 START
5 9 J3 ARRIVAL
6 12 J2 FINISH
7 12 J3 START
8 18 J3 FINISH

Interpreting the results

By logging by chronological order, you can reproduce the fact that you waited for equipment from the arrival of J2 until it started. In production, leaving the reason code and equipment ID makes it easier to use in improvement meetings.

No.043: Future Event List

Practical context

The Future Event List (FEL) is at the core of DES, managing the next events in chronological order. You can handle different events such as breakdowns and setup completions on a single timeline.

Modeling approach

FEL is implemented as a priority queue. Extract the event with the minimum time, update the state, and repeat the process of adding necessary future events. The priority of simultaneous events is explicitly stated to affect the results.

Python example

[IN: 5]
import heapq

fel = [(0, 1, "J1", "ARRIVAL"), (4, 2, "J2", "ARRIVAL"), (9, 3, "J3", "ARRIVAL")]
heapq.heapify(fel)
fel_trace = []
while fel:
    time, seq, job, event = heapq.heappop(fel)
    fel_trace.append((time, job, event, len(fel)))
    if event == "ARRIVAL":
        p = int(jobs.loc[jobs.job.eq(job), "process"].iloc[0])
        heapq.heappush(fel, (time + p, seq + 100, job, "PLANNED_FINISH"))
display(
    pd.DataFrame(
        fel_trace, columns=["time", "job", "event", "events_remaining_after_pop"]
    )
)
[OUT: 5]
time job event events_remaining_after_pop
0 0 J1 ARRIVAL 2
1 4 J2 ARRIVAL 2
2 7 J1 PLANNED_FINISH 2
3 9 J3 ARRIVAL 1
4 9 J2 PLANNED_FINISH 1
5 15 J3 PLANNED_FINISH 0

Interpreting the results

FEL always takes the minimum time. This simplified example does not yet address equipment conflicts, but it clearly explains how events are added and time progression works.

No.044: Event Scheduling Method

Practical context

It is suitable for strictly controlling equipment-centric logic or complex event rules. Implementers specify state transitions for each event.

Modeling approach

In event scheduling, you consider functions that handle “arrival” and “completion,” and start the next job from the queue upon completion. The main KPIs are average wait time, maximum waiting time, and end time.

Python example

[IN: 6]
def event_scheduling(jobs_df):
    waiting, busy, seq, out, q = [], False, 0, {}, []
    for r in jobs_df.itertuples():
        heapq.heappush(q, (r.arrival, seq, "ARRIVAL", r.job, r.process))
        seq += 1
    while q:
        t, _, ev, job, p = heapq.heappop(q)
        if ev == "ARRIVAL":
            waiting.append((job, p, t))
        else:
            busy = False
            out[job]["finish"] = t
        if not busy and waiting:
            j, pt, a = waiting.pop(0)
            busy = True
            out[j] = {"start": t, "wait": t - a}
            heapq.heappush(q, (t + pt, seq, "FINISH", j, pt))
            seq += 1
    return pd.DataFrame(out).T.reset_index(names="job")

event_result = event_scheduling(jobs)
display(event_result)
[OUT: 6]
job start wait finish
0 J1 0 0 7
1 J2 7 3 12
2 J3 12 3 18

Interpreting the results

The result of clearly stating the event rules matches the calculation in No.041. As rules increase, state management becomes more complex, so it is important to break them down into small, testable event functions.

No.045: Process Interaction Method

Practical context

It is a method that allows you to describe the process of products and workers moving sequentially through each process, making it easy to confirm the correspondence between process designers and models.

Modeling approach

Each job is represented as an independent process, requiring the necessary equipment, waiting until it is secured, and then releasing it after processing. Internally, it is event processing, but the code is closer to business workflows.

Python example

[IN: 7]
def process_interaction(jobs_df):
    env = simpy.Environment()
    machine = simpy.Resource(env, capacity=1)
    rec = []

    def job_proc(row):
        yield env.timeout(row.arrival)
        with machine.request() as req:
            yield req
            start = env.now
            yield env.timeout(row.process)
            rec.append((row.job, row.arrival, start, env.now, start - row.arrival))

    for row in jobs_df.itertuples():
        env.process(job_proc(row))
    env.run()
    return pd.DataFrame(rec, columns=["job", "arrival", "start", "finish", "wait"])

process_result = process_interaction(jobs)
display(process_result.sort_values("job"))
[OUT: 7]
job arrival start finish wait
0 J1 0 0 7 0
1 J2 4 7 12 3
2 J3 9 12 18 3

Interpreting the results

We were able to briefly express waiting for the same equipment as a job action. When the process route is long, it has the advantage of making it easier to match the model with the standard work sheet.

No.046: Introduction to SimPy

Practical context

Using SimPy’s Resources, you can represent finite resources such as the number of equipment, workers, and inspection tables. You can compare additional equipment proposals with just one code change.

Modeling approach

Environment represents the time, Resource represents the exclusive resource, and timeout represents the required time. Compare resource capacities of one and two to check their effect on the wait time.

Python example

[IN: 8]
simpy_compare = []
for capacity in [1, 2]:
    env = simpy.Environment()
    machine = simpy.Resource(env, capacity=capacity)
    waits = []

    def part(env, arrival, duration):
        yield env.timeout(arrival)
        with machine.request() as req:
            yield req
            waits.append(env.now - arrival)
            yield env.timeout(duration)

    for r in jobs.itertuples():
        env.process(part(env, r.arrival, r.process))
    env.run()
    simpy_compare.append((capacity, np.mean(waits), max(waits)))
display(pd.DataFrame(simpy_compare, columns=["capacity", "mean_wait", "max_wait"]))
[OUT: 8]
capacity mean_wait max_wait
0 1 2.0 3
1 2 0.0 0

Interpreting the results

In this small-scale example, having two units eliminates the wait. However, in practice, since there is a possibility of stagnation shifting to subsequent processes, evaluation is conducted across the entire line.

No.047: Production Line Simulation

Practical context

On series lines, improving a single process does not necessarily lead to an increase in the number of completed products. Simultaneous resource competition for cutting, grinding, and inspection, and comparing equipment enhancement plans.

Modeling approach

For arrival AjA_j, completion CjC_j and due date DjD_j, lead time is Lj=Cj−AjL_j=C_j-A_j and tardiness is Tj=max⁡(0,Cj−Dj)T_j=\max(0,C_j-D_j). These KPIs include only jobs completed before 600 minutes, which can understate delay if jobs remain unfinished. The same seed does not guarantee identical job-level durations when resource changes alter draw order. A controlled comparison should generate durations by job and operation in advance.

Python example

[IN: 9]
def simulate_factory(capacity=None, horizon=600, seed=SEED):
    capacity = capacity or {"Cut": 1, "Grind": 1, "Inspect": 1}
    env = simpy.Environment()
    rng_local = np.random.default_rng(seed)
    machines = {m: simpy.Resource(env, capacity=capacity[m]) for m in capacity}
    records, operations = [], []
    route_map = routing.set_index("product").to_dict("index")

    def job_proc(row):
        yield env.timeout(row.arrival)
        for machine in route_map[row.product]["route"]:
            queued = env.now
            with machines[machine].request() as req:
                yield req
                start = env.now
                mean = route_map[row.product][machine]
                duration = max(1, rng_local.normal(mean, mean * 0.15))
                operations.append(
                    (row.job, row.product, machine, queued, start, start + duration)
                )
                yield env.timeout(duration)
        records.append((row.job, row.product, row.arrival, env.now, row.due))

    for row in orders.itertuples():
        env.process(job_proc(row))
    env.run(until=horizon)
    res = pd.DataFrame(records, columns=["job", "product", "arrival", "finish", "due"])
    if len(res):
        res["lead_time"] = res.finish - res.arrival
        res["tardiness"] = (res.finish - res.due).clip(lower=0)
    ops = pd.DataFrame(
        operations, columns=["job", "product", "machine", "queued", "start", "finish"]
    )
    return res, ops

scenarios = {
    "Current Status": {"Cut": 1, "Grind": 1, "Inspect": 1},
    "Two cutting machines": {"Cut": 2, "Grind": 1, "Inspect": 1},
    "Two grinding machines": {"Cut": 1, "Grind": 2, "Inspect": 1},
}
summary = []
for name, cap in scenarios.items():
    r, _ = simulate_factory(cap)
    summary.append((name, len(r), r.lead_time.mean(), (r.tardiness == 0).mean()))
line_summary = pd.DataFrame(
    summary, columns=["scenario", "completed", "mean_lead_time", "on_time_rate"]
)

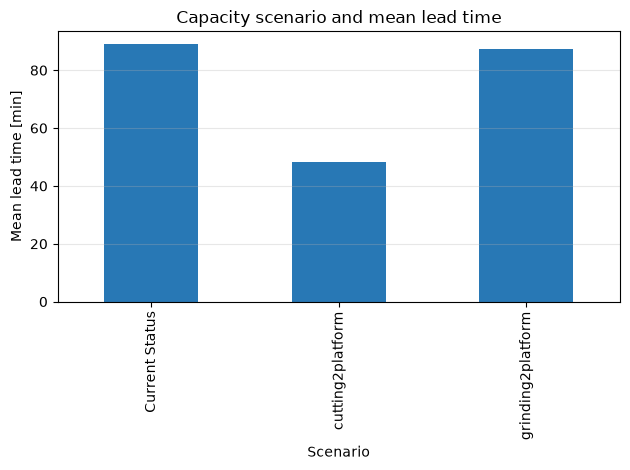

display(line_summary.round(2))
line_summary.set_index("scenario")[["mean_lead_time"]].plot(
    kind="bar", color="#2878B5", legend=False
)
plt.title("Capacity scenario and mean lead time")
plt.xlabel("Scenario")
plt.ylabel("Mean lead time [min]")
plt.grid(axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 9]
scenario completed mean_lead_time on_time_rate
0 Current Status 24 89.00 0.67
1 Two cutting machines 24 48.36 1.00
2 Two grinding machines 23 87.20 0.78

Capacity scenario and mean lead time

Interpreting the results

The effectiveness of equipment additions is assessed by combining the number of completed items, lead time, and on-time delivery rate. Expansion plans with little effect may not be the true constraint process. By adding the investment amount, you can expand the comparison to the cost per minute shortened or the amount of delay reduction.

No.048: Process Simulation

Practical context

By breaking down wait times and operating rates by process, you can link the locations where work-in-progress accumulates to the equipment load. Rather than simply aiming for high utilization rates, we look at the balance with delivery deadlines.

Modeling approach

For cmc_m machines observed over HH minutes, utilization is Um=∑jpjm/(cmH)U_m=\sum_j p_{jm}/(c_mH), where pjmp_{jm} is processing time within the observation window. The code clips scheduled finishes at 600 minutes, so work still in progress contributes its elapsed busy time. Waiting-time averages include started operations only; jobs still waiting are excluded.

Python example

[IN: 10]
base_res, base_ops = simulate_factory(scenarios["Current Status"])
base_ops["wait"] = base_ops.start - base_ops.queued
base_ops["busy_time"] = (base_ops.finish.clip(upper=600) - base_ops.start).clip(lower=0)
process_kpi = base_ops.groupby("machine").agg(
    operations=("job", "size"),
    mean_wait=("wait", "mean"),
    busy_time=("busy_time", "sum"),
)
process_kpi["utilization"] = process_kpi["busy_time"] / 600
display(process_kpi.round(3))
fig, ax = plt.subplots(figsize=(7, 4))
process_kpi.mean_wait.plot(kind="bar", ax=ax, color="#F28E2B")
ax.set_title("Mean waiting time by process")
ax.set_xlabel("Process")
ax.set_ylabel("Mean wait [min]")
ax.grid(axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 10]

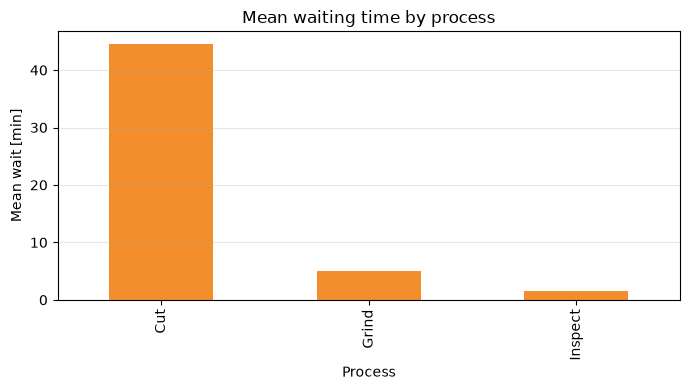

operations mean_wait busy_time utilization
machine
Cut 24 44.516 467.185 0.779
Grind 16 5.002 257.338 0.429
Inspect 24 1.526 226.464 0.377

Mean waiting time by process

Interpreting the results

Processes with long average wait times and high utilization rates are candidates for improvement. On the other hand, the average value hides some long waits, so in practice, 95th percentiles, WIP over time, and reasons for stopping are also added.

No.049: Job Shop Simulation

Practical context

At job shops, the process sequence differs for each product type, and people compete for equipment. The choice of priority rules affects not only the average dwell time but also the bias in delivery delays.

Modeling approach

Here, we check the results of three types passing through common equipment using Gantt charts. Strict rule comparisons involve repeatedly comparing FIFO, Shortest Processing Time (SPT), and Earliest Due Date (EDD) across the same random sequence.

Python example

[IN: 11]
sample_jobs = orders.job.iloc[:10]
gantt = base_ops[base_ops.job.isin(sample_jobs)].copy()
machine_y = {m: i for i, m in enumerate(["Cut", "Grind", "Inspect"])}
colors = {"A": "#4E79A7", "B": "#F28E2B", "C": "#59A14F"}
fig, ax = plt.subplots(figsize=(10, 4.5))
for r in gantt.itertuples():
    ax.barh(
        machine_y[r.machine],
        r.finish - r.start,
        left=r.start,
        height=0.55,
        color=colors[r.product],
        edgecolor="white",
    )
    ax.text(
        (r.start + r.finish) / 2,
        machine_y[r.machine],
        r.job,
        ha="center",
        va="center",
        fontsize=7,
    )
ax.set_yticks(list(machine_y.values()), list(machine_y.keys()))
ax.set_title("Job-shop schedule (first 10 jobs)")
ax.set_xlabel("Simulation time [min]")
ax.set_ylabel("Machine")
ax.grid(axis="x", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 11]

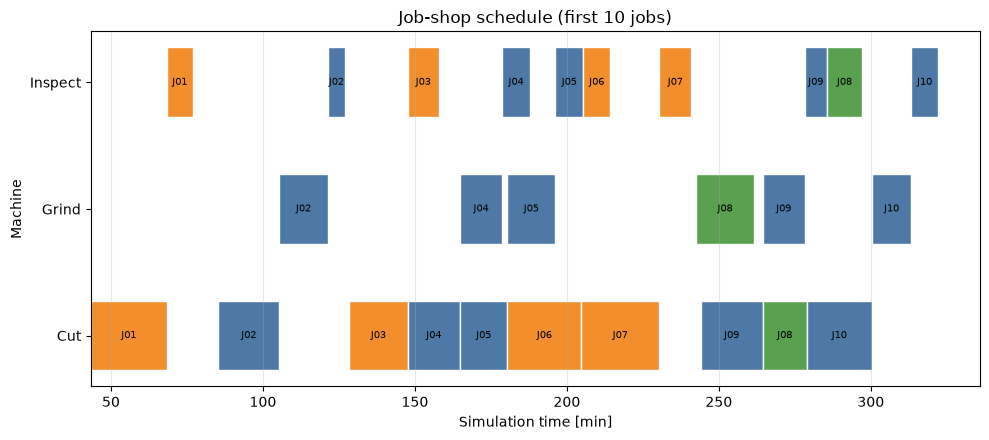

Job-shop schedule (first 10 jobs)

Interpreting the results

The Gantt chart shows a competition where Variety C progresses from grinding to cutting, while Variety A proceeds in reverse order. If orders are determined solely by local equipment efficiency, they may worsen the availability of other equipment or lead times, so rules are chosen based on KPIs covering all processes.

No.050: Flow Shop Simulation

Practical context

In flow shops where all products follow the same process sequence, the order of deployment affects the total completion time (makespan) and equipment idleness. If you need to change the setup, how you organize the variety is also important.

Modeling approach

For two machines visited in the same order, Johnson’s rule minimizes makespan when all jobs are available at time zero, operations are nonpreemptive and there are no sequence-dependent setups. The code below does not implement Johnson’s rule: it checks all 120 permutations of five jobs and compares the minimum with FIFO.

Python example

[IN: 12]
import itertools

flow = pd.DataFrame(
    {
        "job": ["P1", "P2", "P3", "P4", "P5"],
        "M1": [8, 14, 6, 11, 9],
        "M2": [12, 7, 15, 9, 10],
    }
).set_index("job")

def makespan(seq):
    t1 = t2 = 0
    for j in seq:
        t1 += flow.loc[j, "M1"]
        t2 = max(t1, t2) + flow.loc[j, "M2"]
    return t2

best_seq = min(itertools.permutations(flow.index), key=makespan)
fifo_seq = tuple(flow.index)
comparison = pd.DataFrame(
    {
        "sequence": [" → ".join(fifo_seq), " → ".join(best_seq)],
        "makespan": [makespan(fifo_seq), makespan(best_seq)],
    },
    index=["FIFO", "smallest"],
)
display(flow)
display(comparison)
comparison.makespan.plot(kind="bar", color=["#9C9C9C", "#59A14F"])
plt.title("Flow-shop sequencing comparison")
plt.xlabel("Rule")
plt.ylabel("Makespan [min]")
plt.grid(axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
[OUT: 12]
M1 M2
job
P1 8 12
P2 14 7
P3 6 15
P4 11 9
P5 9 10

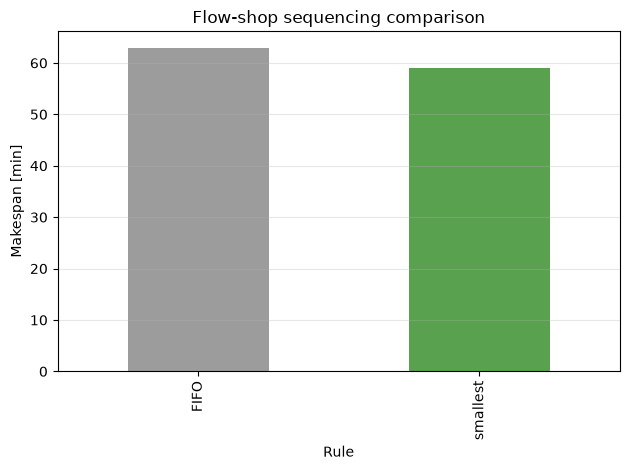

sequence makespan
FIFO P1 → P2 → P3 → P4 → P5 63
smallest P3 → P1 → P2 → P4 → P5 59

Flow-shop sequencing comparison

Interpreting the results

Even with the same processing time, the makespan changes just by the order of input. In practice, there are three or more processes, including delivery schedules, arrangements, and transport lots, so simulation and search algorithms are combined to verify the differences from the current order over several days.

Practical takeaways

  1. Look at the timeline, not average ability: The concentration and variation of arrivals create waits.
  2. Bottlenecks move: Upgrading equipment shifts constraints to later processes, so compare across the entire line.
  3. Don’t just maximize utilization rates: High loads increase work-in-progress and delivery time variations.
  4. Improve sequencing without additional investment: In job shops and flow shops, priority rules change KPIs.
  5. Using logs for accountability: The event list allows you to track the reasons for the occurrence of simulation results.

Preparing for practical use

  • Define arrival times, processing, setup, stopping, and transport based on MES, PLC, and work performance
  • Check for missing measurements, rounding, and mixing between planned and actual times, and estimate input distributions by type and equipment
  • Confirm process routes, priority rules, breaks, and operations during breakdowns with on-site personnel
  • Reproduce past periods and match the distribution of completed quantities, work-in-progress, and lead times with actual results.
  • Generate confidence intervals with multiple seeds and iterations, and avoid using random single-trial attempts for decision-making.
  • Creating a scenario evaluation table that includes investment costs, staffing constraints, and quality risks

A model is not a complete replica of reality, but a hypothesis of the resolution necessary for decision-making. Agreeing on the purpose, scope, tolerance of error, and renewal responsible party at the start is key to continued use.

Conclusion

The exercises cover event scheduling, SimPy resources, production-line capacity, process KPIs, job-shop routes and flow-shop sequencing. DES lets teams compare operating plans on the same timeline and see their effects on delivery, WIP and investment.

Consultations for Corporations

At Surikobo, we support everything from organizing manufacturing performance data, bottleneck analysis, discrete event simulation, to what-if analysis of capital investment and personnel allocation, and building an analytical platform that can be continuously operated on-site. Even at stages where issues have not yet been quantified, we can work together from organizing target processes and decision-making.

📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
