100 Exercises / Simulation / Simulation 100 Exercises
Manufacturing Simulation Practice | Making Decisions on Production Planning, Inventory, and Capital Investment with Python
Compare production, investment, staffing, inventory and sourcing in Python. Assess forecast errors, KPIs and reproducible factory scenarios.
Designing Factory Operations Resilient to Fluctuations: Manufacturing Simulation Practice No.091–No.100
Exercises No.091–No.100 use a fictional precision-pump factory to compare production, inventory, staffing, procurement and investment under common assumptions and KPIs. We examine variability, downside risk, investment recovery and trade-offs as well as planned averages.
This article adapts notebooks used in corporate training by Surikobo or its representative, Hiroshi Wayama, with permission from the client companies.
All data listed is fictional and has no relation whatsoever to real companies, factories, or figures.
Introduction: Practical Challenges in Manufacturing Covered in This Article
Monthly S&OP requires simultaneous alignment of sales plans, production capacity, inventory, purchasing, personnel, and capital investment. However, if you plan based solely on average demand, when demand peaks, breakdowns, and delivery delays pile up, stockouts and overtime can spike. The purpose of this article is not to “guess the future with a single point,” but to compare multiple assumptions in a reproducible way to enhance the robustness of decision-making.
Common situations on site
- Each department has different assumptions and KPIs, and they are not looking at the same scenario.
- Even if a capability enhancement plan is presented, the recovery probability is unknown, including demand fluctuations and startup losses.
- Decisions regarding safety stock, personnel, and outsourcing depend on empirical rules.
- Digital twins stop at visualization and do not connect to plan changes or approvals.
Why is this issue so difficult to judge?
This is because causal relationships circulate. Increasing production increases inventory, but if there is a breakdown or shortage of parts, only work-in-progress increases. Inventory reduction improves working capital but lowers resistance to delivery delays. Therefore, in addition to the average, quantiles, constraints, costs, and service levels are compared using the same model.
Exercises covered in this article
| No. | Theme | Key Decisions |
|---|---|---|
| 091 | Production plan | Monthly Production Volume under Demand Fluctuations |
| 092 | Factory layout | Reducing transport distances and congestion |
| 093 | capital investment | Recoverability of Capacity Enhancements |
| 094 | staffing | Staffing under skill constraints |
| 095 | Inventory optimization | Order Point and Safety Stock |
| 096 | supply chain | Resistance to Procurement Disruptions |
| 097 | Demand forecasting and simulation | Planning with Forecast Errors |
| 098 | KPI | Balancing profit, delivery time, and inventory |
| 099 | Manufacturing Digital Twin | Status updates based on observations |
| 100 | The foundation of Palantir’s manufacturing edition | Integration of data, models, and decision-making |
Preparing the Python environment
Generate fixed seed random numbers with NumPy, handle tables with pandas, and visualize them with matplotlib. External data, seaborn, and external APIs are not used. Being able to reproduce the same results from the same input and seed is a prerequisite for accountability in meetings and model change management.
Run cells in order. [IN: n] marks an input and [OUT: n] its output; cells with no displayed result have no output label. Expand the setup panels to see longer code. Reproduce results by initializing the generator and running the same calls in the same order in the same library environment. Version numbers in outputs describe the recorded run.
Setup code: Environment and random generator (expand)
import sys
import numpy as np
import pandas as pd
import matplotlib
import matplotlib.pyplot as plt
from IPython.display import display
SEED = 20260712
rng = np.random.default_rng(SEED)
pd.set_option("display.float_format", lambda x: f"{x:,.2f}")
print("Python :", sys.version.split()[0])
print("NumPy :", np.__version__)
print("pandas :", pd.__version__)
print("matplotlib :", matplotlib.__version__)
print("random seed:", SEED)
Python : 3.14.4
NumPy : 2.5.1
pandas : 3.0.3
matplotlib : 3.11.0
random seed: 20260712
Creation of Fictional Data
The target is factories that assemble, inspect, and ship products A, B, and C. We create 12-month standard demand, unit price, coefficient of variation, and process load. Separating data generation from business rules limits the scope of impact when converting data into actual data.
Setup code: Fictional data and shared functions (expand)
months = pd.date_range("2026-01-01", periods=12, freq="MS")
products = pd.DataFrame(
{
"product": ["A", "B", "C"],
"unit_price_kJPY": [82, 105, 138],
"unit_margin_kJPY": [31, 39, 52],
"demand_cv": [0.12, 0.18, 0.25],
"assembly_h": [0.80, 1.05, 1.35],
"inspection_h": [0.25, 0.35, 0.50],
}
)
base = np.array([420, 280, 160])
season = 1 + 0.12 * np.sin(2 * np.pi * (np.arange(12) - 1) / 12)
demand_plan = pd.DataFrame(
(season[:, None] * base[None, :]).round().astype(int),
index=months,
columns=products["product"],
)
display(products)
display(demand_plan.head())
| product | unit_price_kJPY | unit_margin_kJPY | demand_cv | assembly_h | inspection_h | |
|---|---|---|---|---|---|---|
| 0 | A | 82 | 31 | 0.12 | 0.80 | 0.25 |
| 1 | B | 105 | 39 | 0.18 | 1.05 | 0.35 |
| 2 | C | 138 | 52 | 0.25 | 1.35 | 0.50 |
| product | A | B | C |
|---|---|---|---|
| 2026-01-01 | 395 | 263 | 150 |
| 2026-02-01 | 420 | 280 | 160 |
| 2026-03-01 | 445 | 297 | 170 |
| 2026-04-01 | 464 | 309 | 177 |
| 2026-05-01 | 470 | 314 | 179 |
No.091: Production Planning Simulation
Practical context / Modeling approach
A monthly plan that meets average demand can still produce shortages. Include capacity limits and opening inventory when estimating stockout probabilities and excess stock.
Update ending inventory and lost sales from demand and production :
Shortages are lost sales, not backorders carried forward. Quantities are approximated as continuous and capacity is aggregated across products; product-specific processing and inventory constraints are omitted.
Python example
n_sim = 1000
plan_total = demand_plan.sum(axis=1).to_numpy()
demand_total = rng.normal(plan_total, plan_total * 0.16, size=(n_sim, 12)).clip(0)
capacity = 930
production = np.minimum(capacity, plan_total * 1.04)
inventory = np.zeros((n_sim, 13))
inventory[:, 0] = 120
shortage = np.zeros((n_sim, 12))
for t in range(12):
available = inventory[:, t] + production[t]
shortage[:, t] = np.maximum(demand_total[:, t] - available, 0)
inventory[:, t + 1] = np.maximum(available - demand_total[:, t], 0)
result_91 = pd.DataFrame(
{
"month": months,
"plan": plan_total,
"production": production,
"median_ending_inventory": np.median(inventory[:, 1:], axis=0),
"shortage_probability": (shortage > 0).mean(axis=0),
}
)
display(result_91.round({c: 2 for c in result_91.select_dtypes("number").columns}))
fig, ax = plt.subplots(figsize=(9, 4))

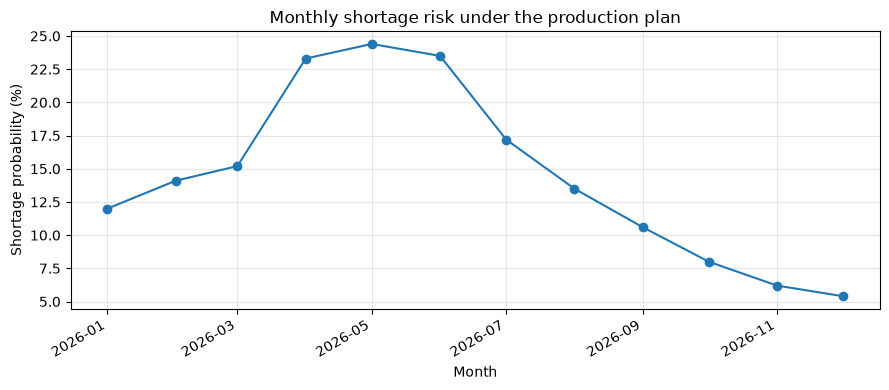

ax.plot(months, result_91["shortage_probability"] * 100, marker="o")
ax.set(
title="Monthly shortage risk under the production plan",
xlabel="Month",
ylabel="Shortage probability (%)",
)
ax.grid(True, alpha=0.3)
fig.autofmt_xdate()
plt.tight_layout()
plt.show()
| month | plan | production | median_ending_inventory | shortage_probability | |
|---|---|---|---|---|---|
| 0 | 2026-01-01 | 808 | 840.32 | 151.74 | 0.12 |
| 1 | 2026-02-01 | 860 | 894.40 | 183.10 | 0.14 |
| 2 | 2026-03-01 | 912 | 930.00 | 206.32 | 0.15 |
| 3 | 2026-04-01 | 950 | 930.00 | 188.65 | 0.23 |
| 4 | 2026-05-01 | 963 | 930.00 | 181.20 | 0.24 |
| 5 | 2026-06-01 | 950 | 930.00 | 180.24 | 0.24 |
| 6 | 2026-07-01 | 912 | 930.00 | 204.88 | 0.17 |
| 7 | 2026-08-01 | 860 | 894.40 | 264.19 | 0.14 |
| 8 | 2026-09-01 | 808 | 840.32 | 319.11 | 0.11 |
| 9 | 2026-10-01 | 770 | 800.80 | 353.34 | 0.08 |
| 10 | 2026-11-01 | 757 | 787.28 | 397.61 | 0.06 |
| 11 | 2026-12-01 | 770 | 800.80 | 439.14 | 0.05 |

Interpreting the results
For high-shortage months, compare advance production, overtime and outsourcing. A month with a high median inventory can still have shortages in high-demand trials. Median stock and shortage probabilities alone do not establish adequate annual capacity; inspect annual balances and monthly constraints within each trial.
No.092: Factory Layout Simulation
Practical context / Modeling approach
Layout changes involve not only transport distance, but also investment decisions that include aisle congestion, safety, and relocation halts. Here, we compare the transport load between the current layout and the cell layout based on inter-process flow and coordinates.
If the number of trips between processes and is and the Manhattan distance is , the conveying load is . Probabilistic wait times that indicate congestion are also included.
Python example
flows = {
("Receiving", "Machining"): 80,
("Machining", "Assembly"): 140,
("Assembly", "Inspection"): 130,
("Inspection", "Shipping"): 120,
}
layouts = {
"Current": {
"Receiving": (0, 0),
"Machining": (6, 1),
"Assembly": (2, 6),
"Inspection": (7, 6),
"Shipping": (9, 1),
},
"Cell": {
"Receiving": (0, 0),
"Machining": (3, 1),
"Assembly": (5, 2),
"Inspection": (7, 2),
"Shipping": (9, 1),
},
}
rows = []
for name, pos in layouts.items():
distance_load = sum(
f * (abs(pos[a][0] - pos[b][0]) + abs(pos[a][1] - pos[b][1]))
for (a, b), f in flows.items()
)
congestion = rng.lognormal(
mean=np.log(distance_load * 0.018), sigma=0.18, size=1000
)
rows.append(
[name, distance_load, np.mean(congestion), np.percentile(congestion, 95)]
)
result_92 = pd.DataFrame(
rows, columns=["layout", "distance_load", "mean_delay_min", "p95_delay_min"]
)
display(result_92.round(1))
fig, ax = plt.subplots(figsize=(7, 4))

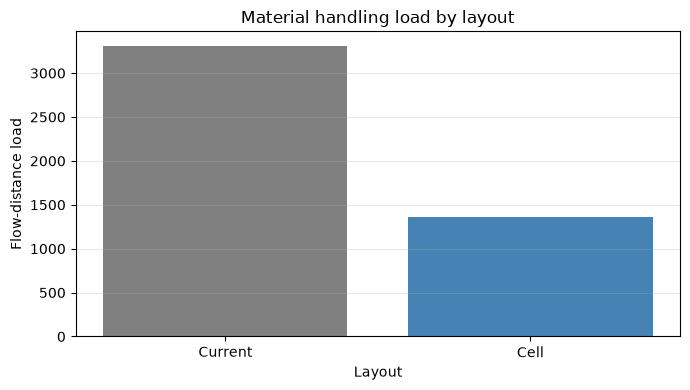

ax.bar(result_92["layout"], result_92["distance_load"], color=["gray", "steelblue"])
ax.set(
title="Material handling load by layout",
xlabel="Layout",
ylabel="Flow-distance load",
)
ax.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
| layout | distance_load | mean_delay_min | p95_delay_min | |
|---|---|---|---|---|
| 0 | Current | 3310 | 61.30 | 81.70 |
| 1 | Cell | 1360 | 24.90 | 32.70 |

Interpreting the results
If the cell layout reduces transport load and the 95th percentile of delay, it benefits not only average efficiency but also stability during busy times. In actual implementation, fire compartments, maintenance spaces, crossings between forklifts and pedestrians, and production reduction during relocation are added to the constraints.
No.093: Capital Investment Simulation
Practical context / Modeling approach
A positive mean NPV can coexist with a substantial probability of failing to recover the investment. Simulate uncertain demand growth, uptime and ramp-up delay to assess that risk.
and propagate cash flow uncertainty using the Monte Carlo method.
Python example
n = 5000
years = np.arange(1, 6)
investment = 180_000
discount = 0.08
growth = rng.normal(0.045, 0.035, n)
uptime = rng.beta(35, 3, n)
ramp_delay = rng.choice([0, 1, 2], n, p=[0.65, 0.25, 0.10])
npvs = np.full(n, -investment, dtype=float)
for y in years:
volume = 4200 * (1 + growth) ** y * uptime
volume = np.where(y <= ramp_delay, volume * 0.55, volume)
cash = volume * 18 - 22_000
npvs += cash / (1 + discount) ** y
result_93 = pd.Series(
{
"mean_NPV_kJPY": npvs.mean(),
"median_NPV_kJPY": np.median(npvs),
"P(NPV>0)": (npvs > 0).mean(),
"P10_NPV_kJPY": np.percentile(npvs, 10),
}
)
display(result_93.to_frame("value").round(2))

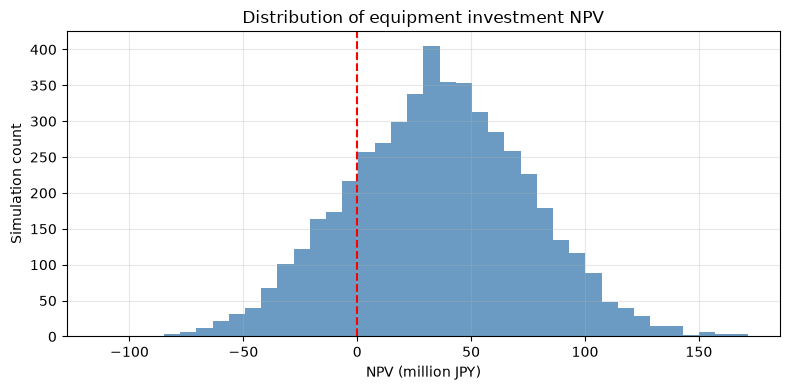

fig, ax = plt.subplots(figsize=(8, 4))
ax.hist(npvs / 1000, bins=40, color="steelblue", alpha=0.8)
ax.axvline(0, color="red", linestyle="--")
ax.set(
title="Distribution of equipment investment NPV",
xlabel="NPV (million JPY)",
ylabel="Simulation count",
)
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| value | |
|---|---|
| mean_NPV_kJPY | 35,512.67 |
| median_NPV_kJPY | 35,614.25 |
| P(NPV>0) | 0.81 |
| P10_NPV_kJPY | -16,809.36 |

Interpreting the results
In the selection decision, we look not only at the average NPV but also at the probability of positive NPV and the 10th percentile. If there is a large downside, risk reduction measures such as converting lump-sum investments into phased investments, securing demand contracts before placing orders, or including startup support as contract terms are compared among other risk mitigation measures.
No.094: Staffing Simulation
Practical context / Modeling approach
Headcount alone does not ensure sufficient capacity when required skills are missing. Compare assembly and inspection skill coverage together with absenteeism and cross-training.
The difference between required and supplied man-hours is called the shortfall, and absenteeism is reproduced using the Bernoulli trial. Multi-skilled workers are evaluated not as a measure to increase the number of people but to enhance skill substitutability.
Python example
scenarios = {
"Current": (0.08, 0.55),
"Cross-trained": (0.08, 0.80),
"Training + attendance": (0.05, 0.85),
}
rows = []
for name, (absence, qualified) in scenarios.items():
present = rng.binomial(24, 1 - absence, 2000)
skilled = rng.binomial(present, qualified)
supplied = skilled * 7.2
required = rng.normal(112, 12, 2000)
deficit = np.maximum(required - supplied, 0)
rows.append(
[name, deficit.mean(), np.percentile(deficit, 95), (deficit > 0).mean()]
)
result_94 = pd.DataFrame(
rows, columns=["scenario", "mean_deficit_h", "p95_deficit_h", "deficit_probability"]
)
display(result_94.round(2))
fig, ax = plt.subplots(figsize=(8, 4))

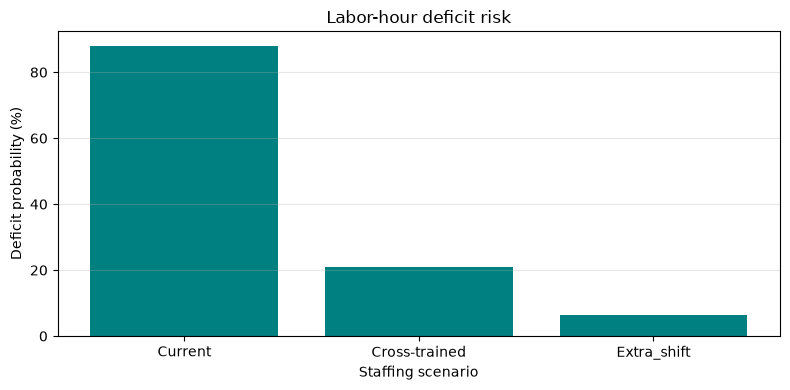

ax.bar(result_94["scenario"], result_94["deficit_probability"] * 100, color="teal")
ax.set(
title="Labor-hour deficit risk",
xlabel="Staffing scenario",
ylabel="Deficit probability (%)",
)
ax.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
| scenario | mean_deficit_h | p95_deficit_h | deficit_probability | |
|---|---|---|---|---|
| 0 | Current | 25.51 | 59.40 | 0.88 |
| 1 | Cross-trained | 2.46 | 17.72 | 0.21 |
| 2 | Training + attendance | 0.66 | 2.82 | 0.06 |

Interpreting the results
If the probability of shortages drops significantly due to multi-skilled work, investment in education may be more effective than constant increases. However, treating skills with binary values is simplified. In practice, qualifications, validity periods, proficiency levels, instructors, continuous working hours, and personal preferences are all constraints for management.
No.095: Inventory Optimization Simulation
Practical context / Modeling approach
Safety stock prevents stockouts while increasing storage costs and the risk of obsolescence. Simulate candidate order points and compare service levels with total costs.
With lead-time demand mean and standard deviation , the normal approximation gives . The daily simulation treats shortages as lost sales and reports the unit fill rate. Holding costs are 0.12 yen/unit/day, ordering costs 4,000 yen/order and shortage costs 1,800 yen/unit. Divide the total by 1,000 to report kJPY.
Python example
def inventory_policy(rop, days=365, reps=300):
costs = []
fill = []
for _ in range(reps):
inv = rop + 180
on_order = []
demand_total = served = holding = orders = 0
for day in range(days):
inv += sum(q for due, q in on_order if due == day)
on_order = [x for x in on_order if x[0] > day]
d = max(0, int(rng.normal(28, 7)))
demand_total += d
s = min(inv, d)
served += s
inv -= s
holding += inv
if inv + sum(q for _, q in on_order) <= rop:
on_order.append((day + int(rng.integers(4, 9)), 180))
orders += 1
costs.append(
(holding * 0.12 + orders * 4_000 + (demand_total - served) * 1_800) / 1000
)
fill.append(served / demand_total)
return np.mean(costs), np.mean(fill)
result_95 = pd.DataFrame(
[(r, *inventory_policy(r)) for r in range(100, 301, 25)],
columns=["reorder_point", "annual_cost_kJPY", "fill_rate"],
)
display(result_95.round(3))

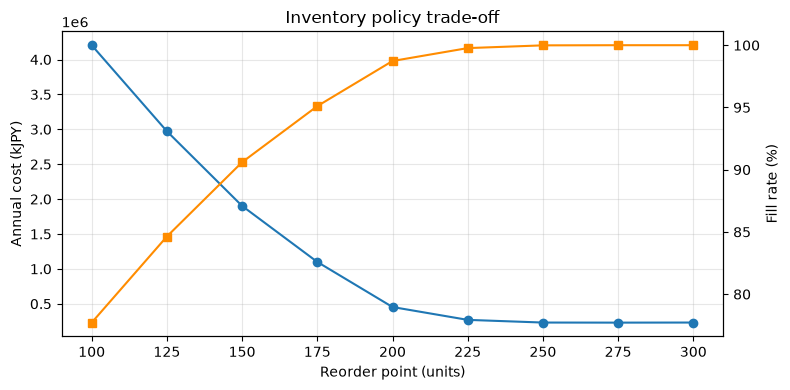

fig, ax1 = plt.subplots(figsize=(8, 4))
ax1.plot(
result_95["reorder_point"], result_95["annual_cost_kJPY"], marker="o", label="Cost"
)
ax1.set(
title="Inventory policy trade-off",
xlabel="Reorder point (units)",
ylabel="Annual cost (kJPY)",
)
ax1.grid(True, alpha=0.3)
ax2 = ax1.twinx()
ax2.plot(
result_95["reorder_point"],
result_95["fill_rate"] * 100,
color="darkorange",
marker="s",
label="Fill rate",
)
ax2.set_ylabel("Fill rate (%)")
plt.tight_layout()
plt.show()
| reorder_point | annual_cost_kJPY | fill_rate | |
|---|---|---|---|
| 0 | 100 | 4,205.23 | 0.78 |
| 1 | 125 | 2,972.27 | 0.85 |
| 2 | 150 | 1,902.25 | 0.91 |
| 3 | 175 | 1,099.79 | 0.95 |
| 4 | 200 | 453.63 | 0.99 |
| 5 | 225 | 269.56 | 1.00 |
| 6 | 250 | 231.19 | 1.00 |
| 7 | 275 | 230.06 | 1.00 |
| 8 | 300 | 231.31 | 1.00 |

Interpreting the results
The basic approach is to select the order point with the lowest total cost from among candidates that meet the minimum service level. Since out-of-stock losses differ between critical customer parts and generic products, it is necessary to agree on service levels for each item rather than a uniform inventory period for all items.
No.096: Supply Chain Simulation
Practical context / Modeling approach
A low-priced single procurement is not necessarily cheap, including losses during interruptions. Compare the annual total costs and number of downtime for single procurement, two-company purchasing, and emergency procurement.
Costs for operating downtime due to delays or interruptions are added to the expected procurement costs. It is important not to overlook correlated disaster risks and regional dependence.
Python example
policies = {
"Single source": (1.00, 0.08, 0),
"Dual source": (1.06, 0.025, 0),
"Dual + emergency": (1.10, 0.012, 6000),
}
rows = []
for name, (price_factor, disrupt_p, emergency) in policies.items():
costs = []
stops = []
for _ in range(3000):
disrupted = rng.random(12) < disrupt_p
stop_days = (rng.integers(2, 12, 12) * disrupted).sum()
procurement = 12 * 15_000 * price_factor
total = procurement + stop_days * 9_000 + emergency * (stop_days > 0)
costs.append(total)
stops.append(stop_days)
rows.append(
[
name,
np.mean(costs),
np.percentile(costs, 95),
np.mean(stops),
(np.array(stops) > 0).mean(),
]
)
result_96 = pd.DataFrame(
rows,
columns=[
"policy",
"mean_cost_kJPY",
"p95_cost_kJPY",
"mean_stop_days",
"disruption_probability",
],
)
display(result_96.round(2))
fig, ax = plt.subplots(figsize=(8, 4))

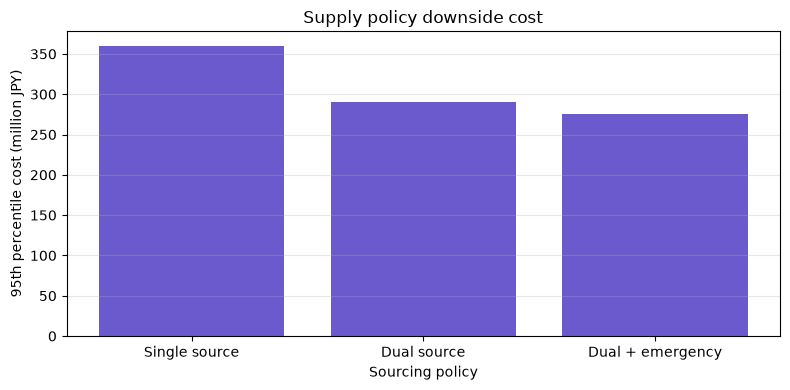

ax.bar(result_96["policy"], result_96["p95_cost_kJPY"] / 1000, color="slateblue")
ax.set(
title="Supply policy downside cost",
xlabel="Sourcing policy",
ylabel="95th percentile cost (million JPY)",
)
ax.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
| policy | mean_cost_kJPY | p95_cost_kJPY | mean_stop_days | disruption_probability | |
|---|---|---|---|---|---|
| 0 | Single source | 235,824.00 | 360,000.00 | 6.20 | 0.61 |
| 1 | Dual source | 207,753.00 | 289,800.00 | 1.88 | 0.25 |
| 2 | Dual + emergency | 207,448.00 | 276,000.00 | 0.96 | 0.14 |

Interpreting the results
Dual sourcing can reduce the 95th percentile of total cost and expected downtime even when its normal purchase price is higher. In BCP assessment, we check not only expected costs but also the maximum allowable downtime duration, the certification period for substitute materials, the location of molds and jigs, and even secondary suppliers for suppliers.
No.097: Demand Forecasting and Simulation
Practical context / Modeling approach
If you place the forecast value directly in the production plan, you ignore the forecast error. Separate point prediction and error distribution, and compare planned buffers including upward and downward bias.
Let be actual demand and its forecast. Resample the errors . Not only MAE but also shortage and inventory costs that propagated errors to the plan are used to make judgments.
Python example
history_actual = (
700 + 35 * np.sin(np.arange(36) * 2 * np.pi / 12) + rng.normal(0, 55, 36)
)
history_forecast = 700 + 35 * np.sin(np.arange(36) * 2 * np.pi / 12)
errors = history_actual - history_forecast
future_forecast = 700 + 35 * np.sin(np.arange(36, 48) * 2 * np.pi / 12)
buffers = [0, 0.5, 1.0, 1.5]
rows = []
for z in buffers:
plan = future_forecast + z * errors.std()
simulated = future_forecast + rng.choice(errors, size=(3000, 12), replace=True)
shortage = np.maximum(simulated - plan, 0).sum(axis=1)
excess = np.maximum(plan - simulated, 0).sum(axis=1)
cost = shortage * 2.4 + excess * 0.35
rows.append(
[z, cost.mean(), (shortage == 0).mean(), shortage.mean(), excess.mean()]
)
result_97 = pd.DataFrame(
rows,
columns=[
"buffer_sigma",
"mean_cost_kJPY",
"no_shortage_probability",
"mean_shortage",
"mean_excess",
],
)
display(result_97.round(2))
fig, ax = plt.subplots(figsize=(8, 4))

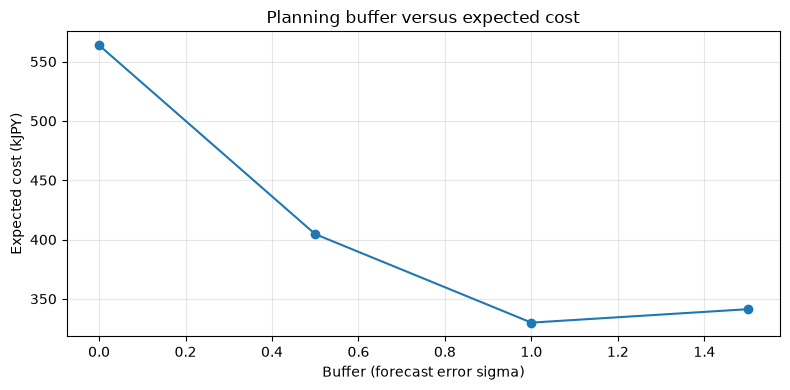

ax.plot(result_97["buffer_sigma"], result_97["mean_cost_kJPY"], marker="o")
ax.set(
title="Planning buffer versus expected cost",
xlabel="Buffer (forecast error sigma)",
ylabel="Expected cost (kJPY)",
)
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| buffer_sigma | mean_cost_kJPY | no_shortage_probability | mean_shortage | mean_excess | |
|---|---|---|---|---|---|
| 0 | 0.00 | 563.81 | 0.01 | 193.48 | 284.18 |
| 1 | 0.50 | 404.55 | 0.01 | 99.52 | 473.42 |
| 2 | 1.00 | 329.96 | 0.16 | 35.26 | 700.96 |
| 3 | 1.50 | 341.27 | 0.51 | 1.58 | 964.23 |

Interpreting the results
Even if forecasting accuracy is the same, the appropriate buffer will differ depending on the ratio of out-of-stock costs to inventory costs. If there is bias in the forecasting error, the forecasting process is corrected before adding buffers. It is also essential to unify the meaning of observations such as promotions, lost orders, and backlog orders.
No.098: KPI Simulation
Practical context / Modeling approach
Maximizing a single KPI can cause side effects. High utilization rates can worsen work-in-progress and delivery times, while inventory reductions increase shortages. Compare KPIs for each operating policy under the same scenario.
Normalize profit, OTIF (On Time In Full: the share of orders delivered in full by the promised date), inventory turns and overtime using the candidate minima and maxima, then average them with equal weights. OTIF and other operating KPIs are assumed inputs here, not calculated from order histories. Adding candidates changes the normalization, so scores are relative to these three options.
Python example
policies = [
("Lean", 0.96, 0.92, 10.2, 140),
("Balanced", 0.985, 0.97, 8.4, 210),
("Service first", 0.995, 0.985, 6.3, 330),
]
rows = []
for name, yield_rate, otif, turns, overtime in policies:
profit = (
420_000 * yield_rate + 95_000 * otif + rng.normal(0, 8000, 1500) - overtime * 55
)
rows.append([name, profit.mean(), otif, turns, overtime])
result_98 = pd.DataFrame(
rows,
columns=["policy", "expected_profit_kJPY", "OTIF", "inventory_turns", "overtime_h"],
)
for c in ["expected_profit_kJPY", "OTIF", "inventory_turns"]:
result_98[c + "_score"] = (result_98[c] - result_98[c].min()) / (
result_98[c].max() - result_98[c].min()
)
result_98["overtime_score"] = 1 - (
result_98["overtime_h"] - result_98["overtime_h"].min()
) / (result_98["overtime_h"].max() - result_98["overtime_h"].min())
result_98["balanced_score"] = result_98[
[
"expected_profit_kJPY_score",
"OTIF_score",
"inventory_turns_score",
"overtime_score",
]
].mean(axis=1)
display(
result_98[
[
"policy",
"expected_profit_kJPY",
"OTIF",
"inventory_turns",
"overtime_h",
"balanced_score",
]
].round(3)
)

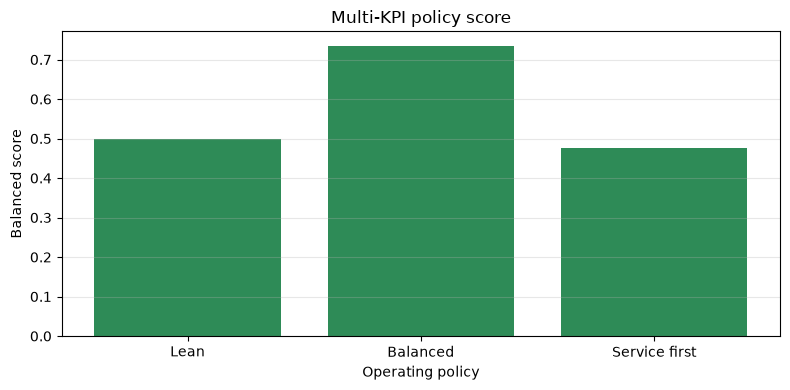

fig, ax = plt.subplots(figsize=(8, 4))
ax.bar(result_98["policy"], result_98["balanced_score"], color="seagreen")
ax.set(
title="Multi-KPI policy score", xlabel="Operating policy", ylabel="Balanced score"
)
ax.grid(True, axis="y", alpha=0.3)
plt.tight_layout()
plt.show()
| policy | expected_profit_kJPY | OTIF | inventory_turns | overtime_h | balanced_score | |
|---|---|---|---|---|---|---|
| 0 | Lean | 483,023.36 | 0.92 | 10.20 | 140 | 0.50 |
| 1 | Balanced | 494,383.01 | 0.97 | 8.40 | 210 | 0.73 |
| 2 | Service first | 493,255.15 | 0.98 | 6.30 | 330 | 0.47 |

Interpreting the results
Even if a balanced proposal has an overall advantage, any proposal below the minimum OTIF standard should be disqualified. Weighted averages are for explanatory purposes and must not offset restrictions on laws, safety, quality assurance, or customer contracts. Sensitivity analysis and weight agreement at management meetings are necessary.
No.099: Construction of a Digital Twin for the Manufacturing Industry
Practical context / Modeling approach
Digital twins are not 3D displays; instead, they update the model’s state through real-world observations, predicting the future and leading to action. Here, the deterioration of the equipment is sequentially corrected using sensor values.
For predicted state , observation and gain , the update is . A simple one-dimensional Kalman filter tracks degradation while leveling out observation noise.
Python example
days = np.arange(60)
true_health = 100 - 0.32 * days + np.cumsum(rng.normal(0, 0.18, 60))
sensor = true_health + rng.normal(0, 2.2, 60)
estimate = []
x = 100.0
p = 4.0
q = 0.25
r = 2.2**2
for y in sensor:
x_pred = x - 0.32
p_pred = p + q
k = p_pred / (p_pred + r)
x = x_pred + k * (y - x_pred)
p = (1 - k) * p_pred
estimate.append(x)
result_99 = pd.DataFrame(
{
"day": days,
"sensor": sensor,
"estimated_health": estimate,
"true_health_for_validation": true_health,
}
)
display(result_99.tail().round(2))

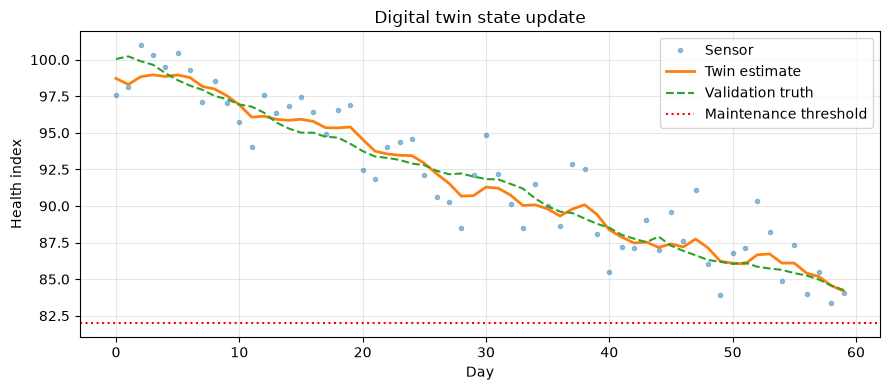

fig, ax = plt.subplots(figsize=(9, 4))
ax.plot(days, sensor, ".", alpha=0.45, label="Sensor")
ax.plot(days, estimate, label="Twin estimate", linewidth=2)
ax.plot(days, true_health, "--", label="Validation truth")
ax.axhline(82, color="red", linestyle=":", label="Maintenance threshold")
ax.set(title="Digital twin state update", xlabel="Day", ylabel="Health index")
ax.grid(True, alpha=0.3)
ax.legend()
plt.tight_layout()
plt.show()
| day | sensor | estimated_health | true_health_for_validation | |
|---|---|---|---|---|
| 55 | 55 | 87.34 | 86.10 | 85.41 |
| 56 | 56 | 83.99 | 85.41 | 85.25 |
| 57 | 57 | 85.49 | 85.17 | 84.97 |
| 58 | 58 | 83.38 | 84.55 | 84.56 |
| 59 | 59 | 84.04 | 84.19 | 84.26 |

Interpreting the results
Using state estimates that are more stable than raw values reduces false alarms near thresholds and allows for earlier consideration of maintenance schedules. In practice, we manage sensor time, calibration, missing measurements, and equipment modification history, and instead of automatically stopping based on estimates, we establish approval flows based on importance.
No.100: Manufacturing Version of Palantir’s Simulation Platform
Practical context / Modeling approach
Finally, we integrate individual models into common business objects and decision-making. Here, the “manufacturing version of Palantir” does not refer to imitation of specific products, but rather to a metaphor for the platform that connects orders, items, equipment, inventory, and suppliers, allowing for tracking scenarios, grounds, approvals, and performance.
The example links inputs and results by scenario_id and supports repeatable evaluation with a fixed seed. Shipments cannot exceed demand; available supply is disruption-adjusted production capacity plus opening stock. expected_value_kJPY is a first-year contribution measure after investment and stock costs, not a multiyear NPV. Approval and actual-performance histories are not implemented.
Python example
scenario_catalog = pd.DataFrame(
[
["S-BASE", "Baseline", 1.00, 930, 150, "single", 0],
["S-RES", "Resilient", 1.08, 970, 220, "dual", 12_000],
["S-GROW", "Growth", 1.18, 1050, 190, "dual", 180_000],
],
columns=[
"scenario_id",
"name",
"demand_factor",
"capacity",
"safety_stock",
"sourcing",
"investment_kJPY",
],
)
def evaluate(row, reps=2000, seed=SEED + 100):
local_rng = np.random.default_rng(seed)
annual_demand = np.maximum(
0, local_rng.normal(10200 * row.demand_factor, 1050, reps)
)
annual_capacity = np.maximum(0, local_rng.normal(row.capacity * 12, 420, reps))
disruption = local_rng.random(reps) < (0.025 if row.sourcing == "dual" else 0.08)
available = annual_capacity * np.where(disruption, 0.94, 1.0) + row.safety_stock
shipped = np.minimum(annual_demand, available)
service = np.divide(
shipped, annual_demand, out=np.ones(reps), where=annual_demand > 0
)
value = shipped * 31 - row.investment_kJPY - row.safety_stock * 0.8
return pd.Series(
{
"expected_value_kJPY": value.mean(),
"P(service>=98%)": (service >= 0.98).mean(),
"P(capacity_shortage)": (annual_demand > annual_capacity).mean(),
}
)
result_100 = pd.concat(
[scenario_catalog, scenario_catalog.apply(evaluate, axis=1)], axis=1
)
display(result_100.round(3))
fig, ax = plt.subplots(figsize=(8, 4))

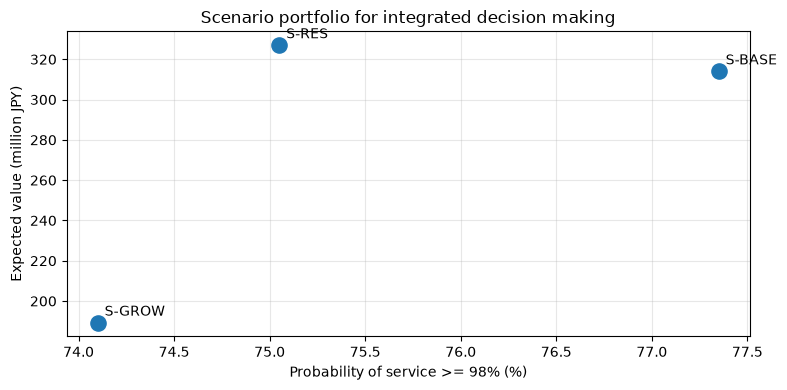

ax.scatter(
result_100["P(service>=98%)"] * 100, result_100["expected_value_kJPY"] / 1000, s=120
)
for _, r0 in result_100.iterrows():
ax.annotate(
r0["scenario_id"],
(r0["P(service>=98%)"] * 100, r0["expected_value_kJPY"] / 1000),
xytext=(5, 5),
textcoords="offset points",
)
ax.set(
title="Scenario portfolio for integrated decision making",
xlabel="Probability of service >= 98% (%)",
ylabel="Expected value (million JPY)",
)
ax.grid(True, alpha=0.3)
plt.tight_layout()
plt.show()
| scenario_id | name | demand_factor | capacity | safety_stock | sourcing | investment_kJPY | expected_value_kJPY | P(service>=98%) | P(capacity_shortage) | |
|---|---|---|---|---|---|---|---|---|---|---|
| 0 | S-BASE | Baseline | 1.00 | 930 | 150 | single | 0 | 313,143.04 | 0.87 | 0.20 |
| 1 | S-RES | Resilient | 1.08 | 970 | 220 | dual | 12000 | 325,085.39 | 0.83 | 0.30 |
| 2 | S-GROW | Growth | 1.18 | 1050 | 190 | dual | 180000 | 188,013.31 | 0.81 | 0.32 |

Interpreting the results
The value of the integrated platform lies not in providing a single optimal solution, but in being able to track performance by making judgments based on inputs, models, and approvals. The implementation sequence is to define management issues and decision-making cycles, establish common IDs and KPIs, and start with small-scale scenario comparisons.
Practical takeaways
- Determined by distribution, not average: Looking at out-of-stock probability, the 95th percentile of cost, and NPV positive probability, you can see hidden vulnerabilities in average cases.
- Avoiding local optimization: If production volume, inventory, personnel, procurement, and capital investment are not evaluated under common scenarios, improvements in one department may result in losses for another.
- Separate constraints from objectives: Safety, quality, and contracted service levels should not be offset by weights but enforced as constraints, and profits and inventory should be compared within that range.
- Designing the decision-making process beyond the model: Operation only begins after deciding the person responsible for input, update frequency, approver, performance verification, and even the conditions for model stoppage.
Preparing for practical use
- Clearly state the subject decision-making, deadlines, changeable levers, and prohibitive conditions
- Standardize common IDs for items, equipment, bases, and suppliers, as well as time, units, and granularity
- Verifying reproducibility with past data and testing extreme scenarios based on on-site knowledge
- Save baselines, model versions, input snapshots, seeds, and approval history
- Decide on the KPI responsible department and alternative operations if predictions are wrong.
- PoC measures not only accuracy but also operational effectiveness such as decision time, out-of-stock losses, and the number of plan changes
Conclusion
From No.091 to No.100, key decisions in factory operations were gradually connected from individual simulations to integrated scenario evaluations. Simulation is not a complete replica of reality. It serves as a “testing ground for decision-making” to share assumptions, quantify uncertainty, and safely compare options. Conducting small-scale verification, learning from differences from actual performance, and continuously updating is the shortcut to leveraging digital twins and integrated infrastructure in the field.
Consultations for Corporations
At Surikobo, we support issue organization, data design, simulation PoC, and implementation and embedding in decision-making platforms, covering production planning, inventory, capital investment, personnel allocation, and supply chain. Starting from existing Excel and on-site rules, you can gradually develop it into an explainable and operable form.
📩 Contact Us: www.surikobo.co.jp/contact
Please feel free to consult us first.
